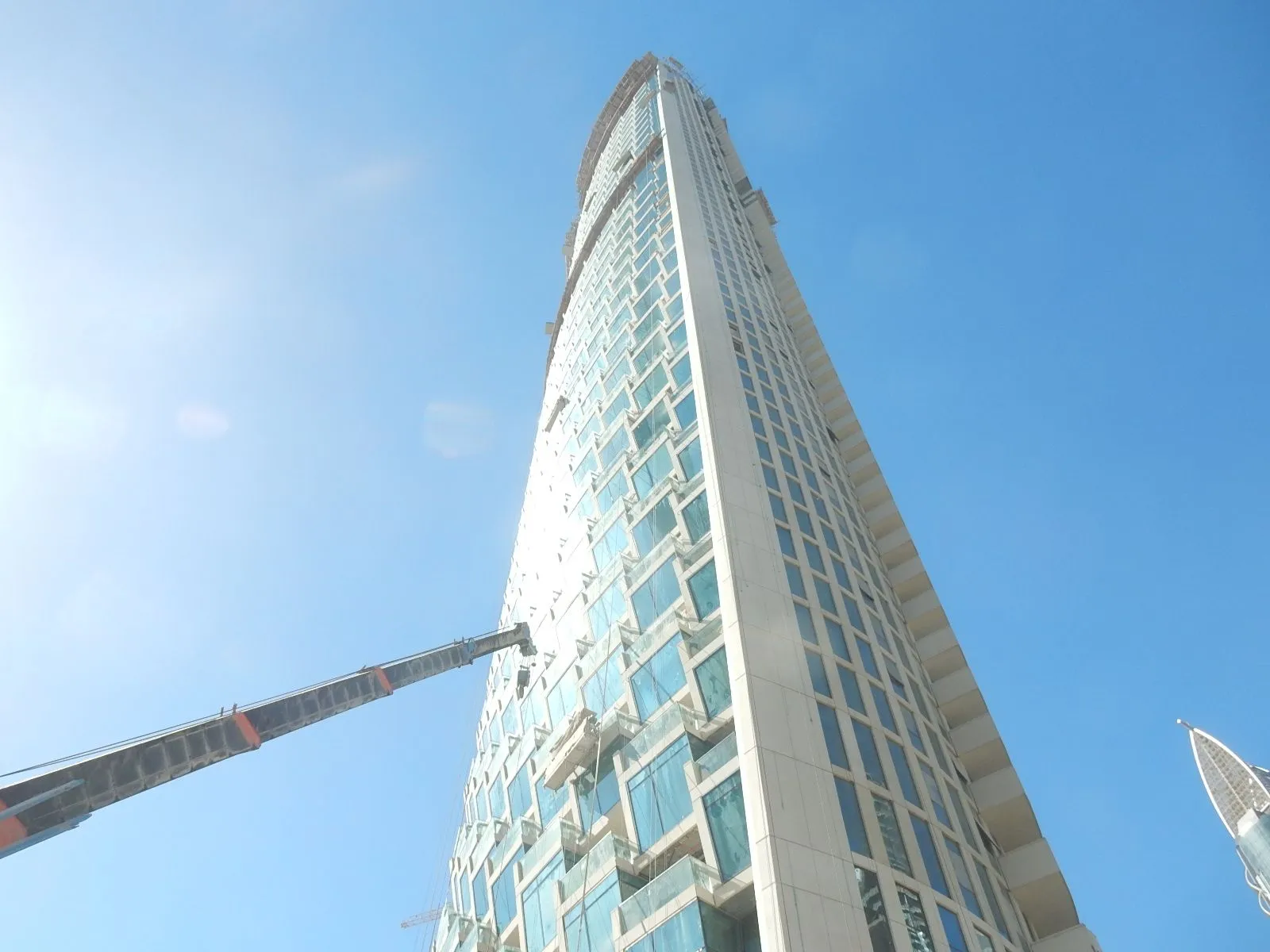

Construction progress of the project «Burj Vista»

Photo report of construction progress of the residential complex Burj Vista at UAE, Dubai, Downtown Dubai, Burj Vista.

Burj Vista

July 12, 2018
Readiness: 100%

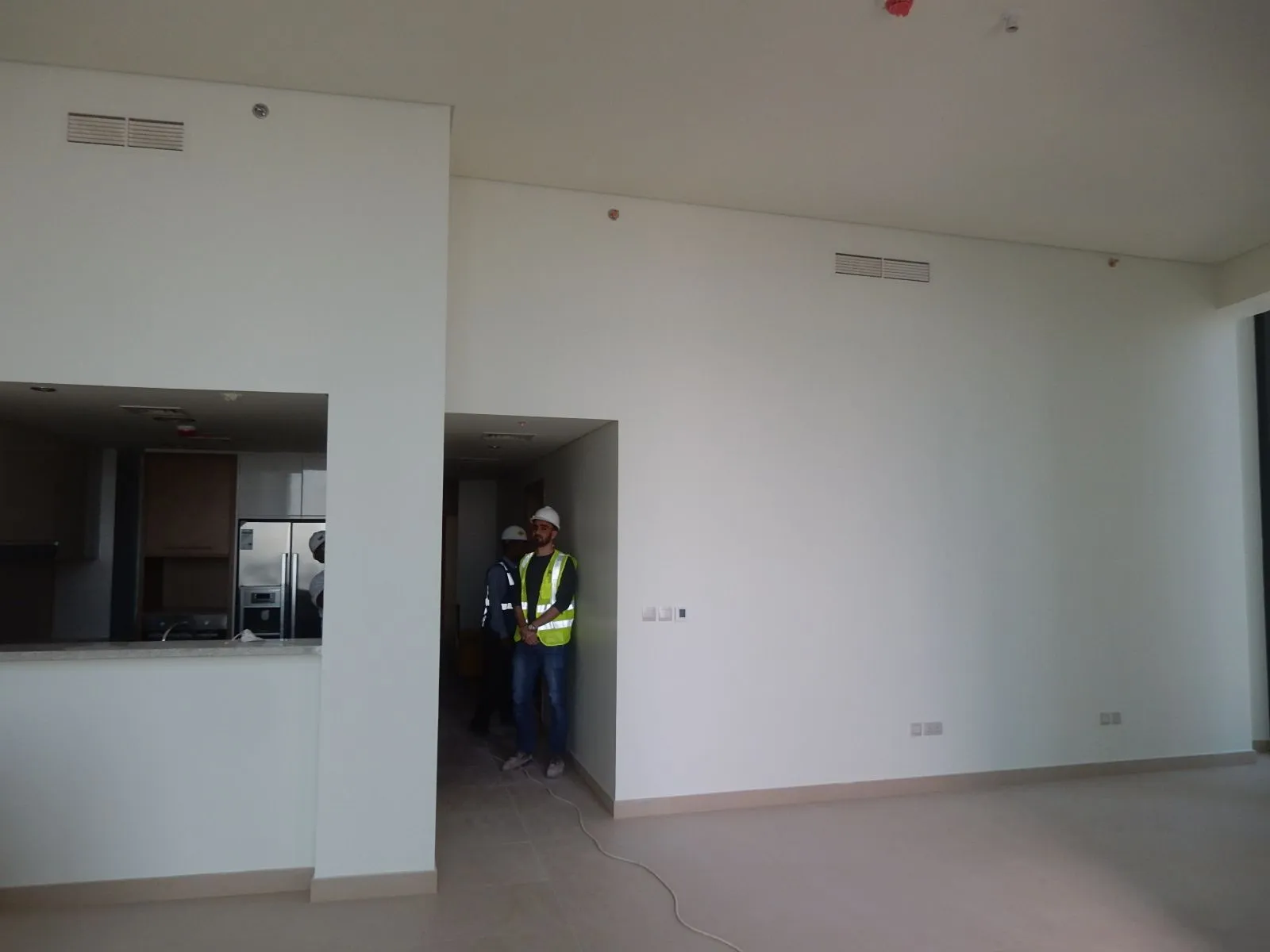

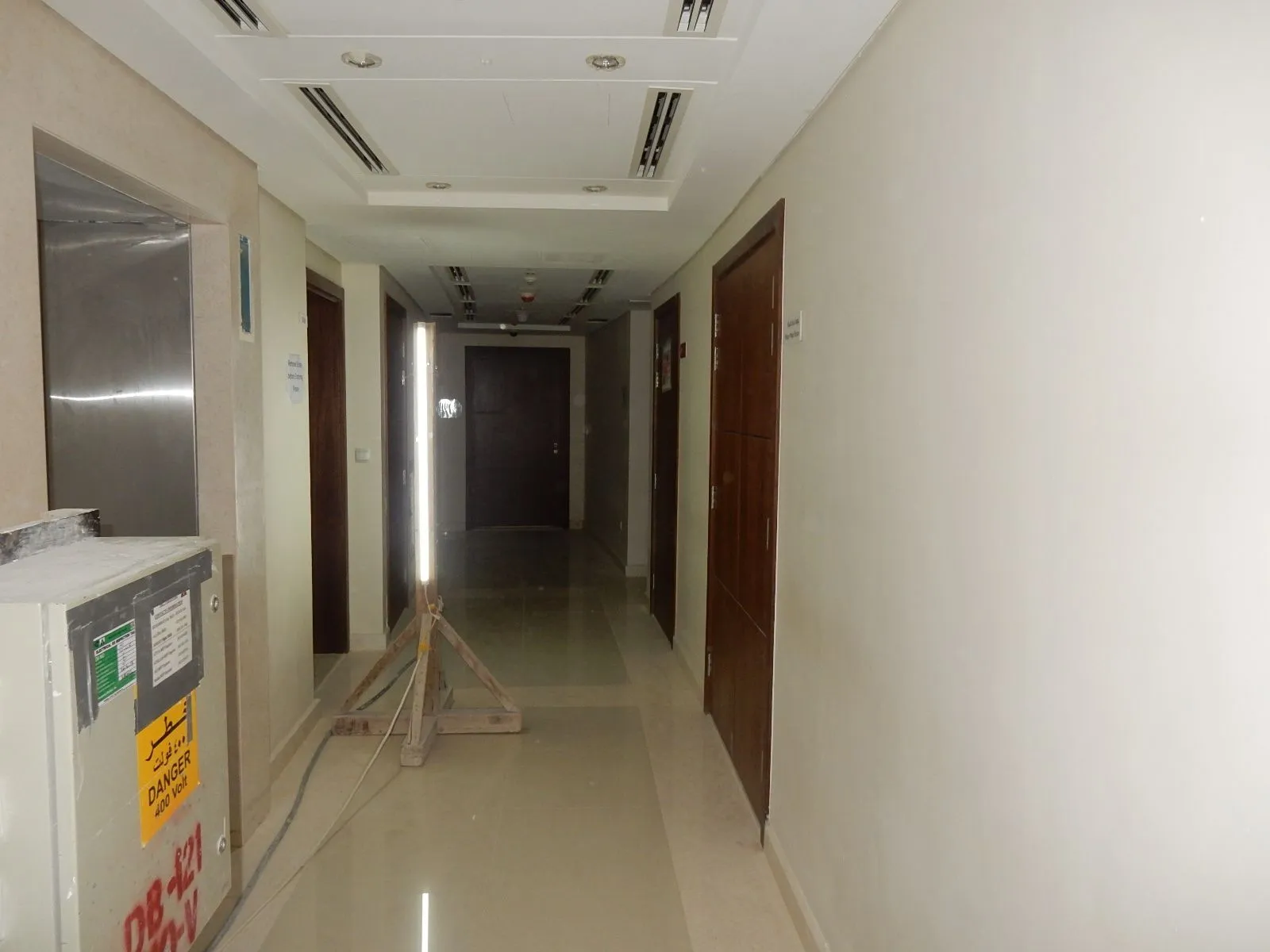

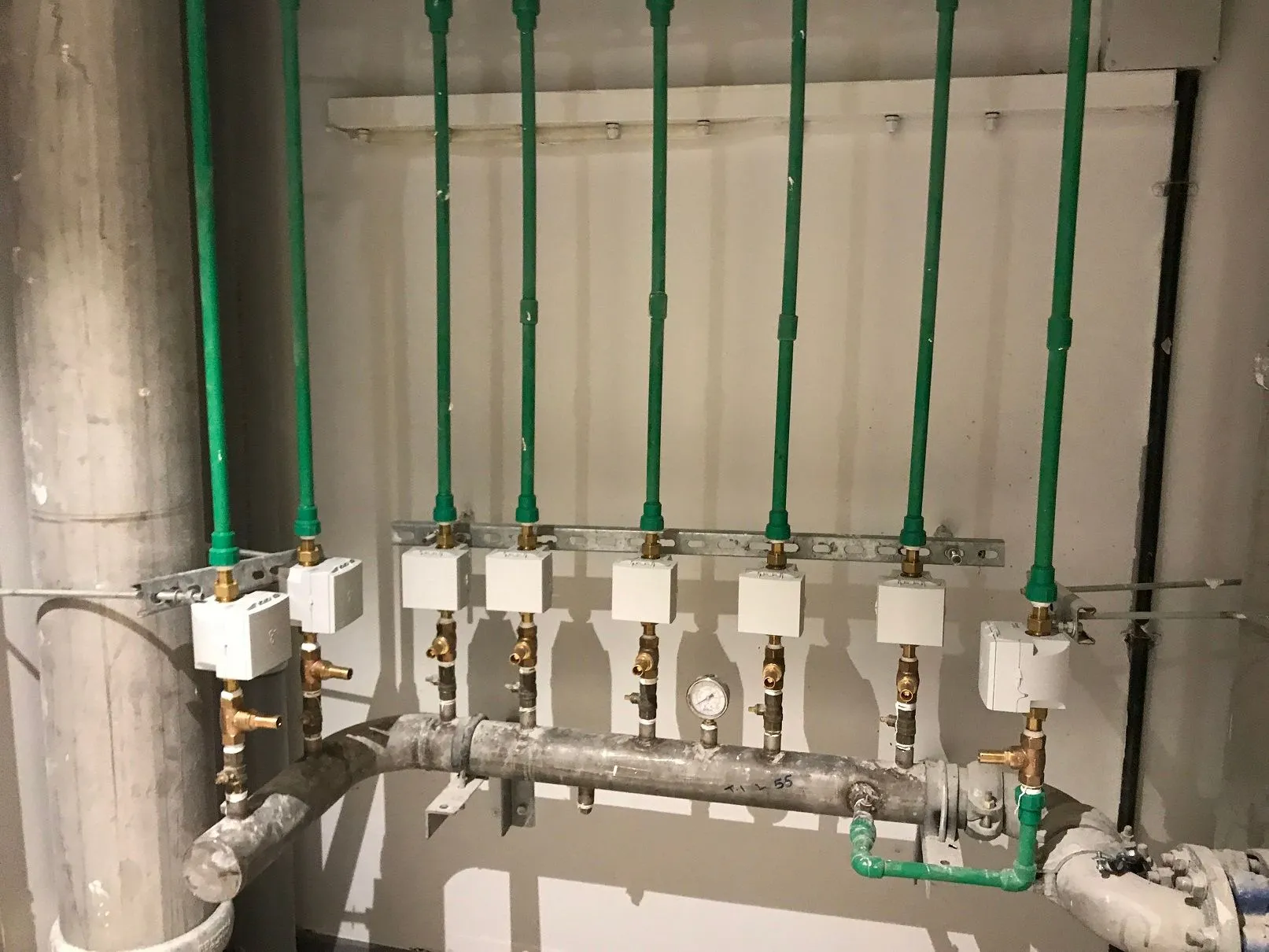

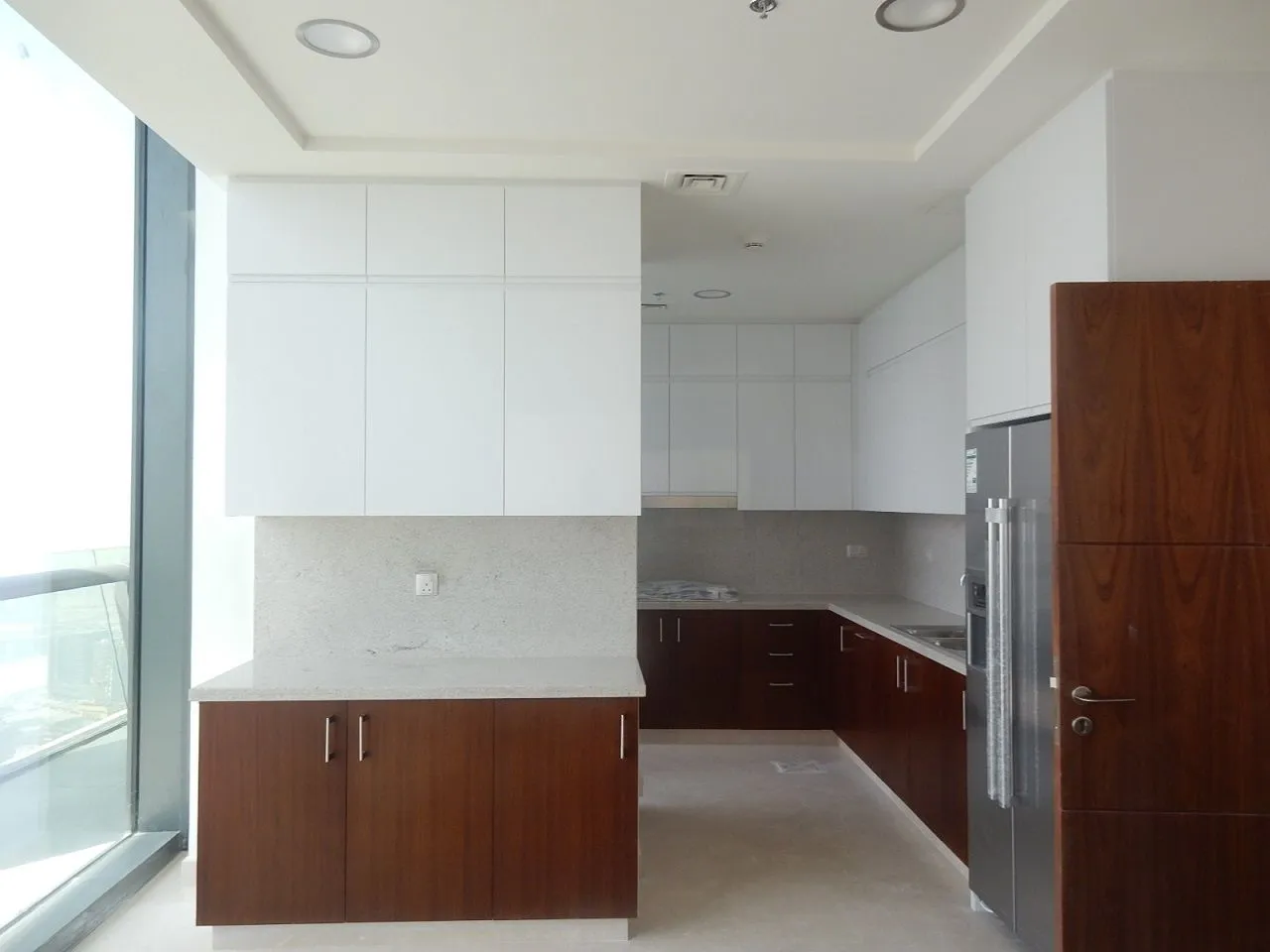

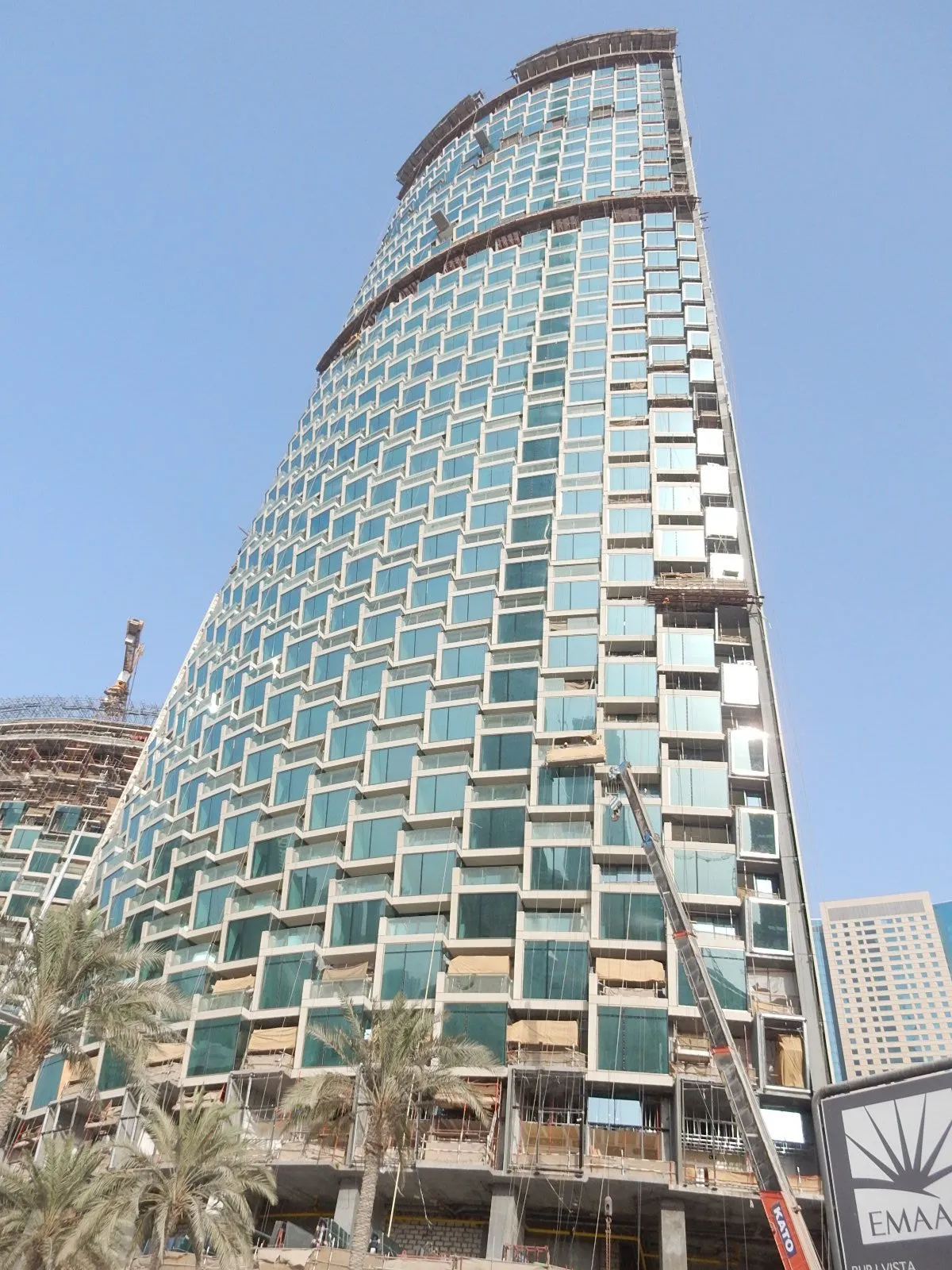

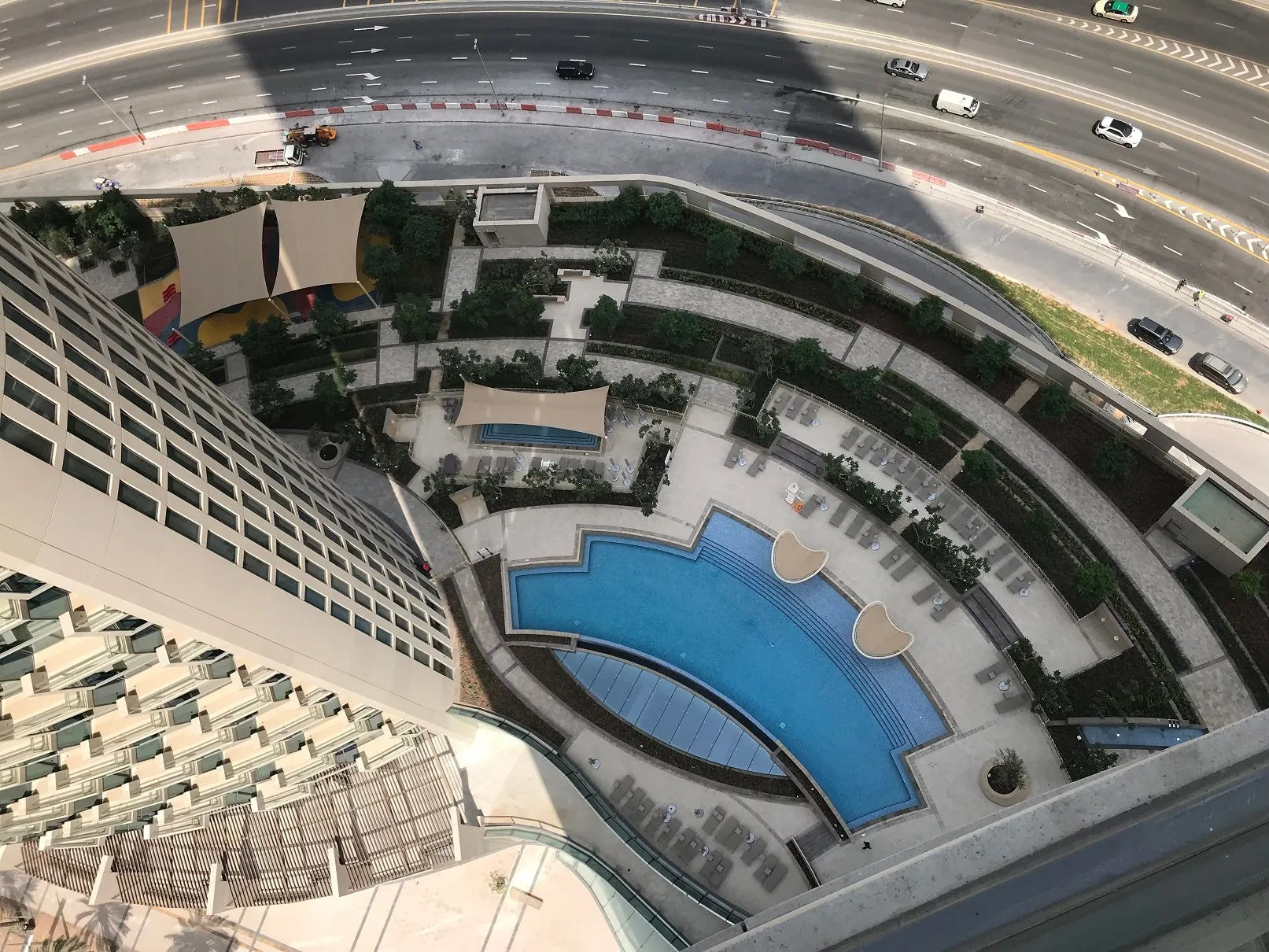

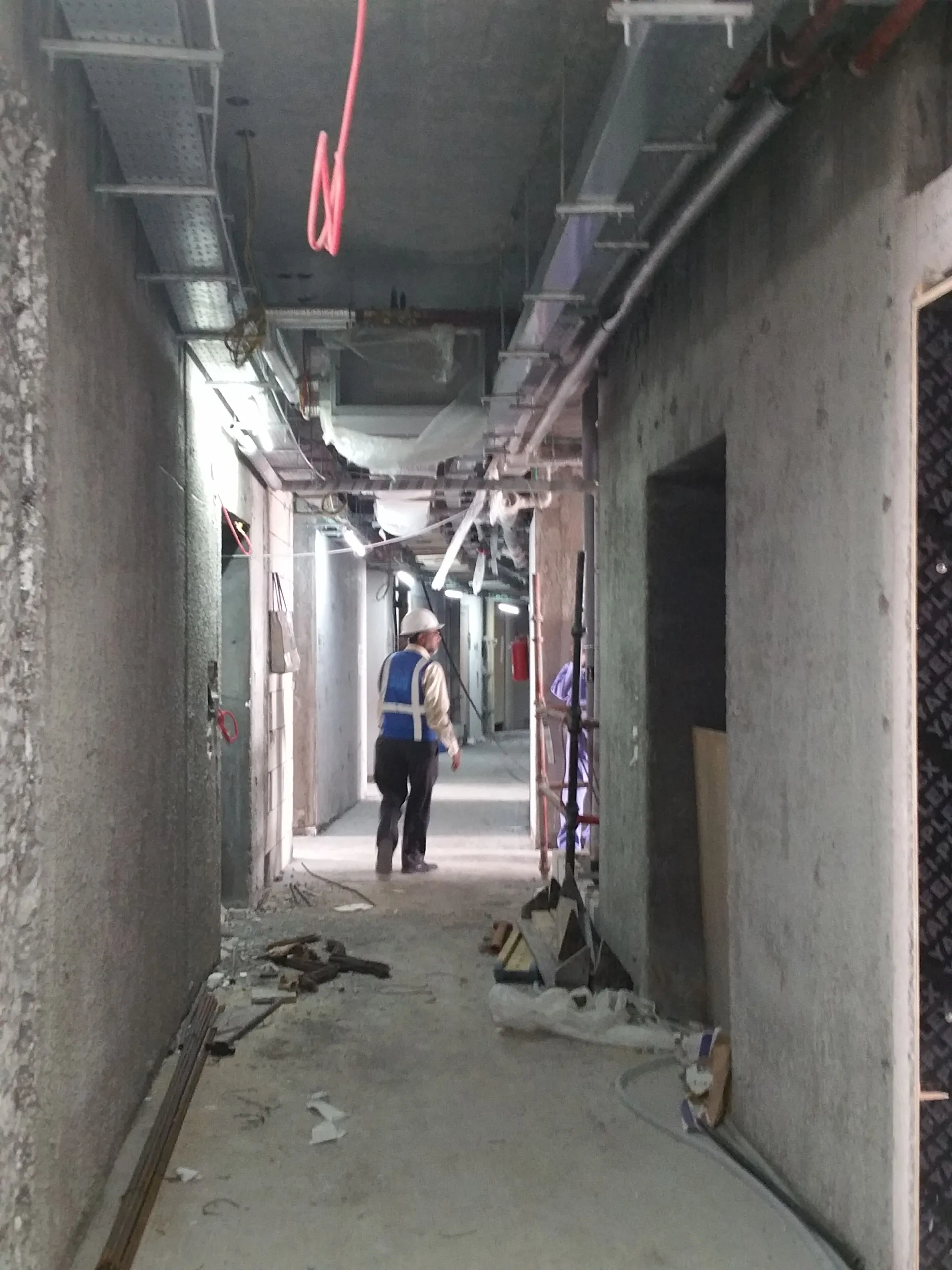

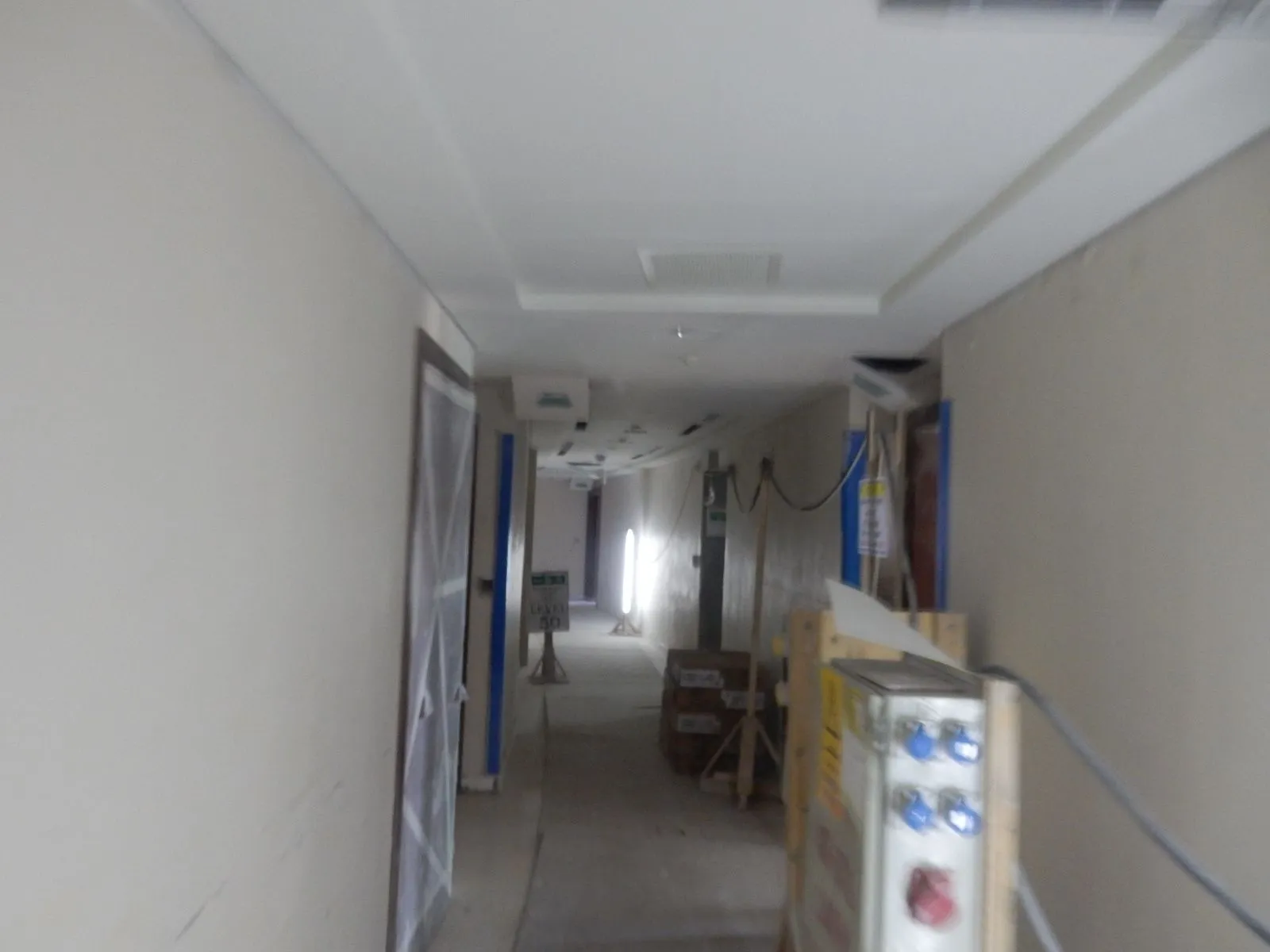

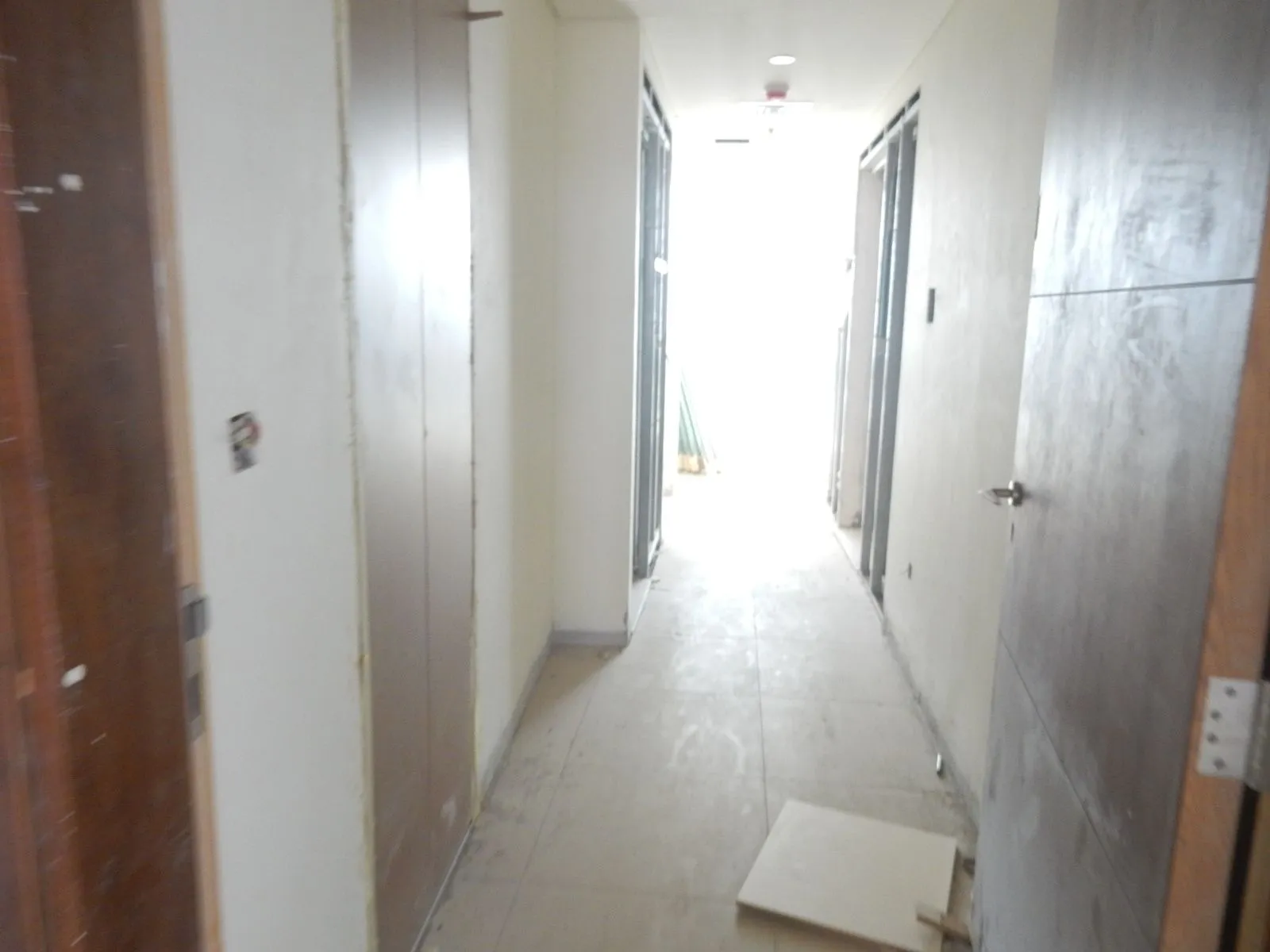

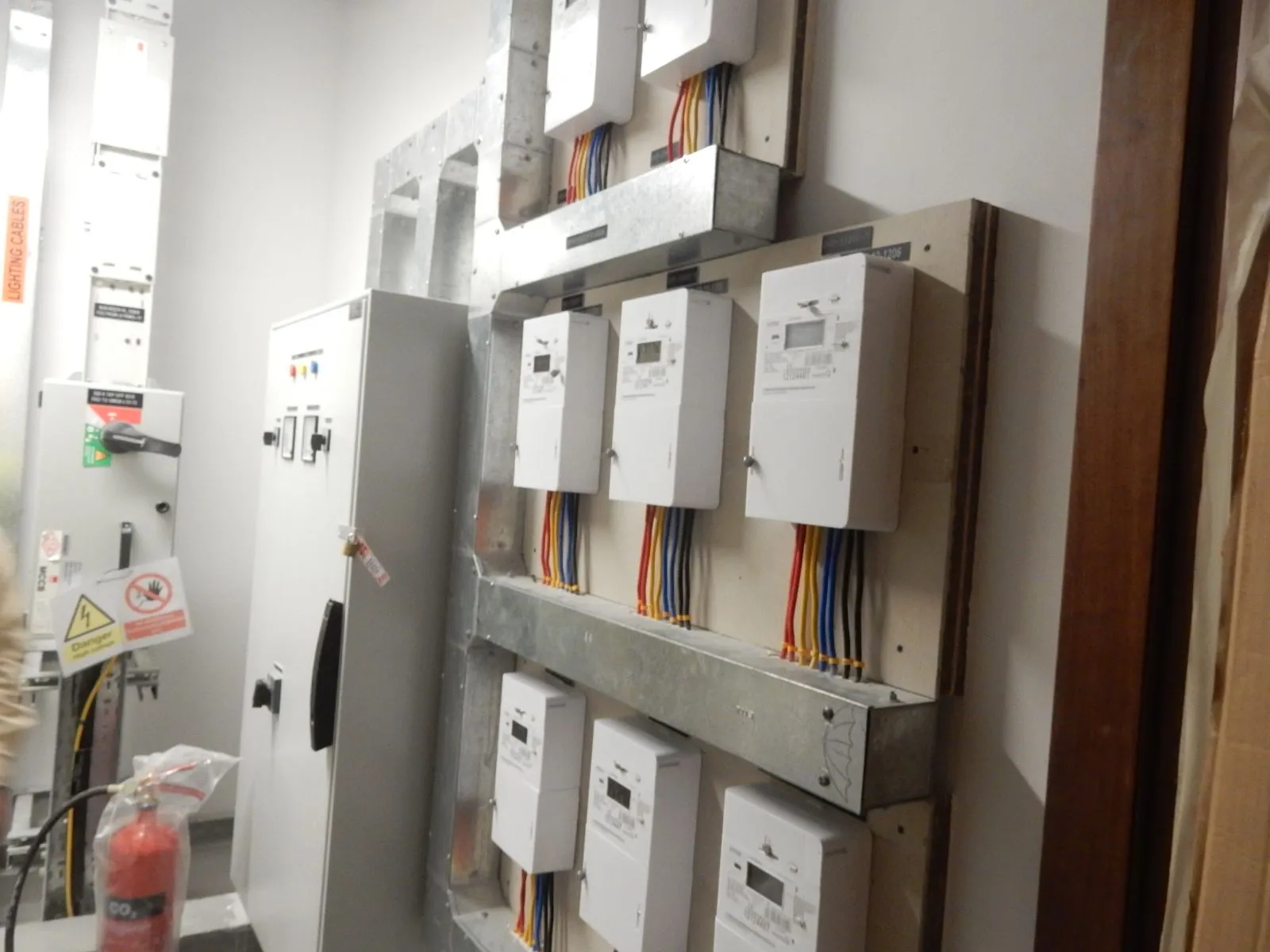

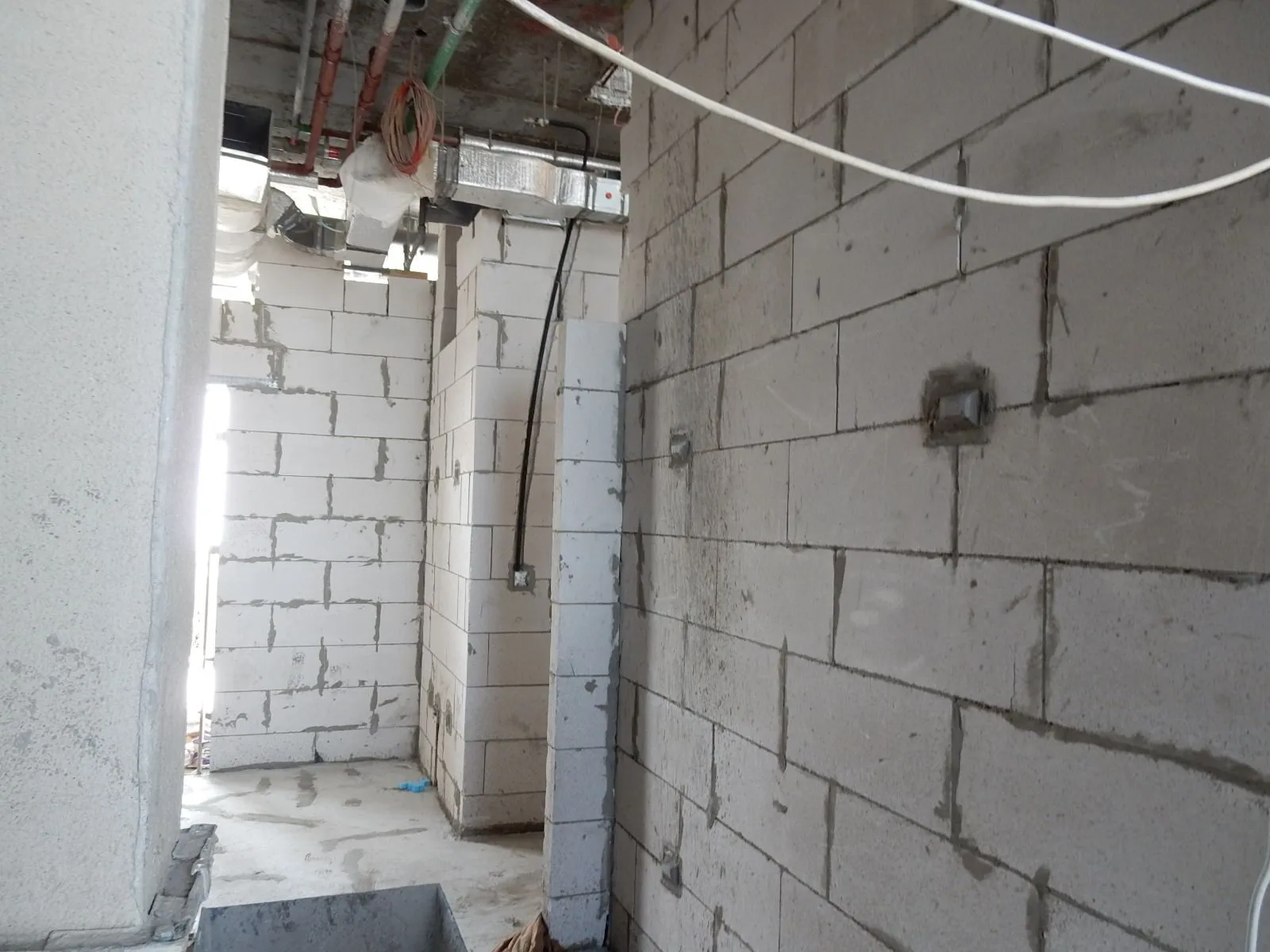

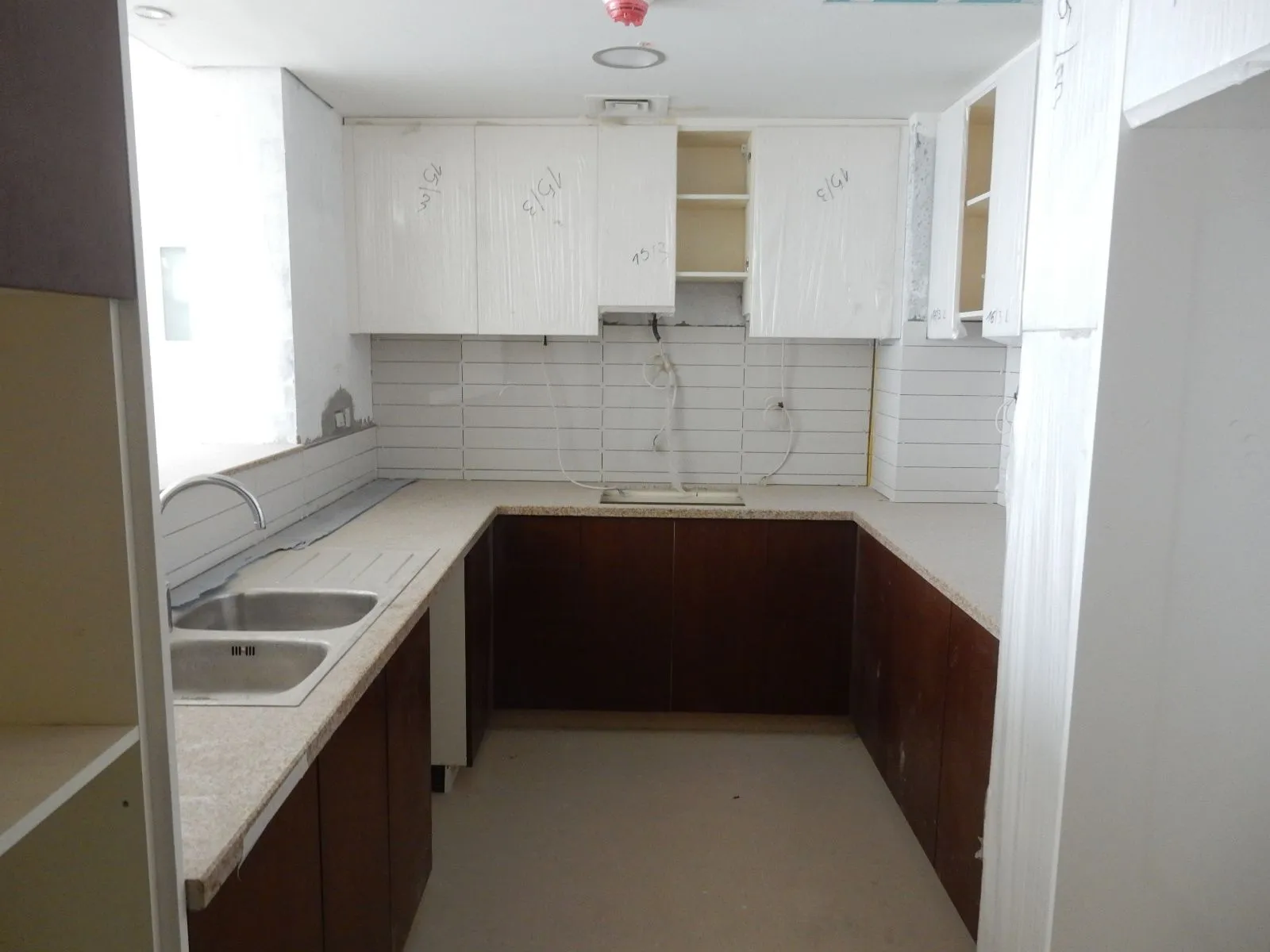

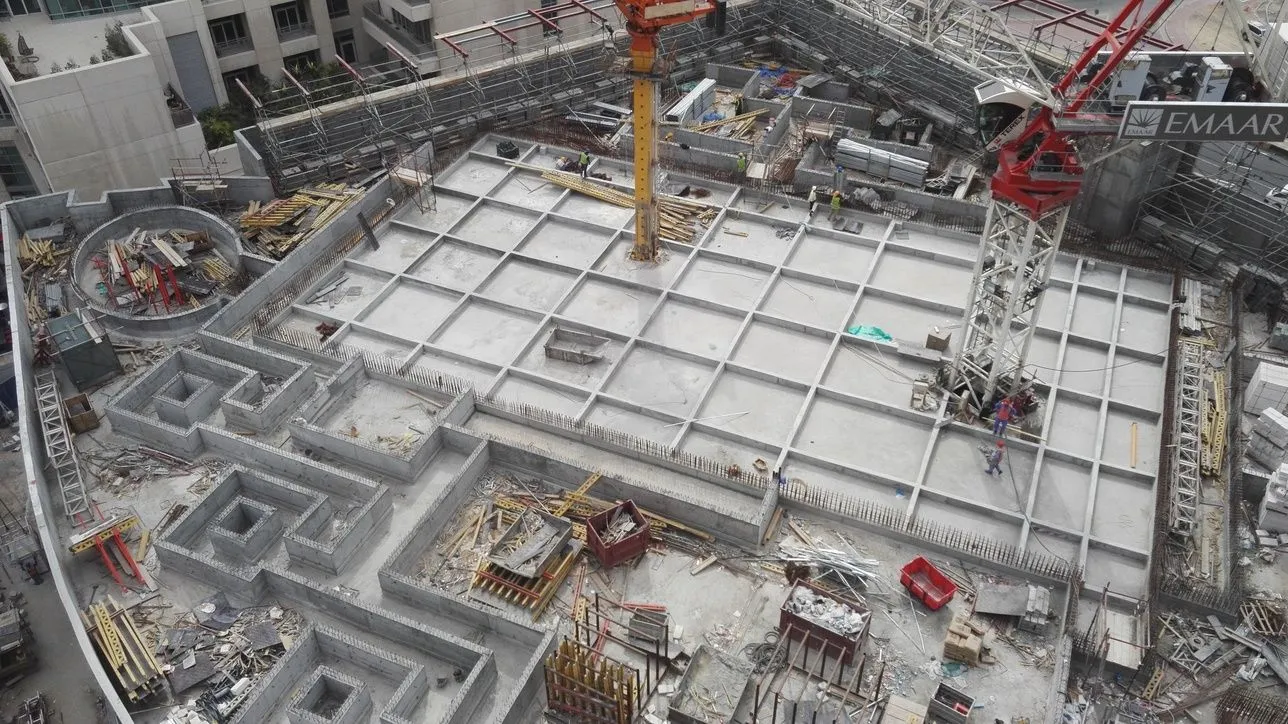

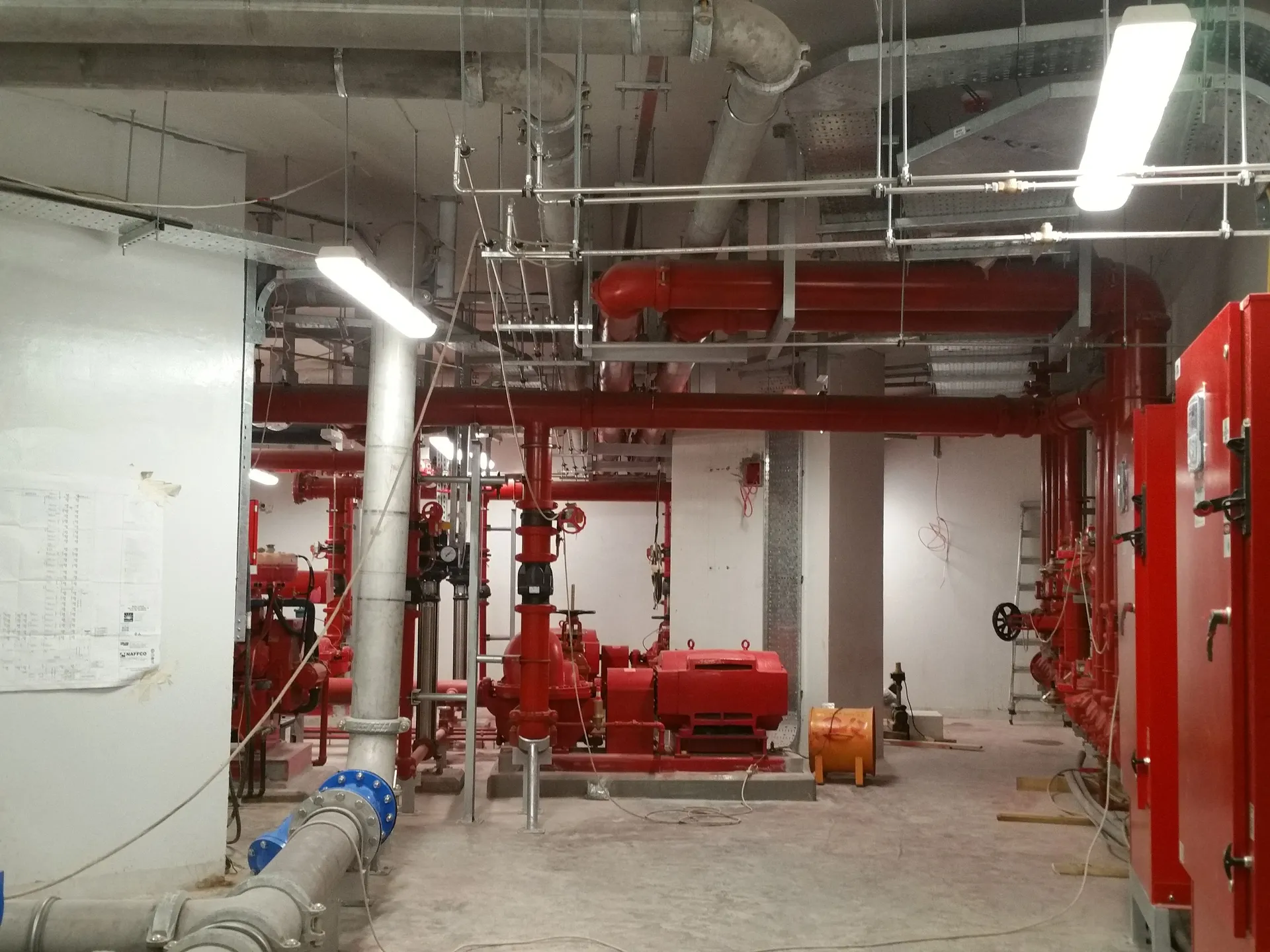

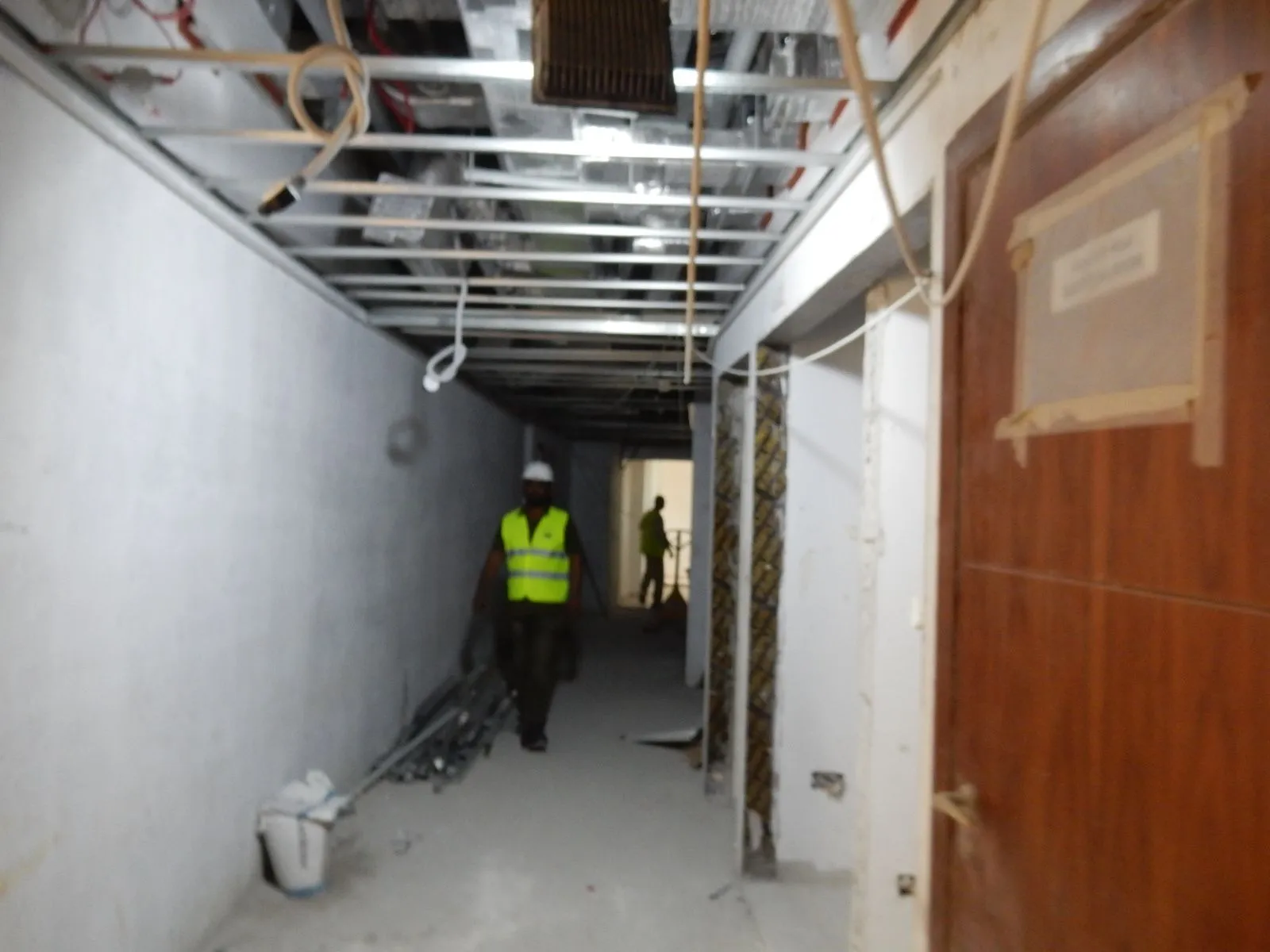

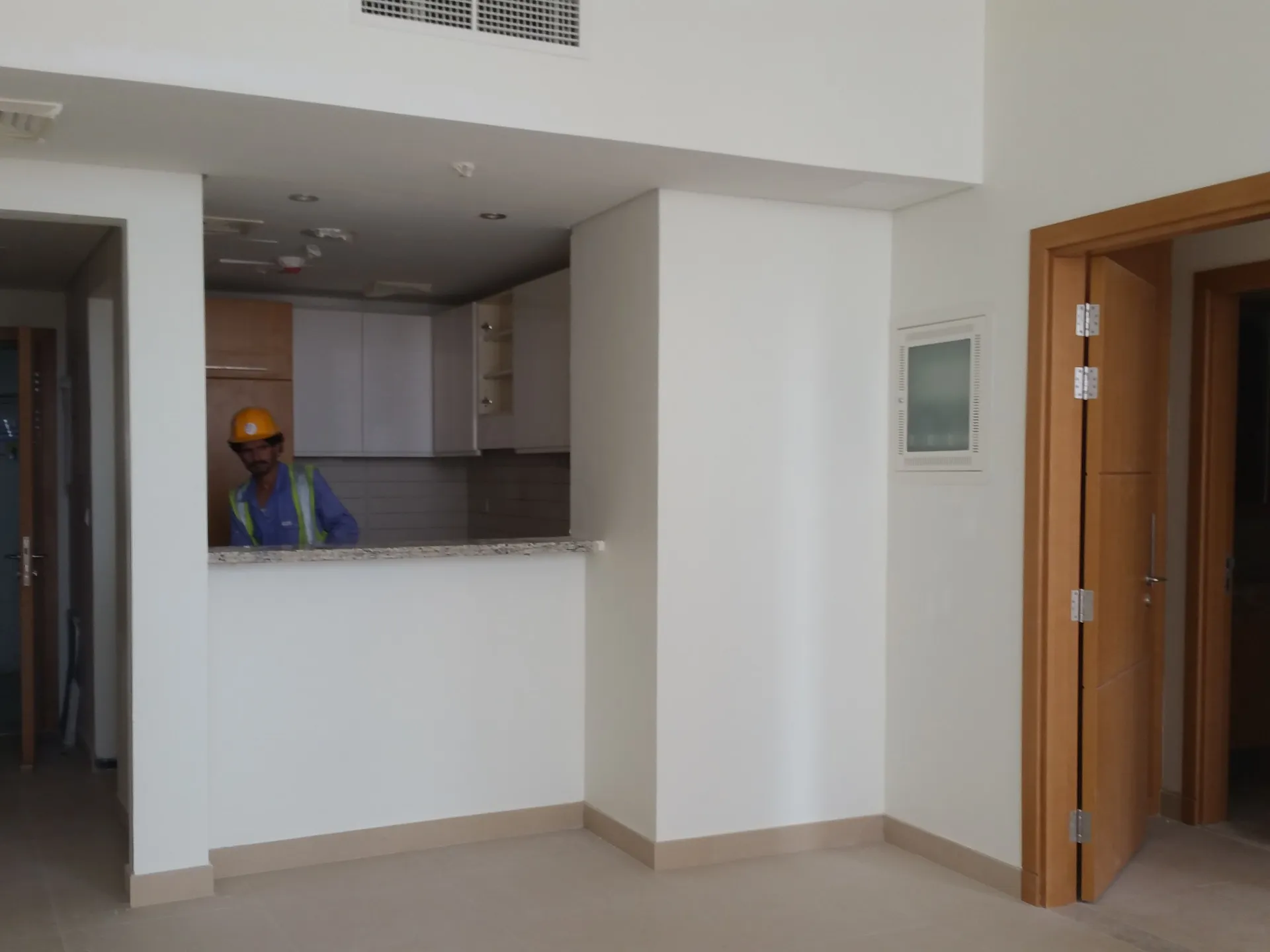

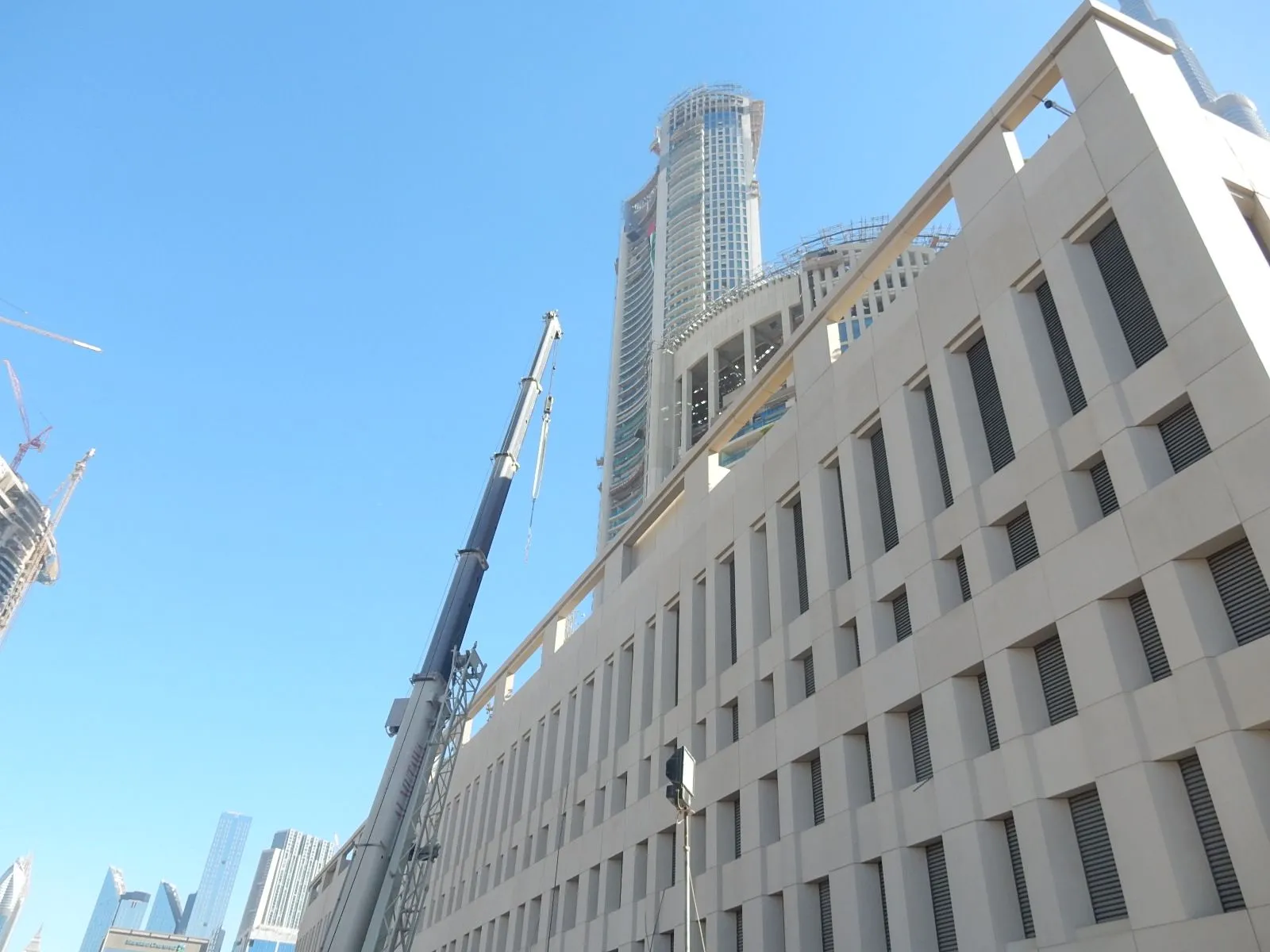

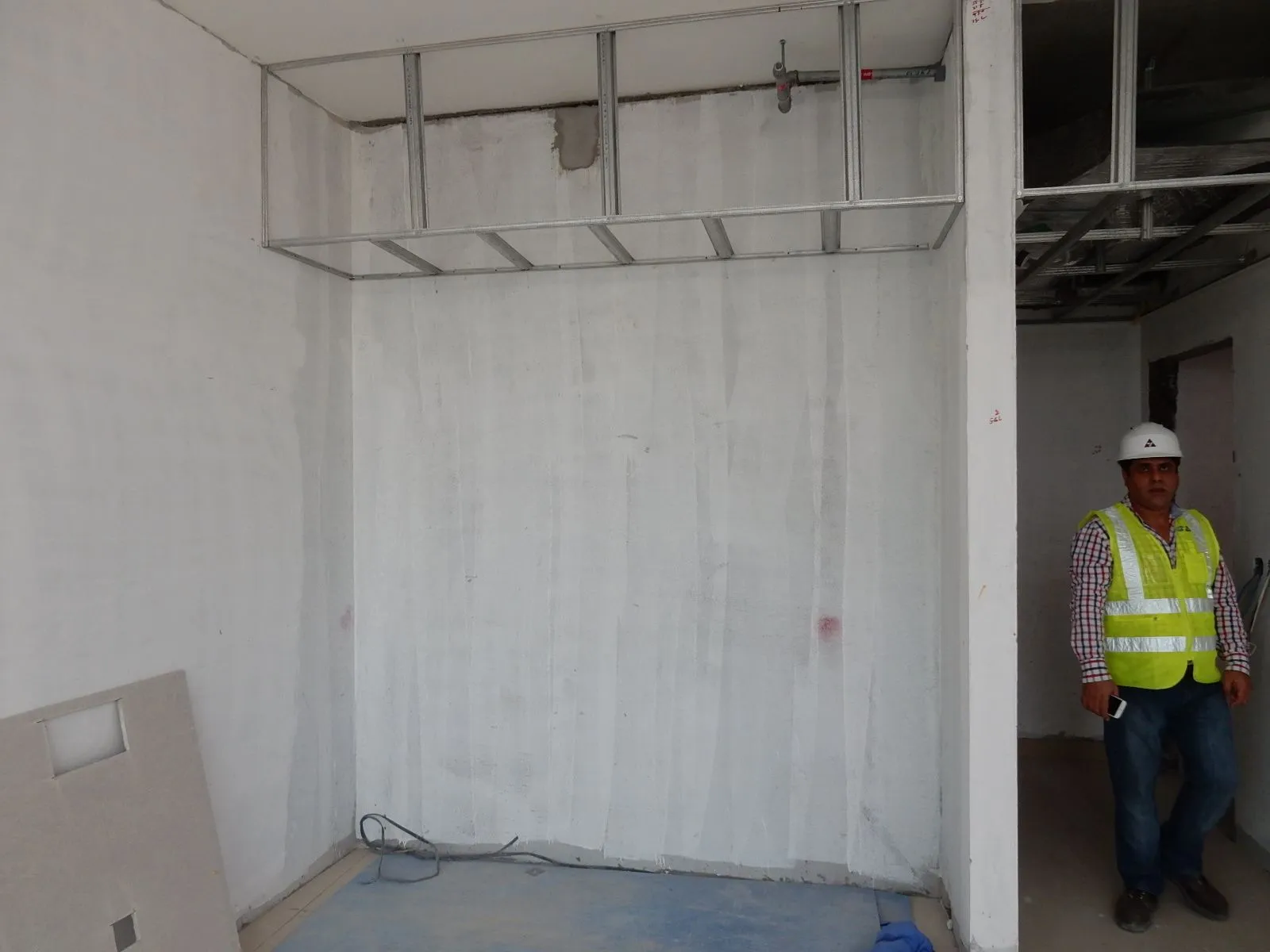

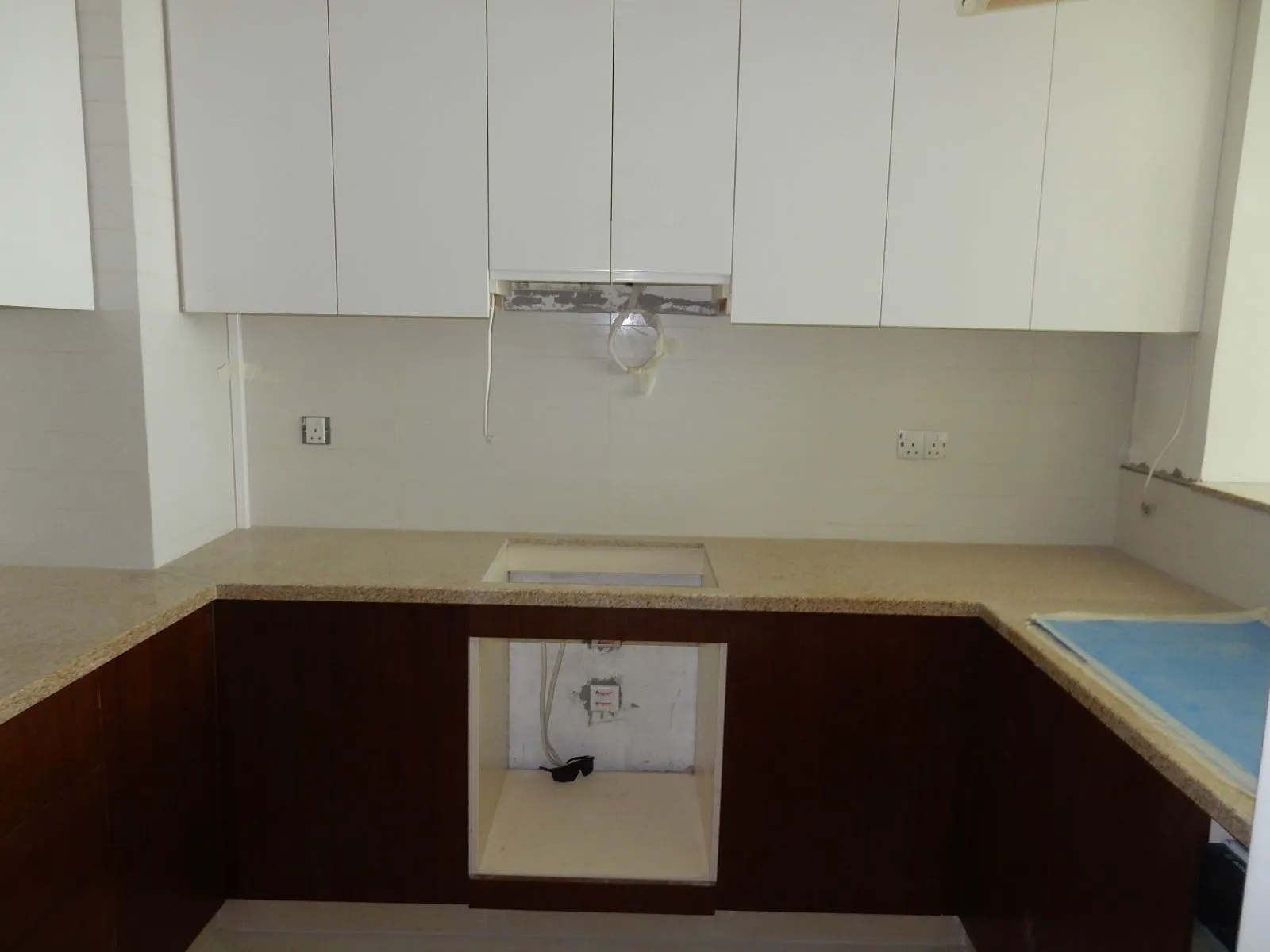

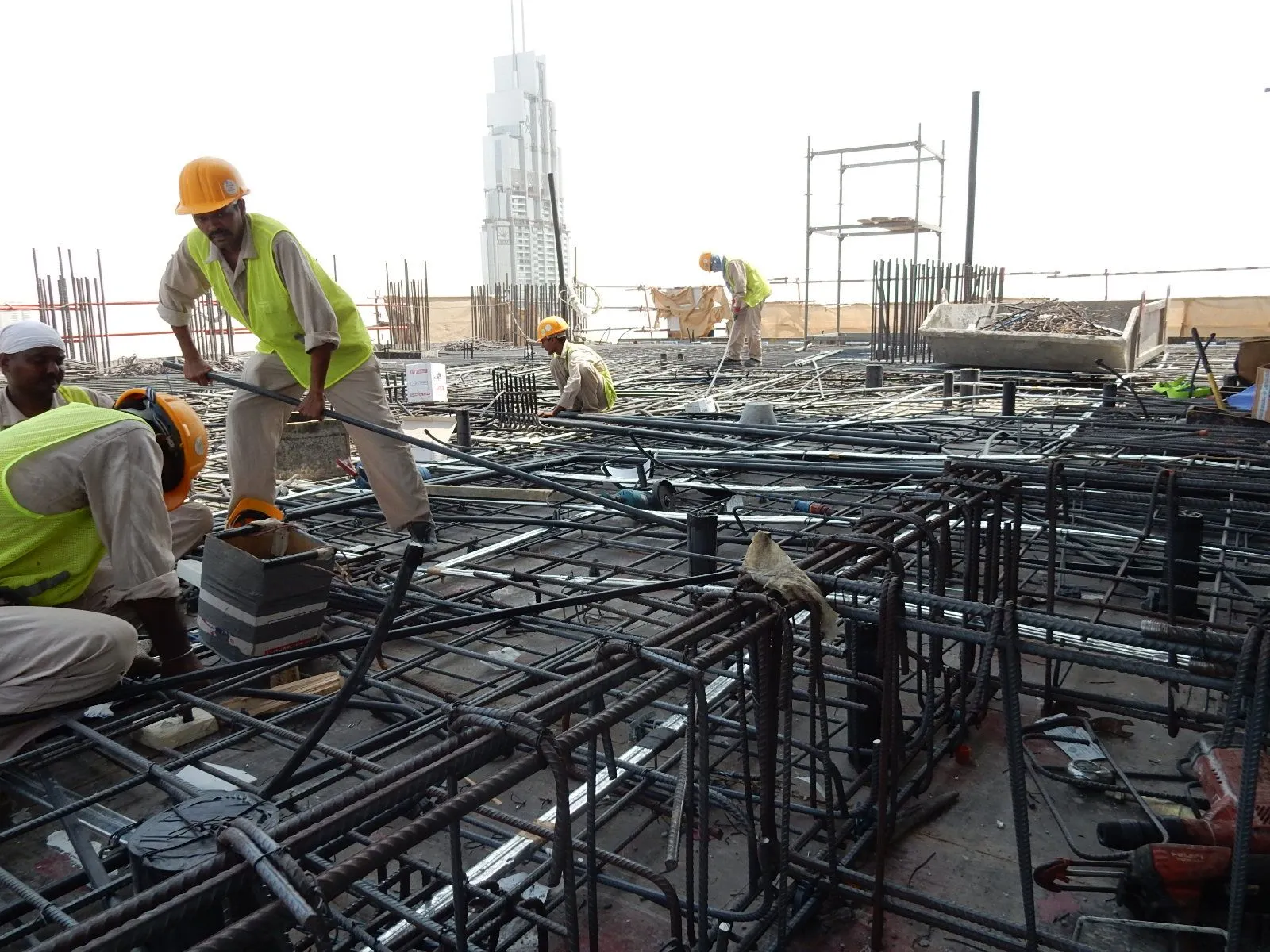

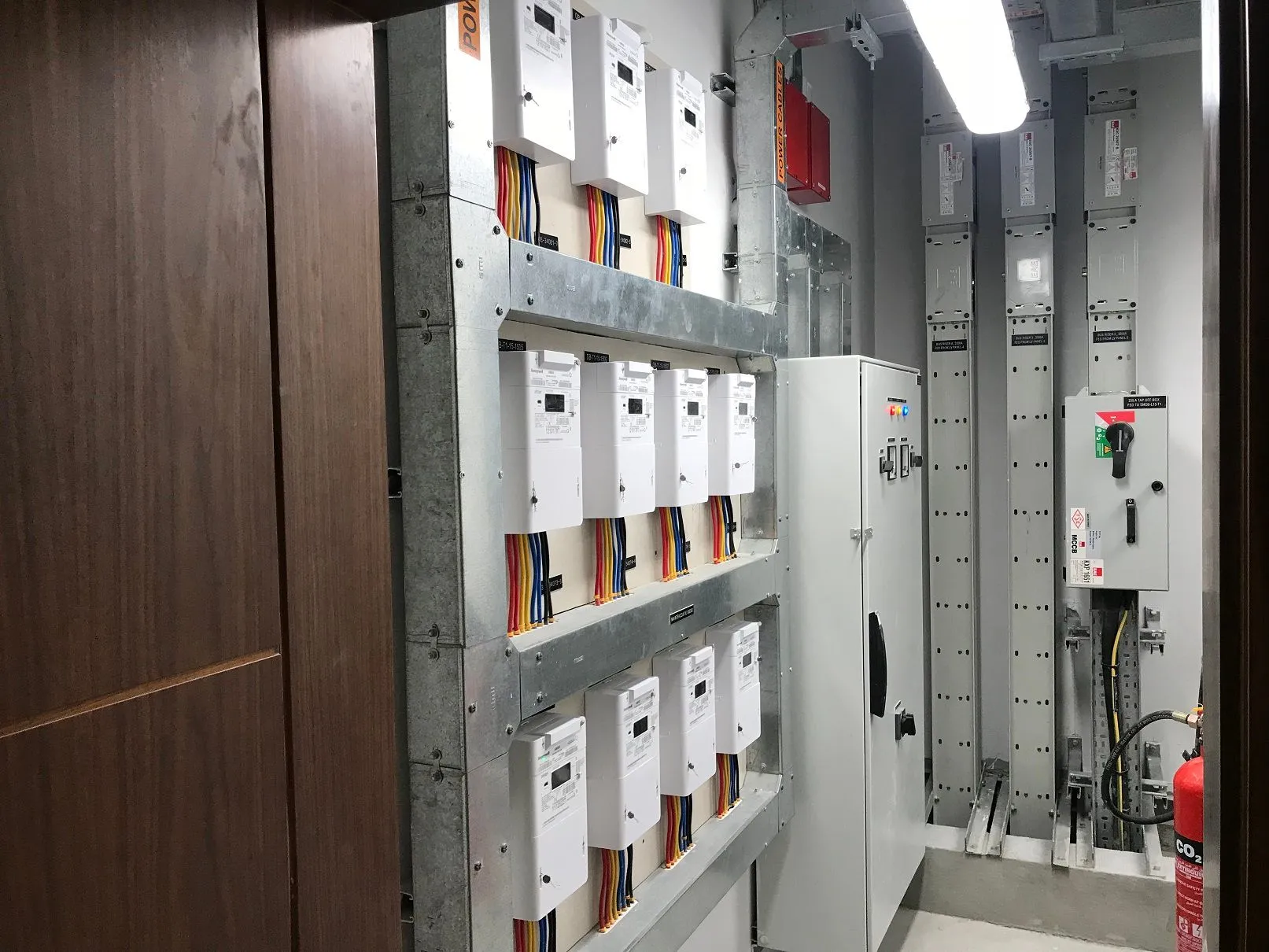

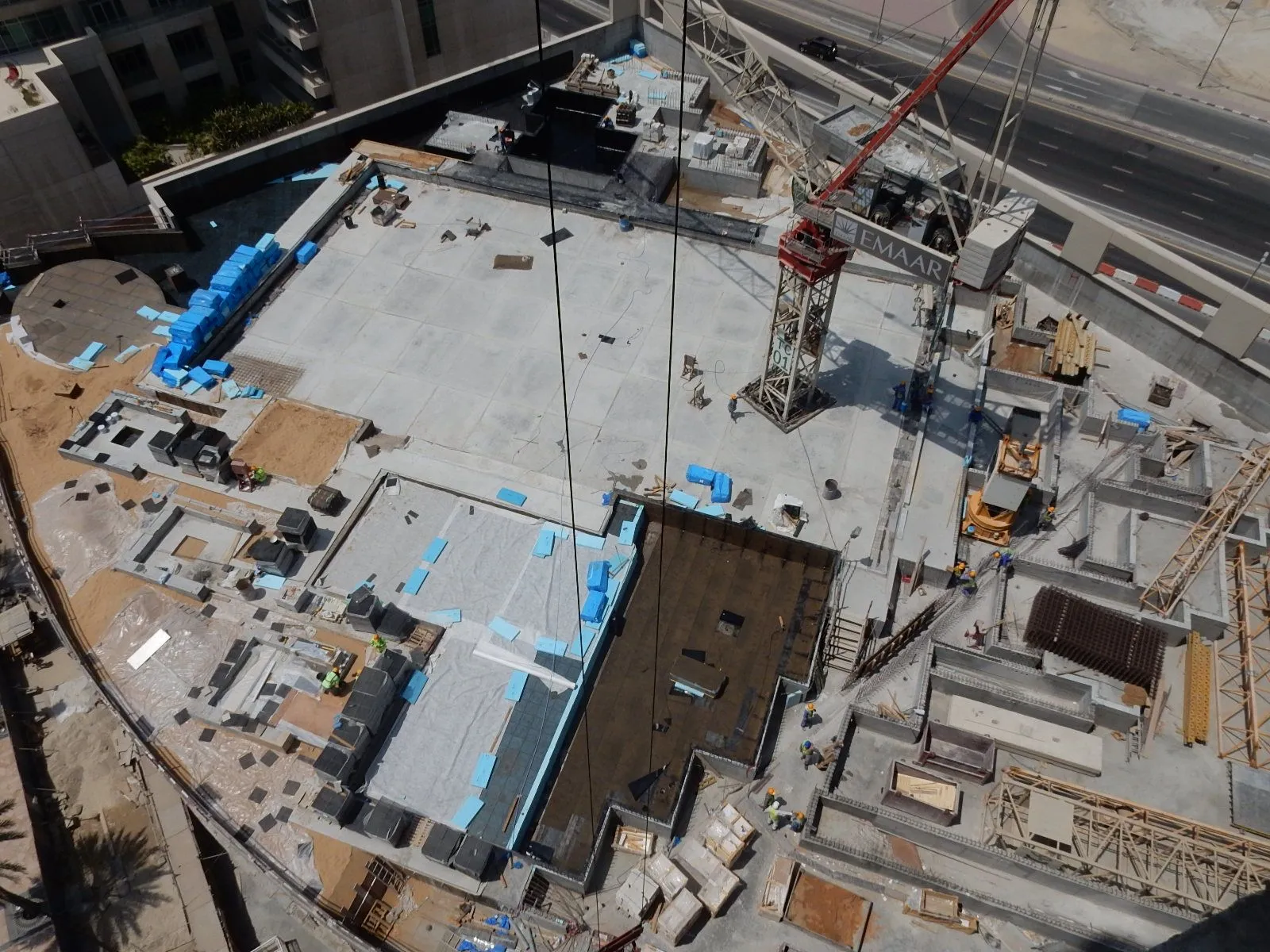

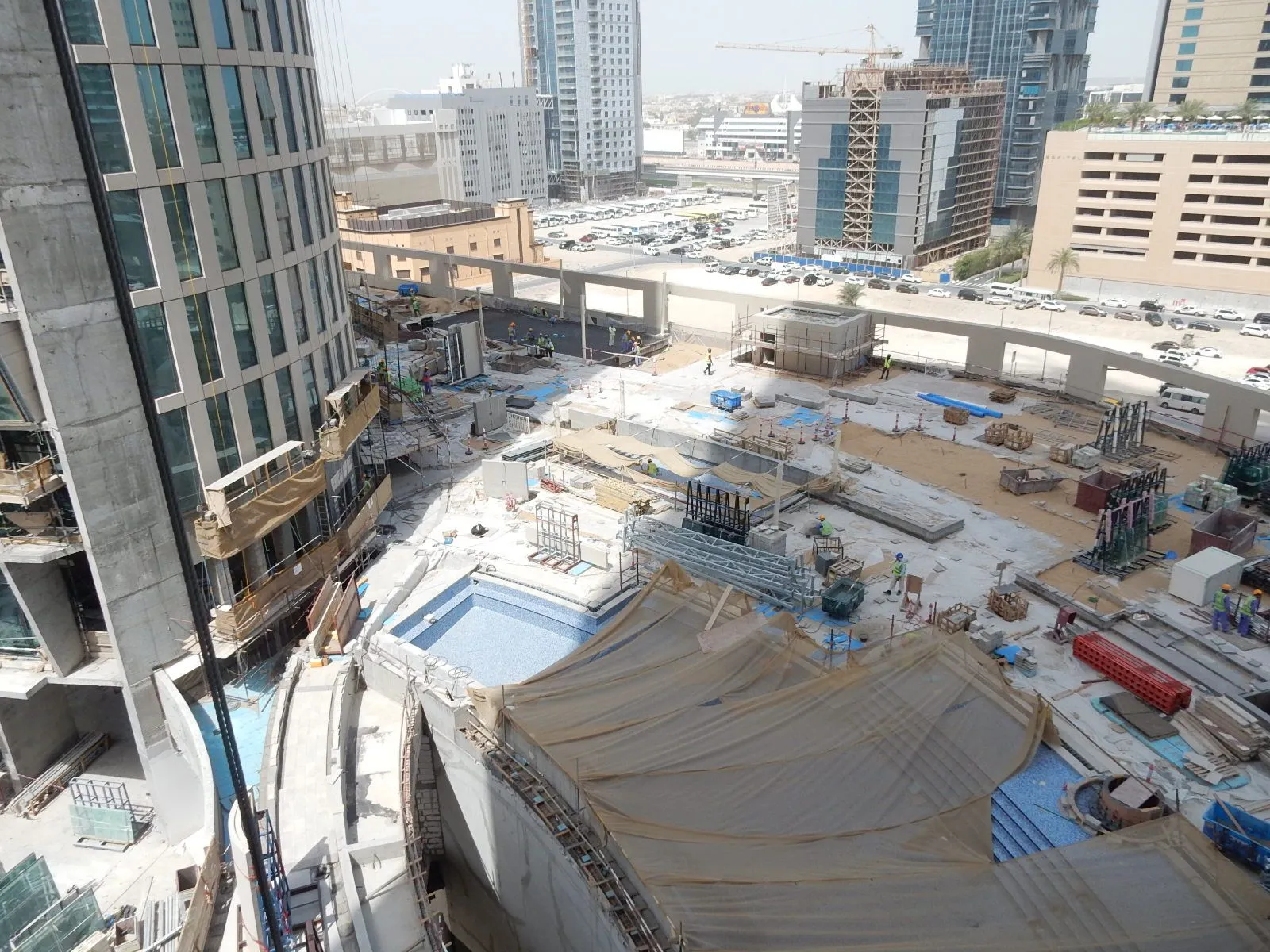

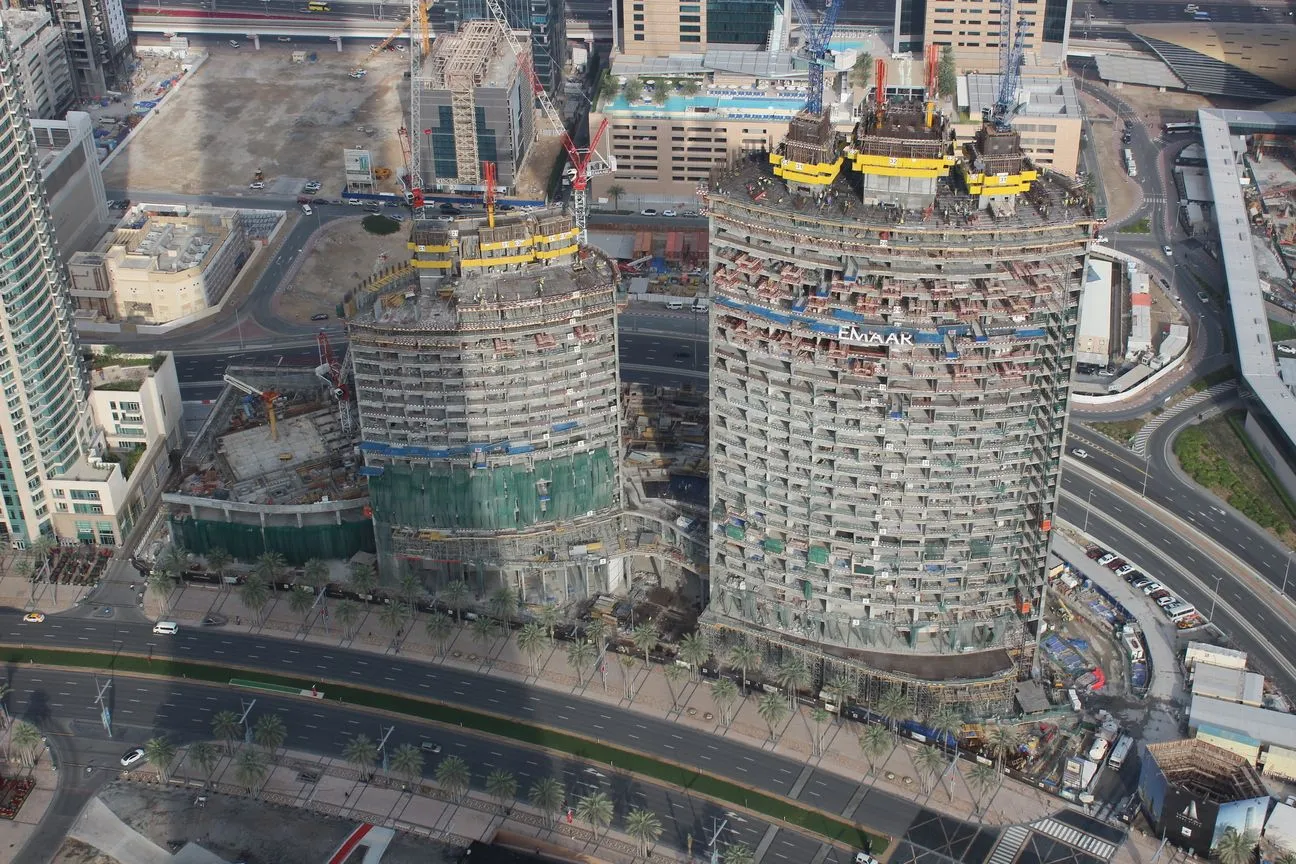

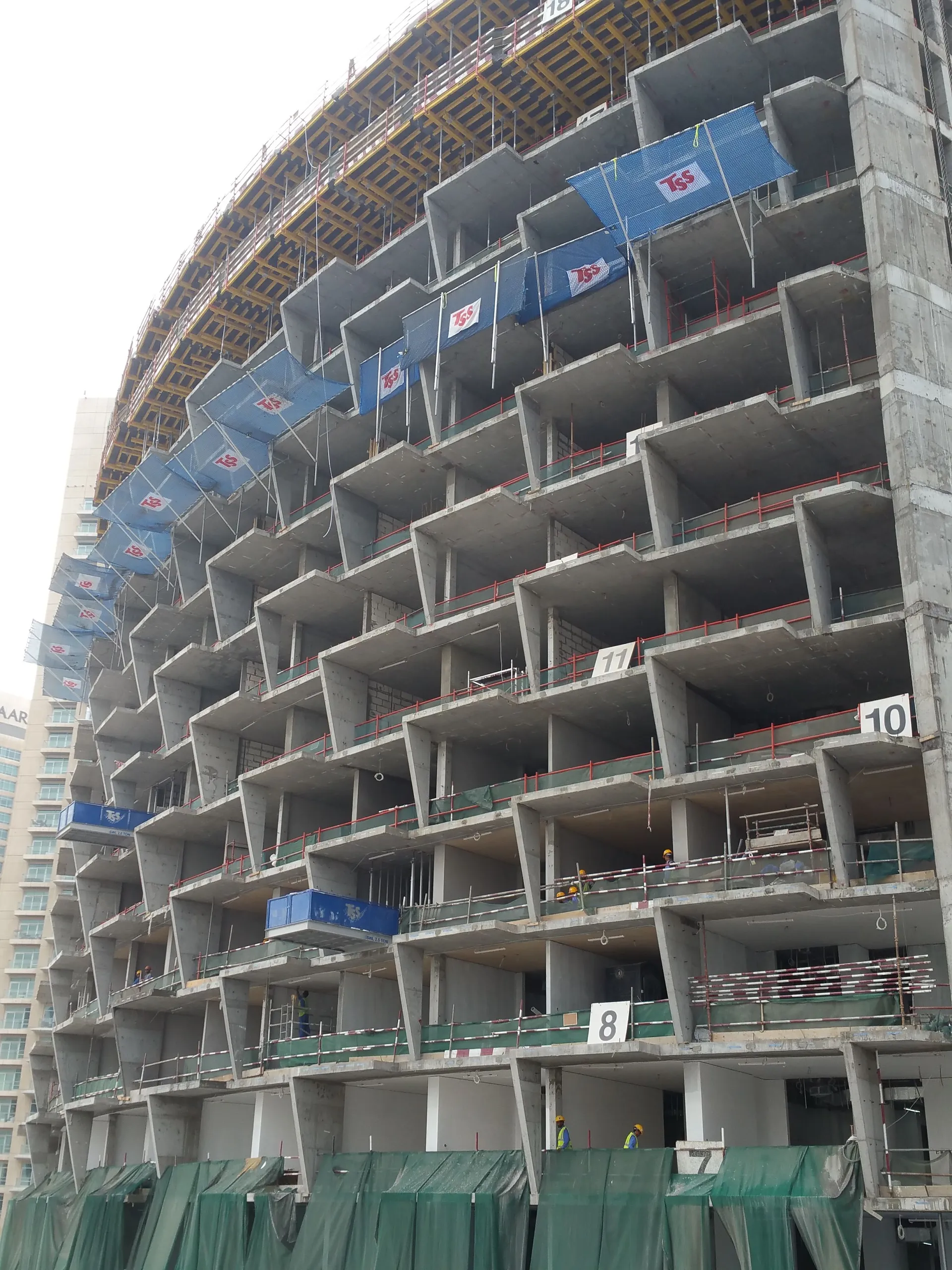

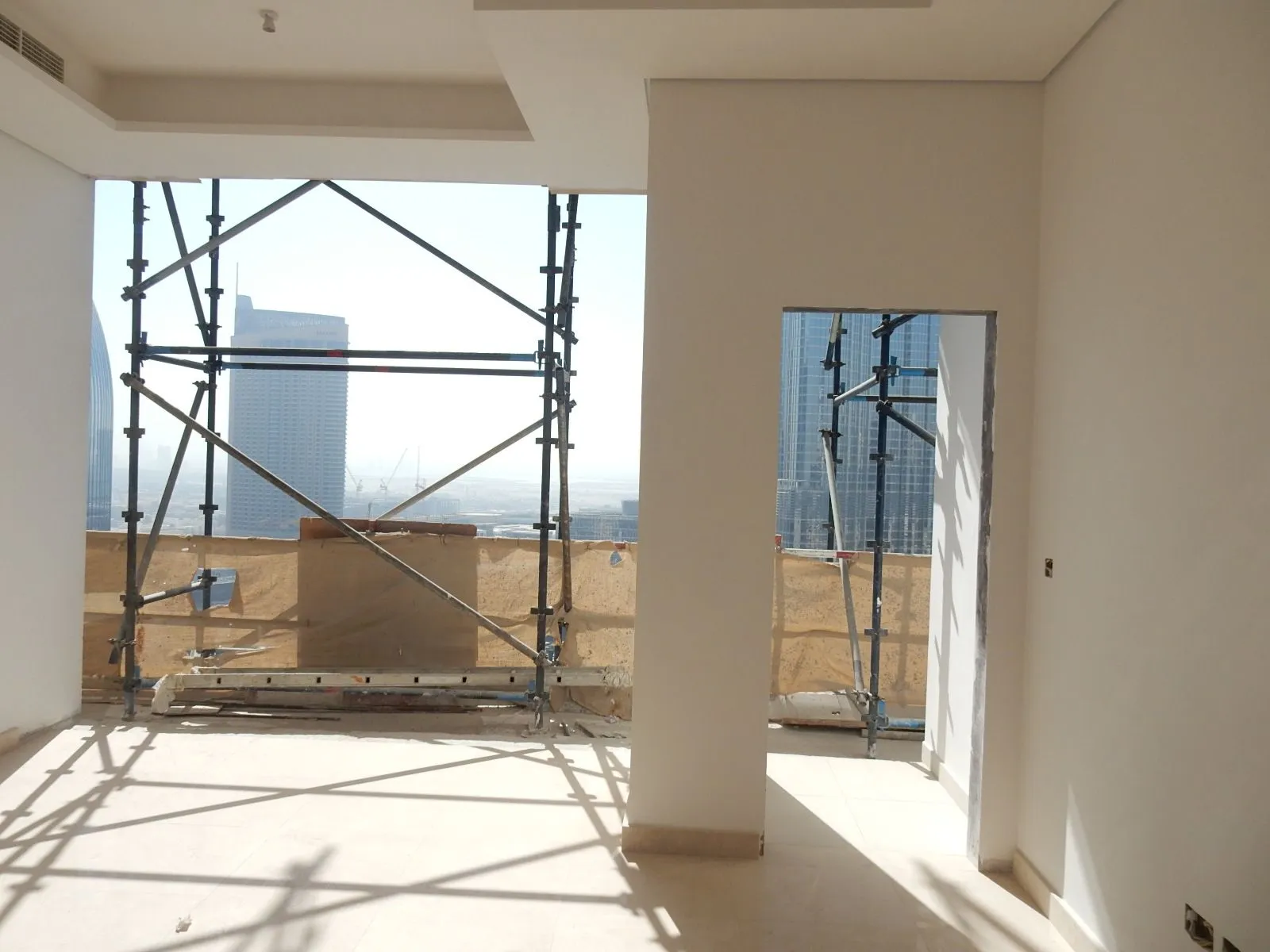

Construction progress of the project "Burj Vista" dated July 12, 2018

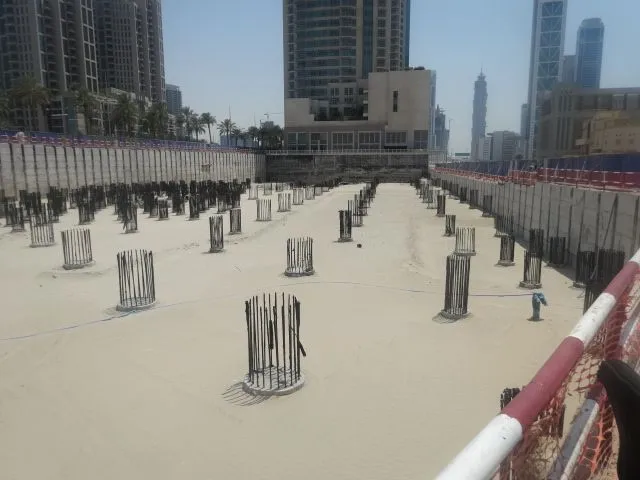

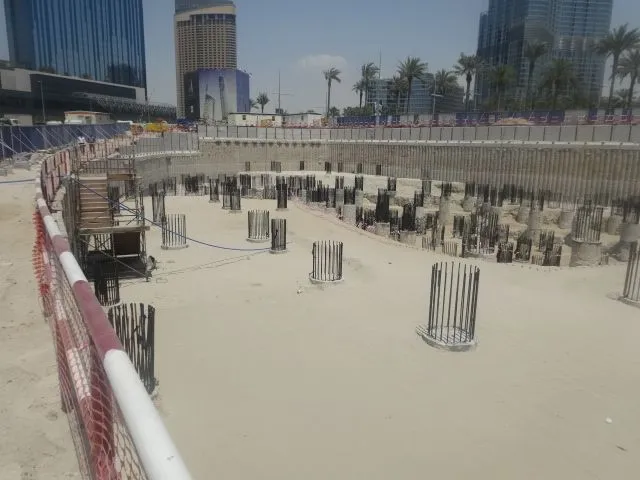

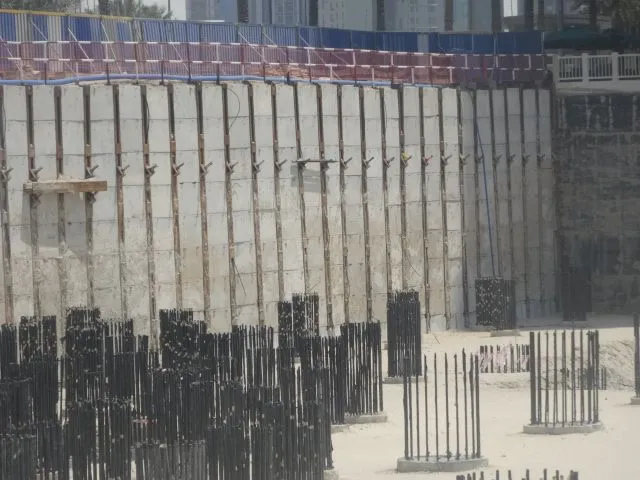

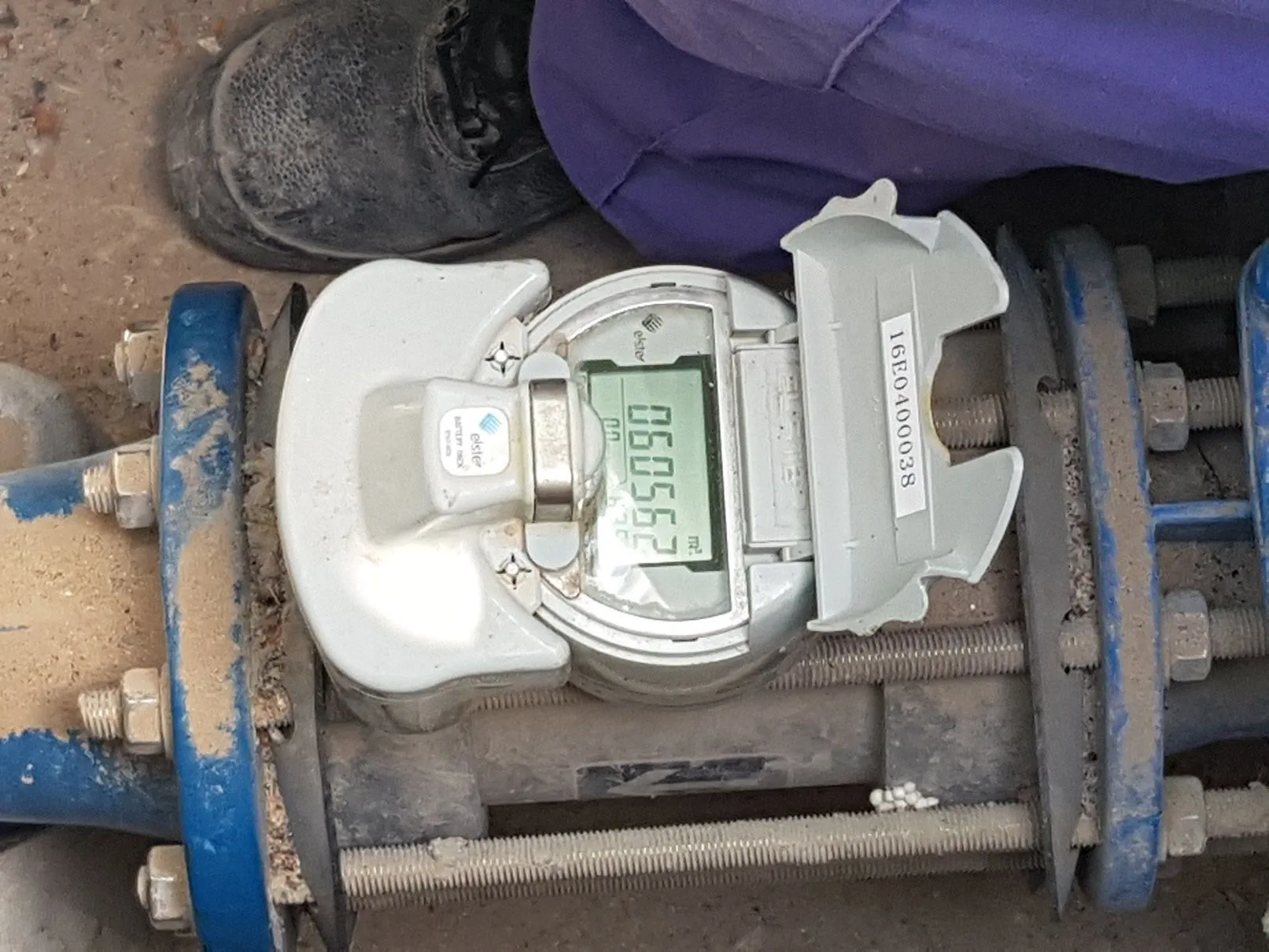

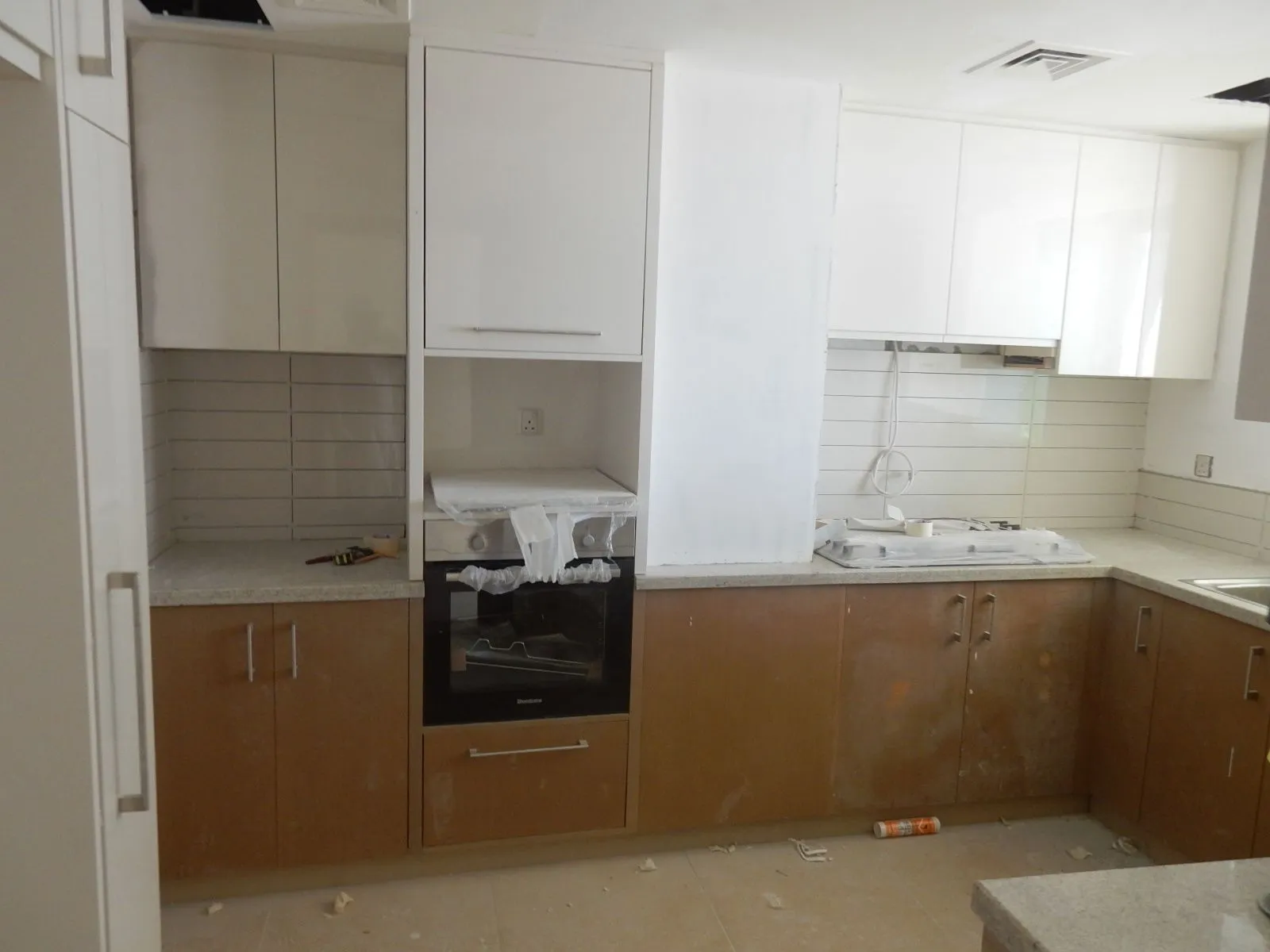

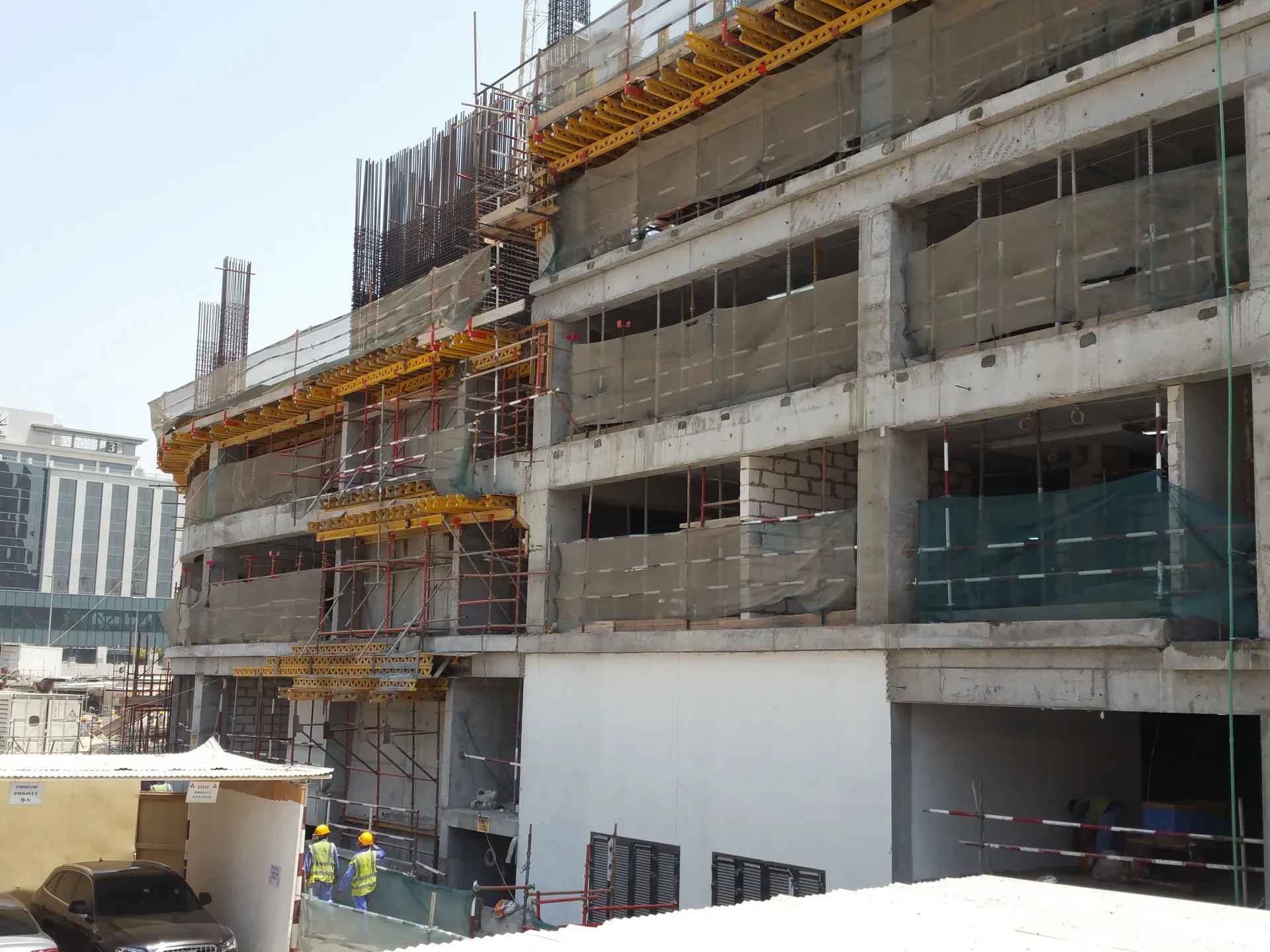

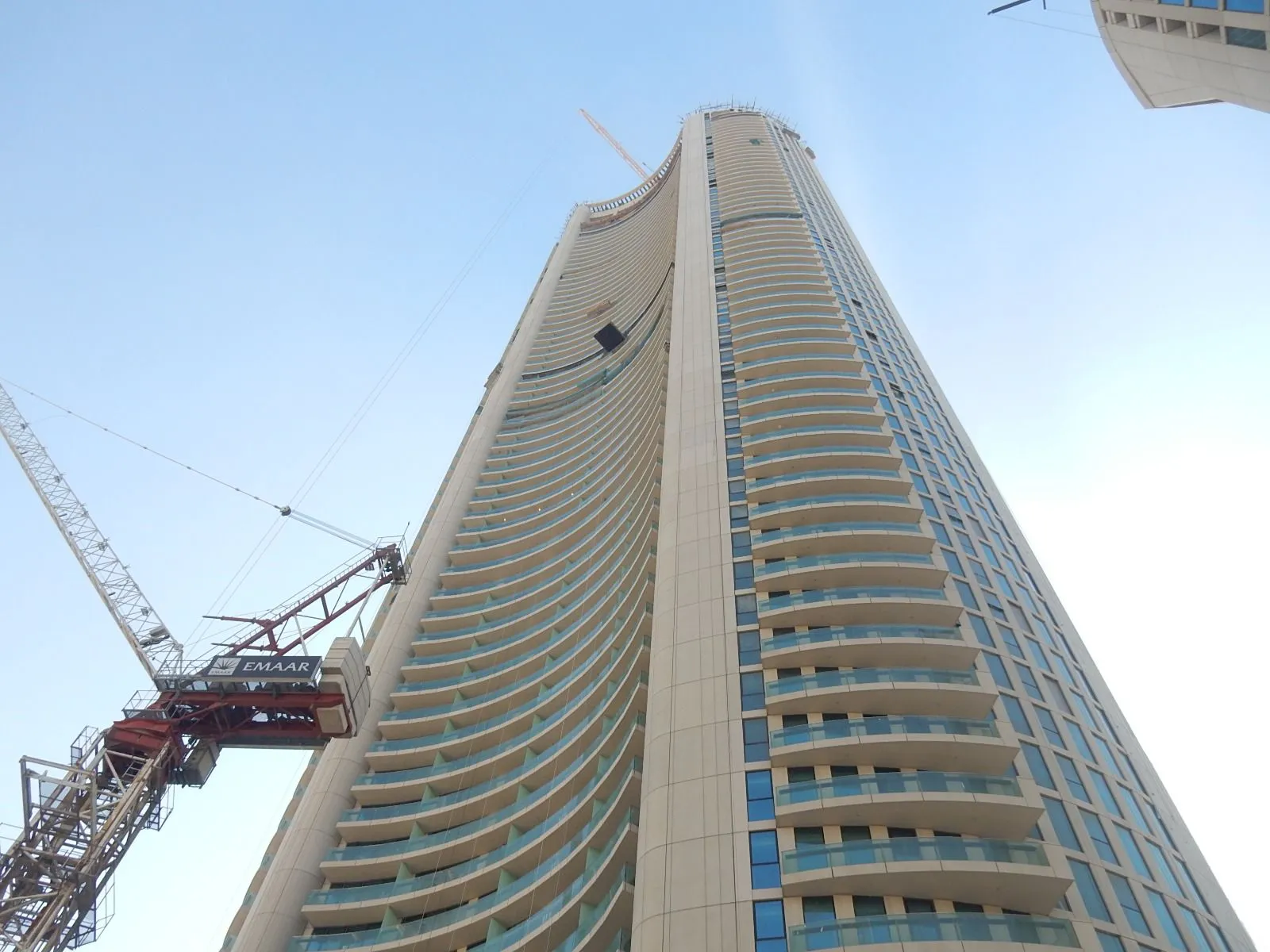

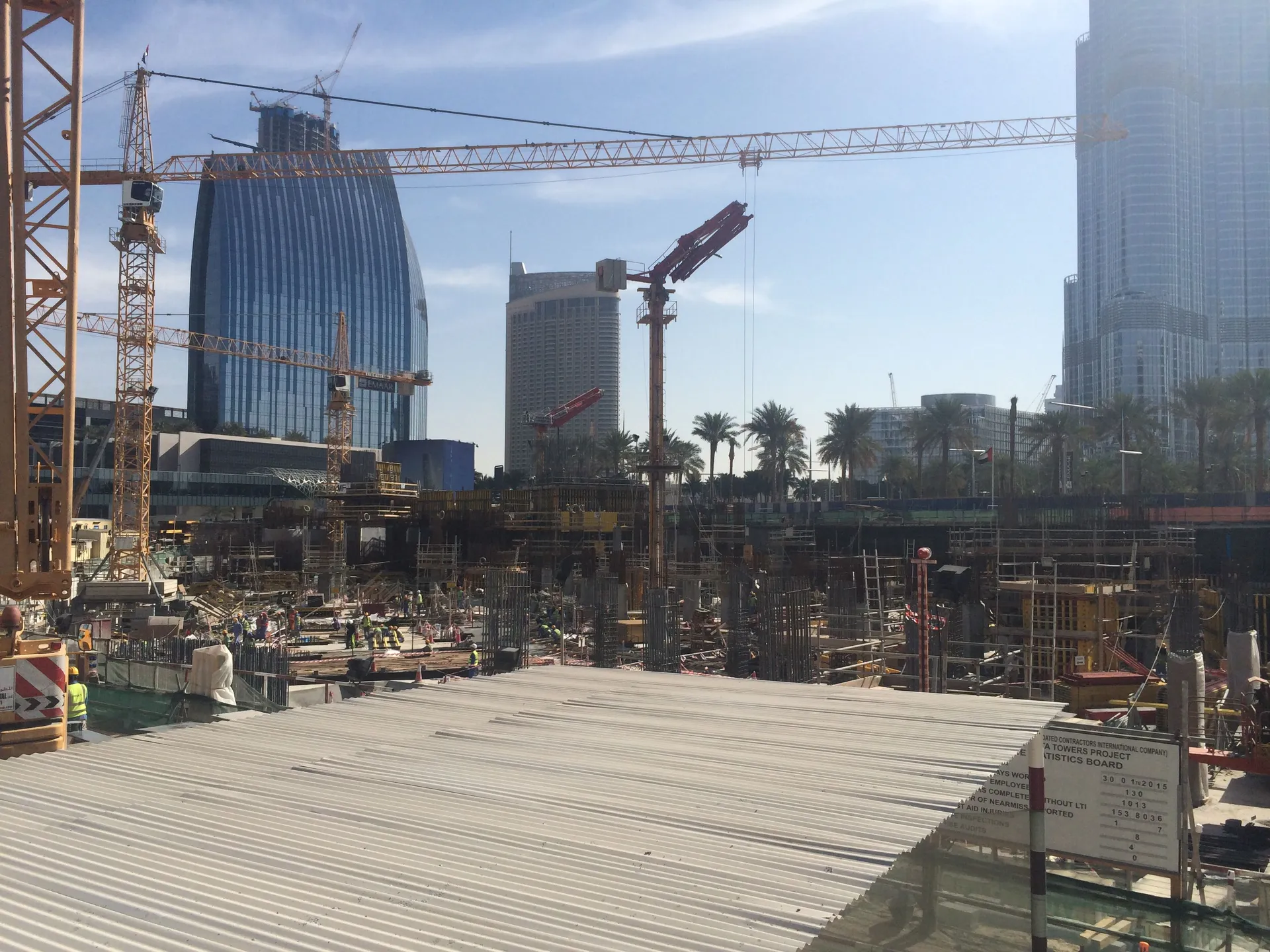

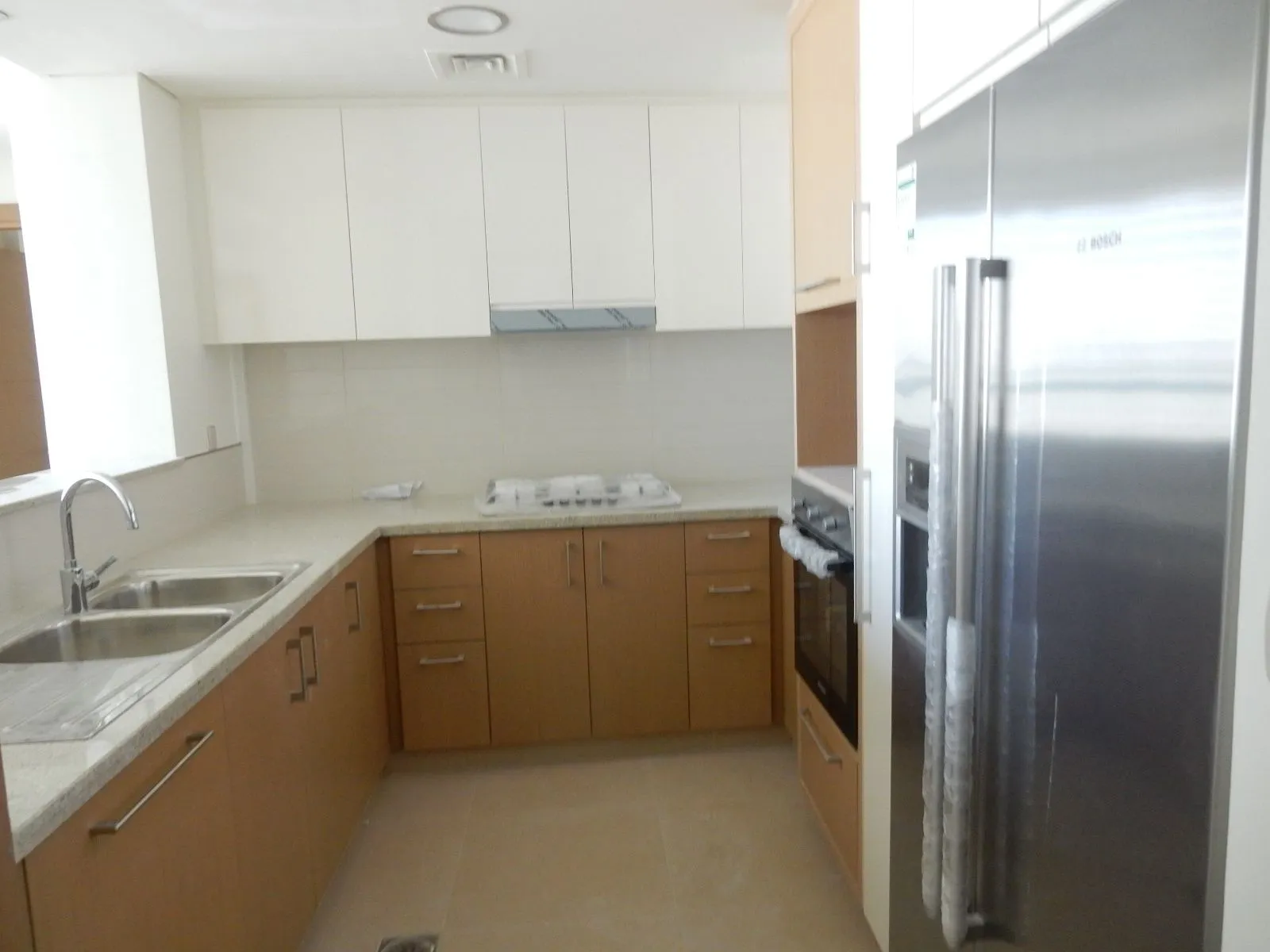

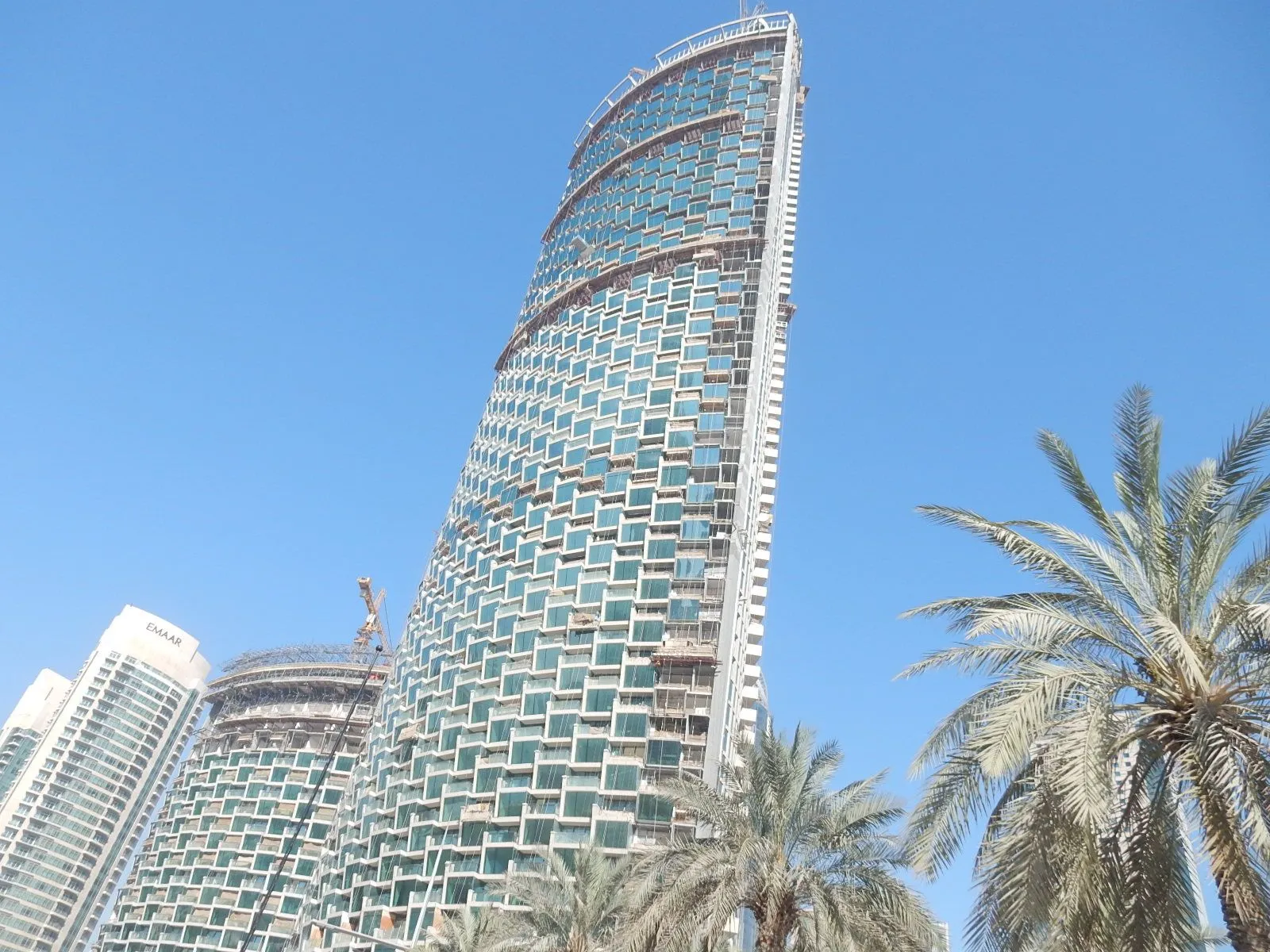

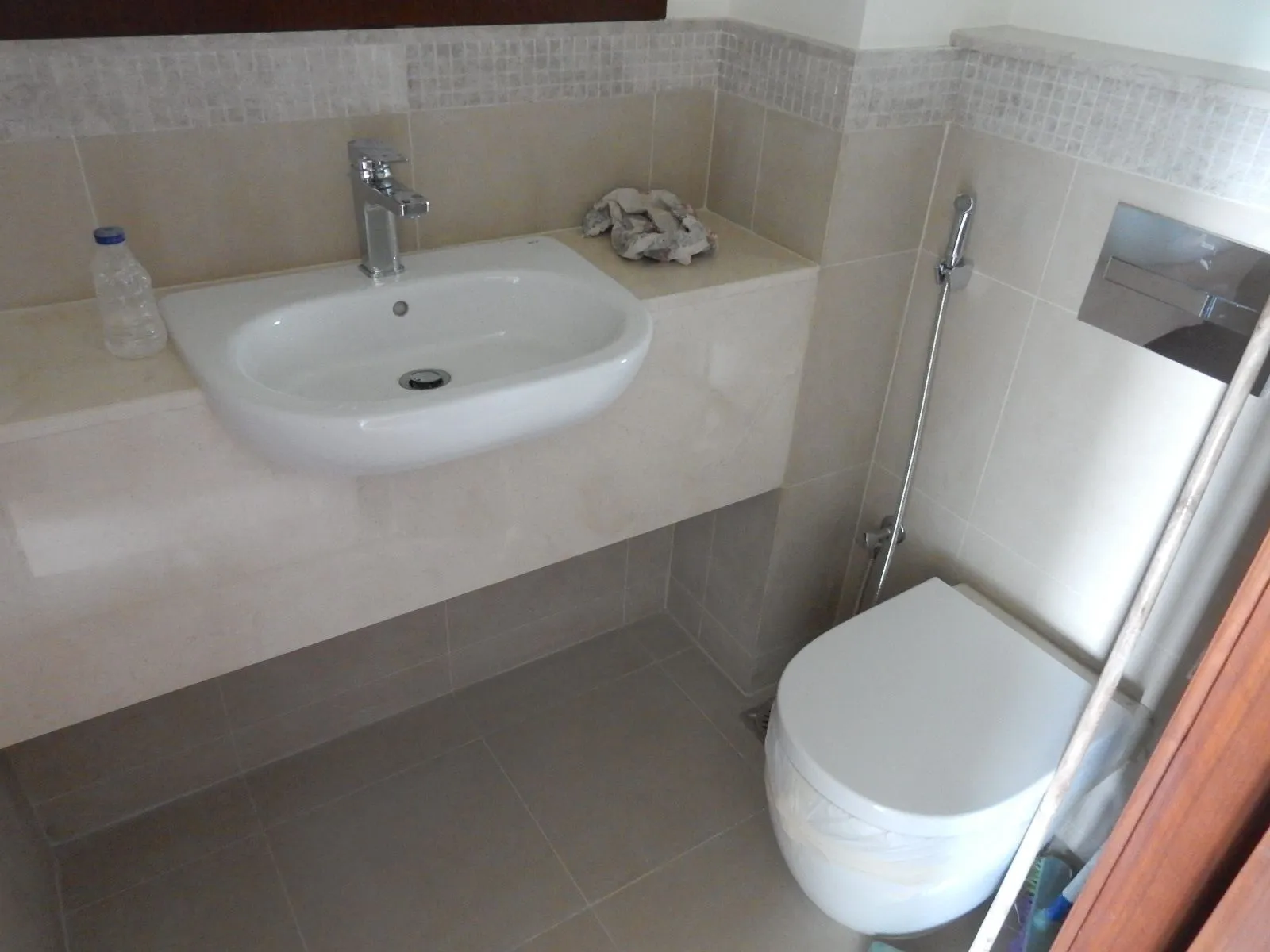

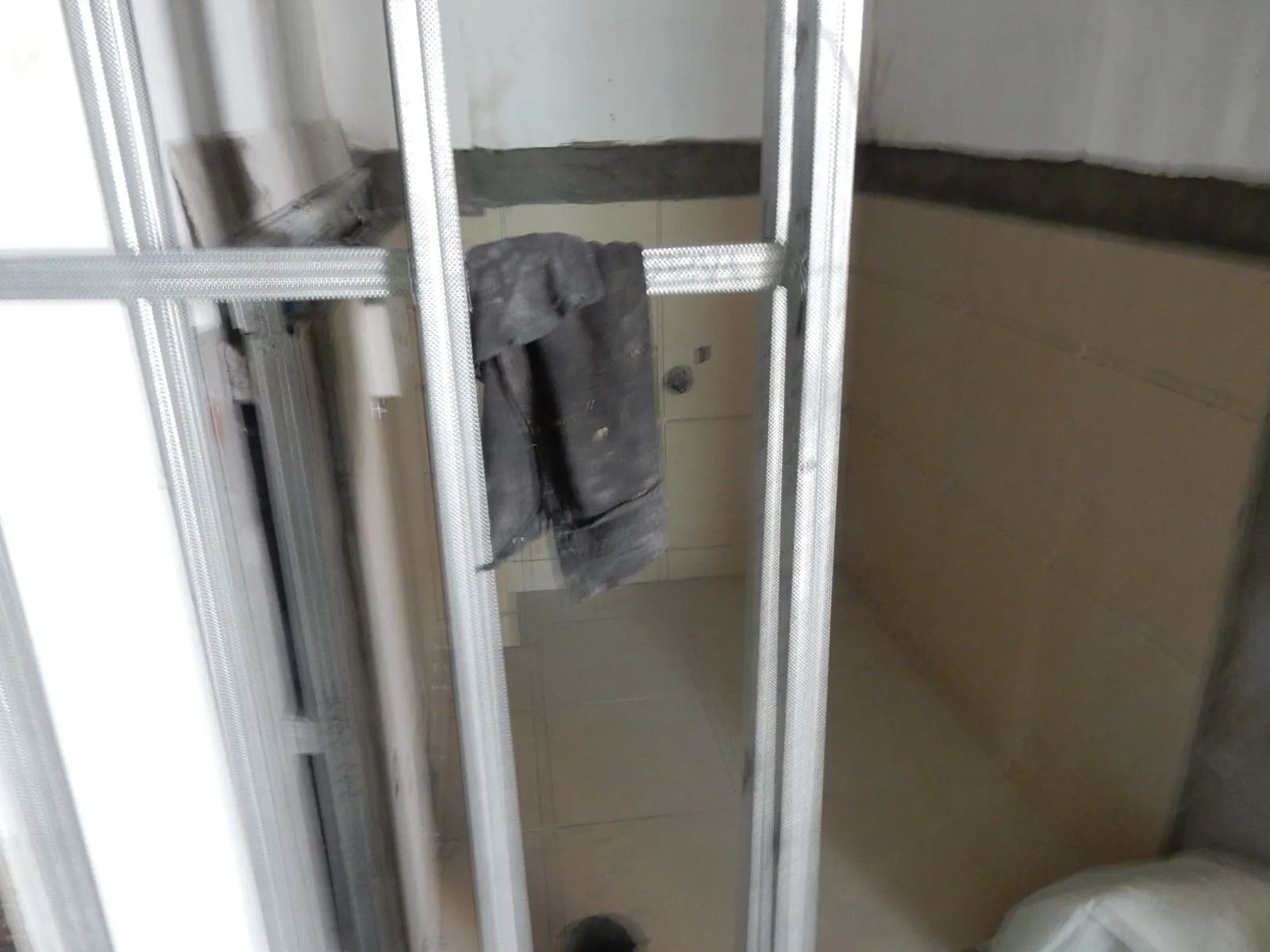

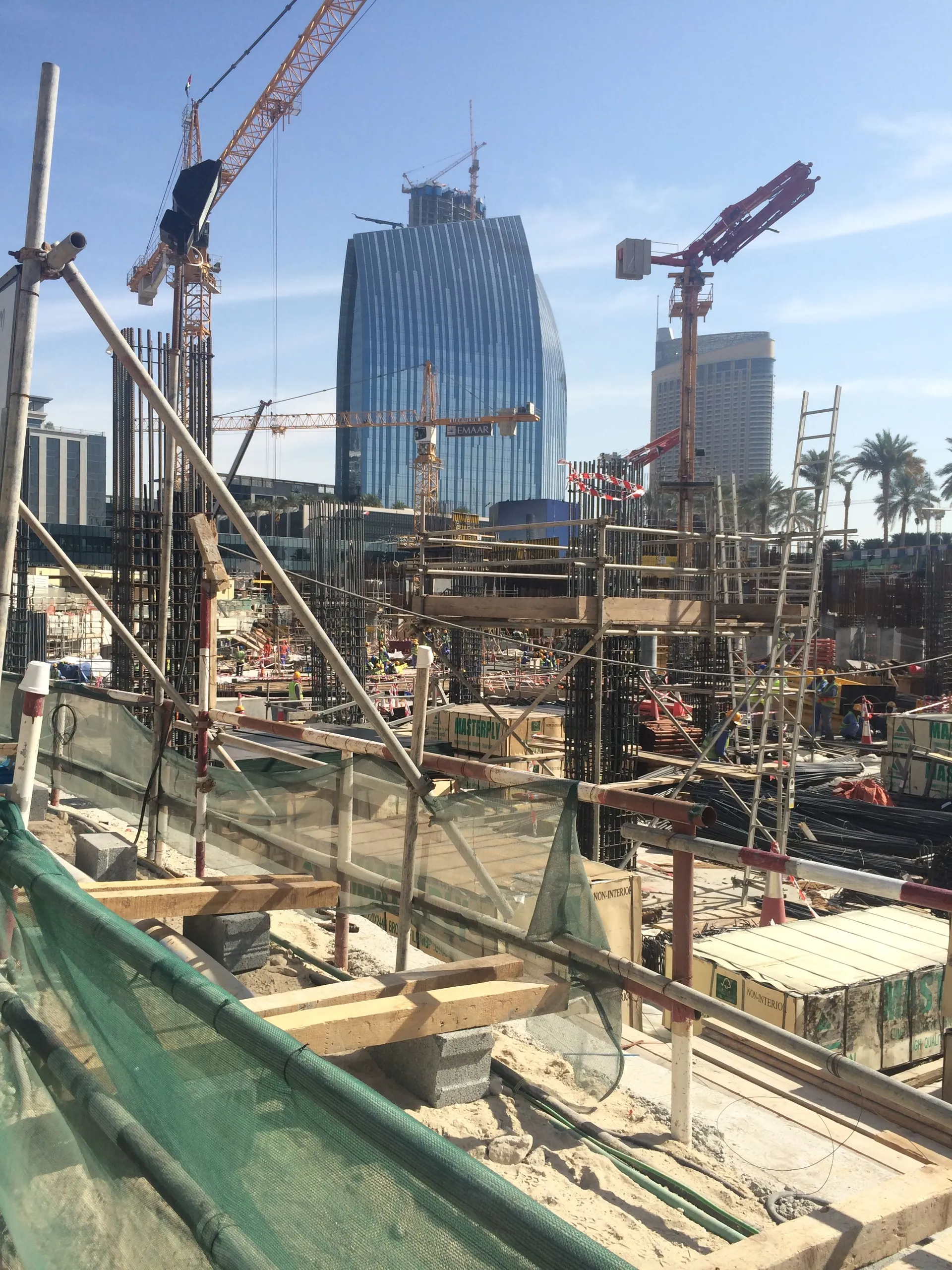

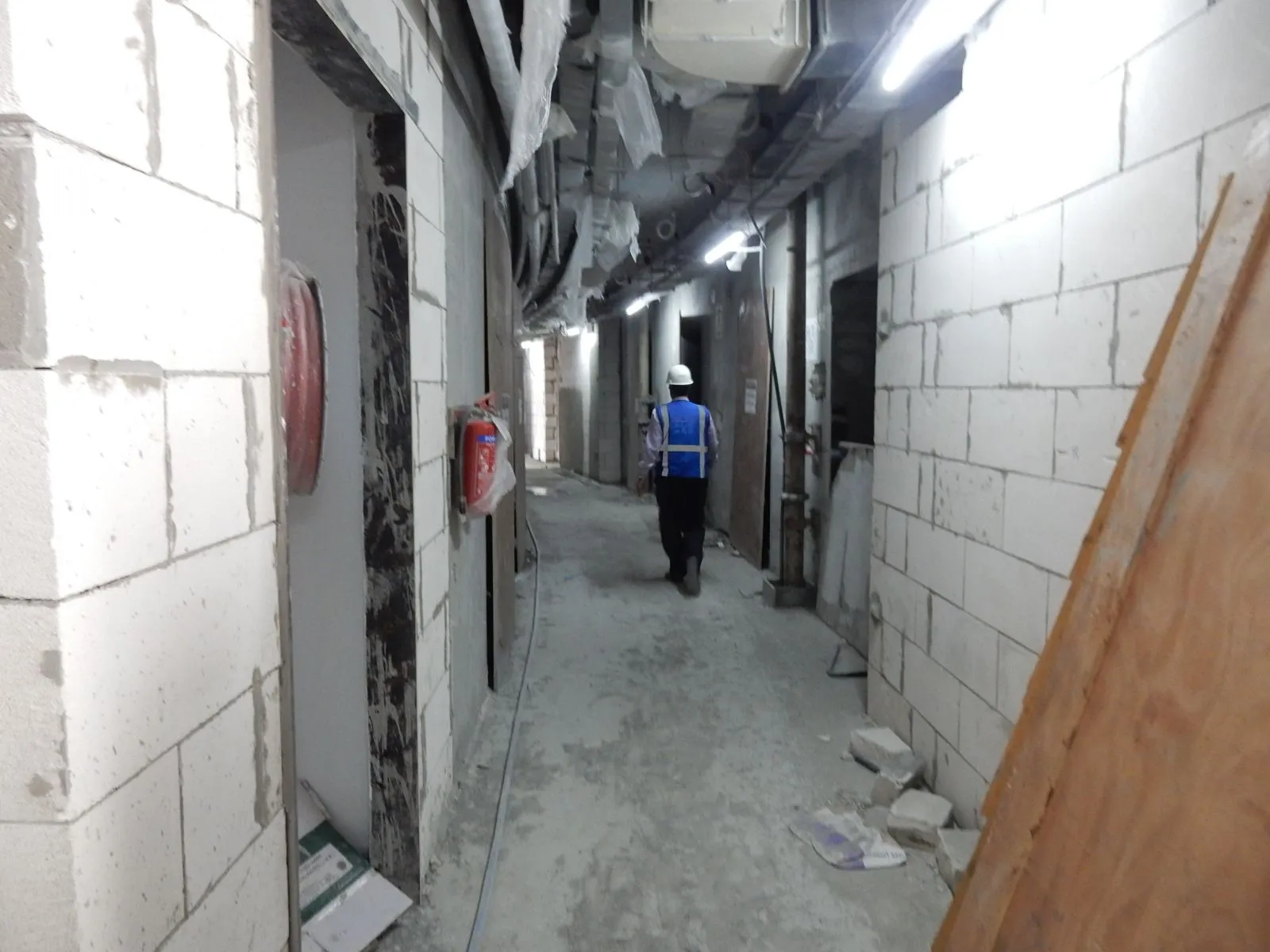

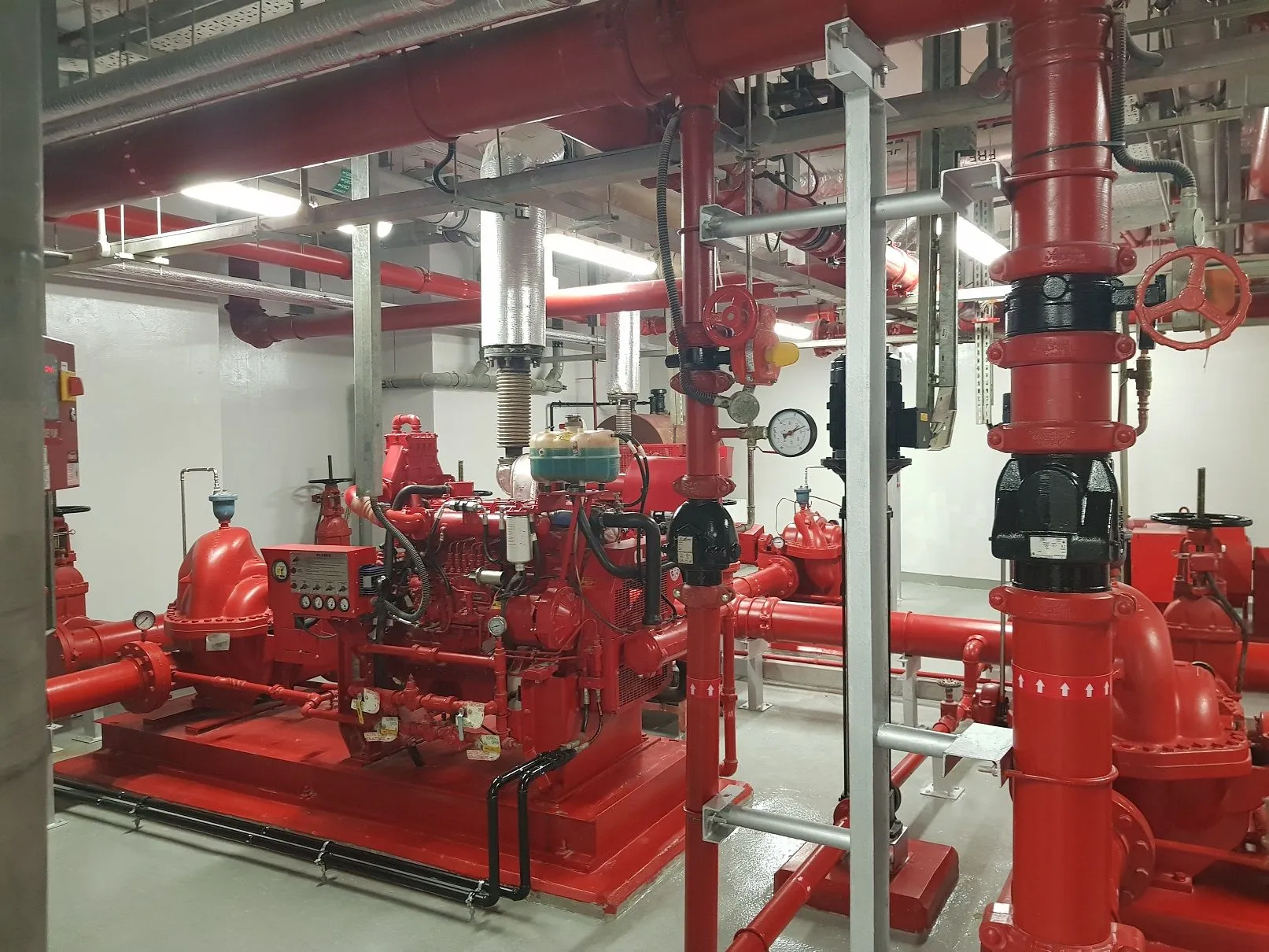

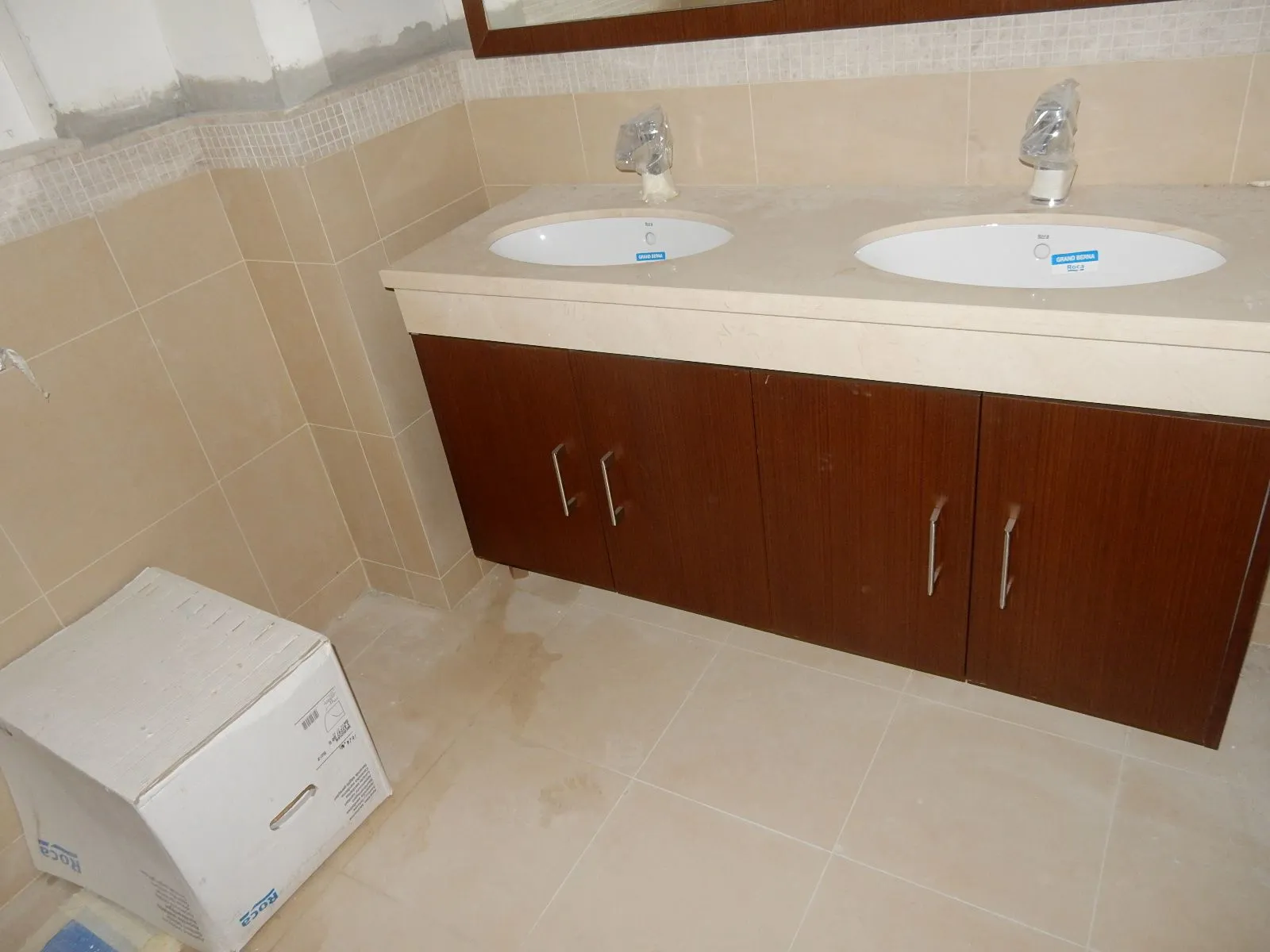

project inspections
project inspections
project inspections
project inspections
project inspections
project inspections
project inspections
project inspections
project inspections
project inspections
project inspections
project inspections
project inspections
project inspections

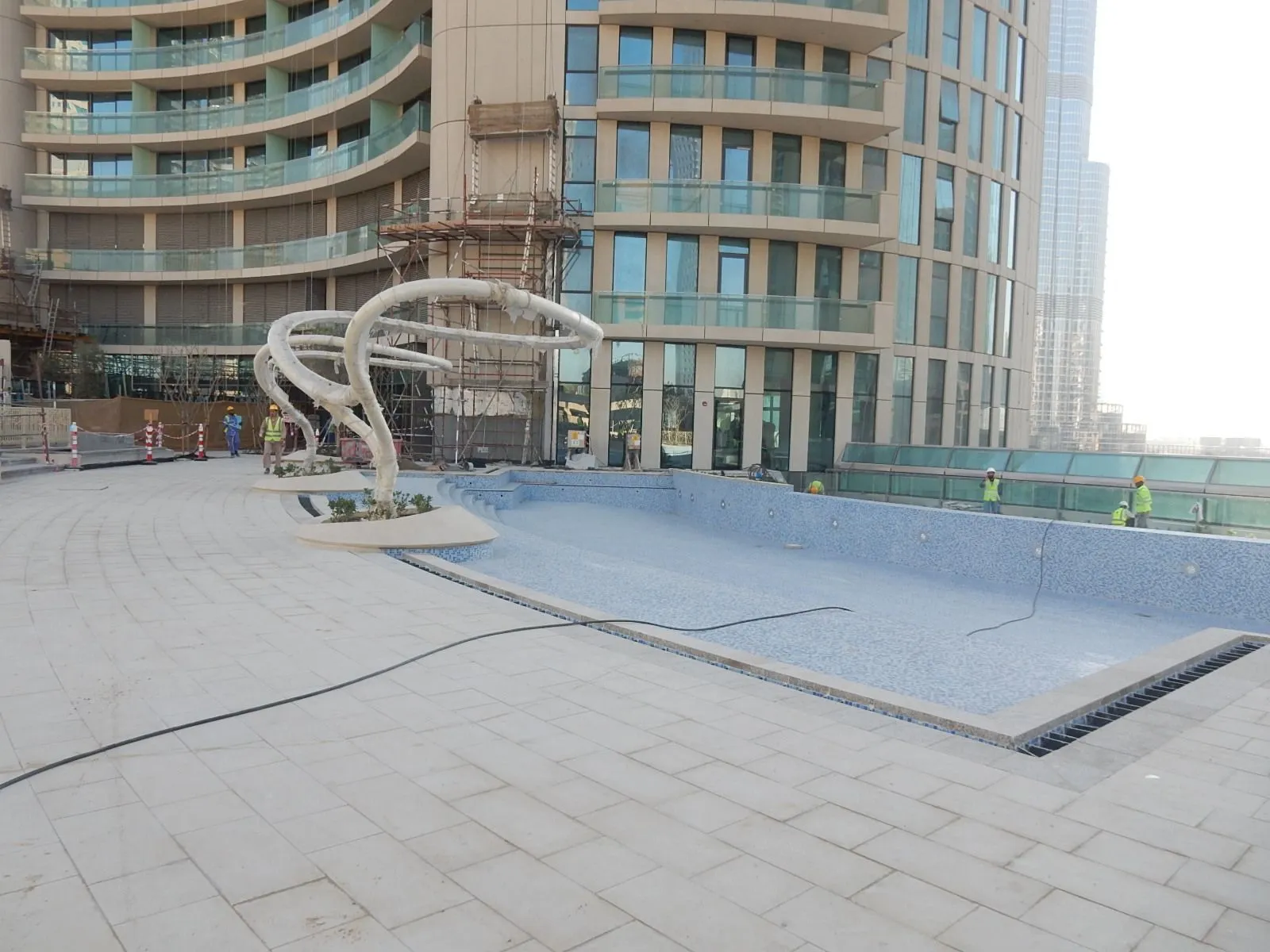

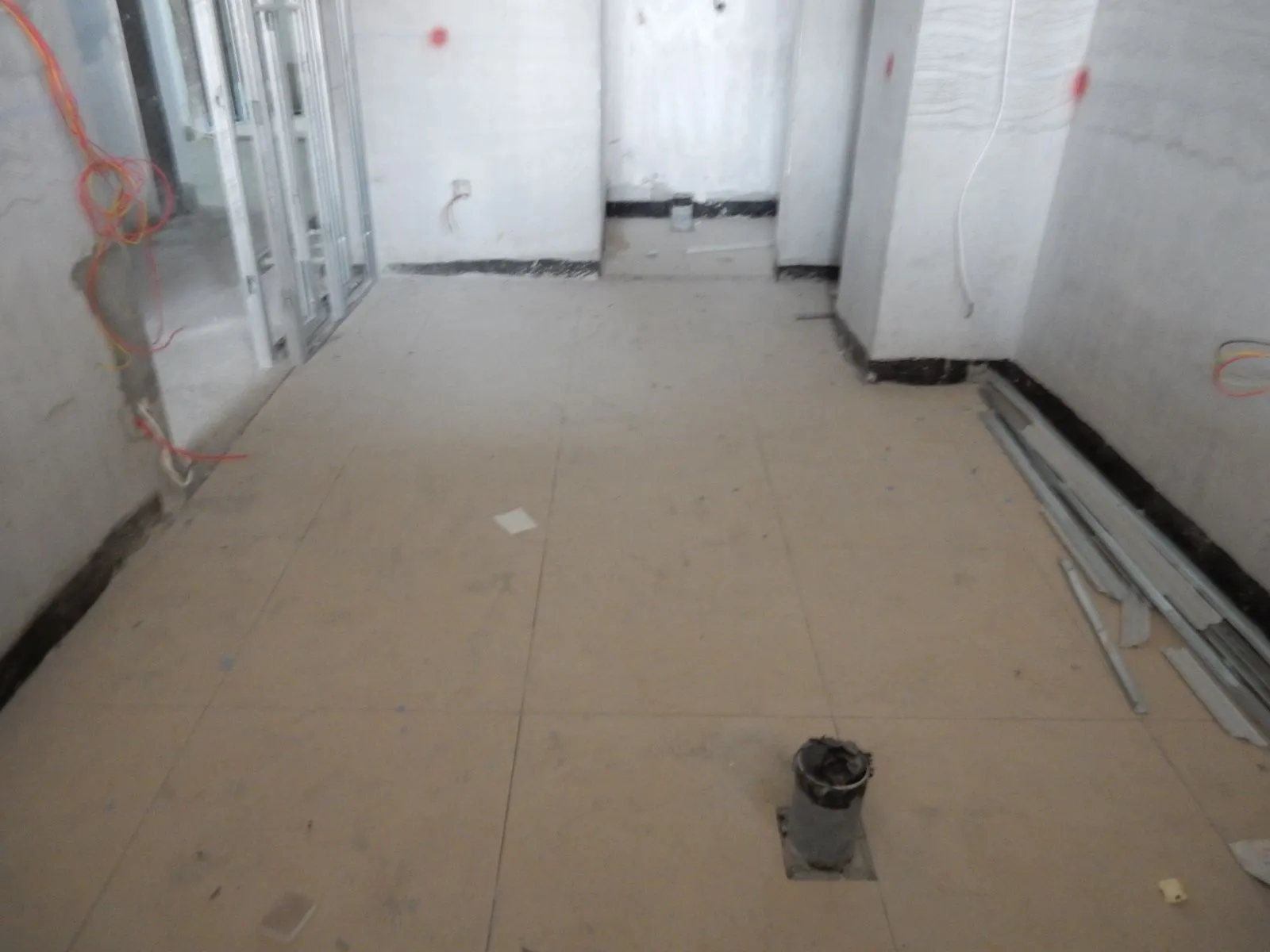

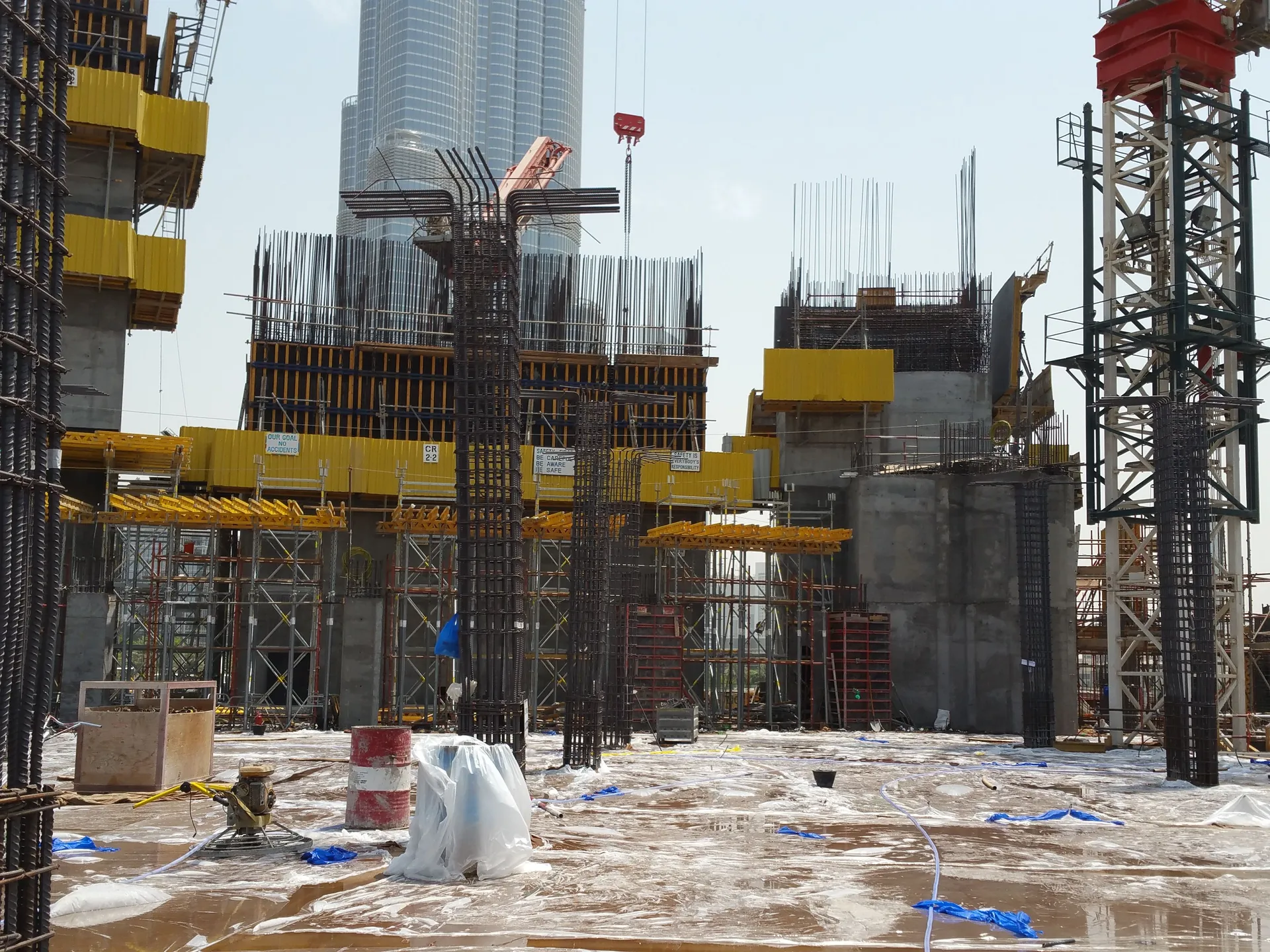

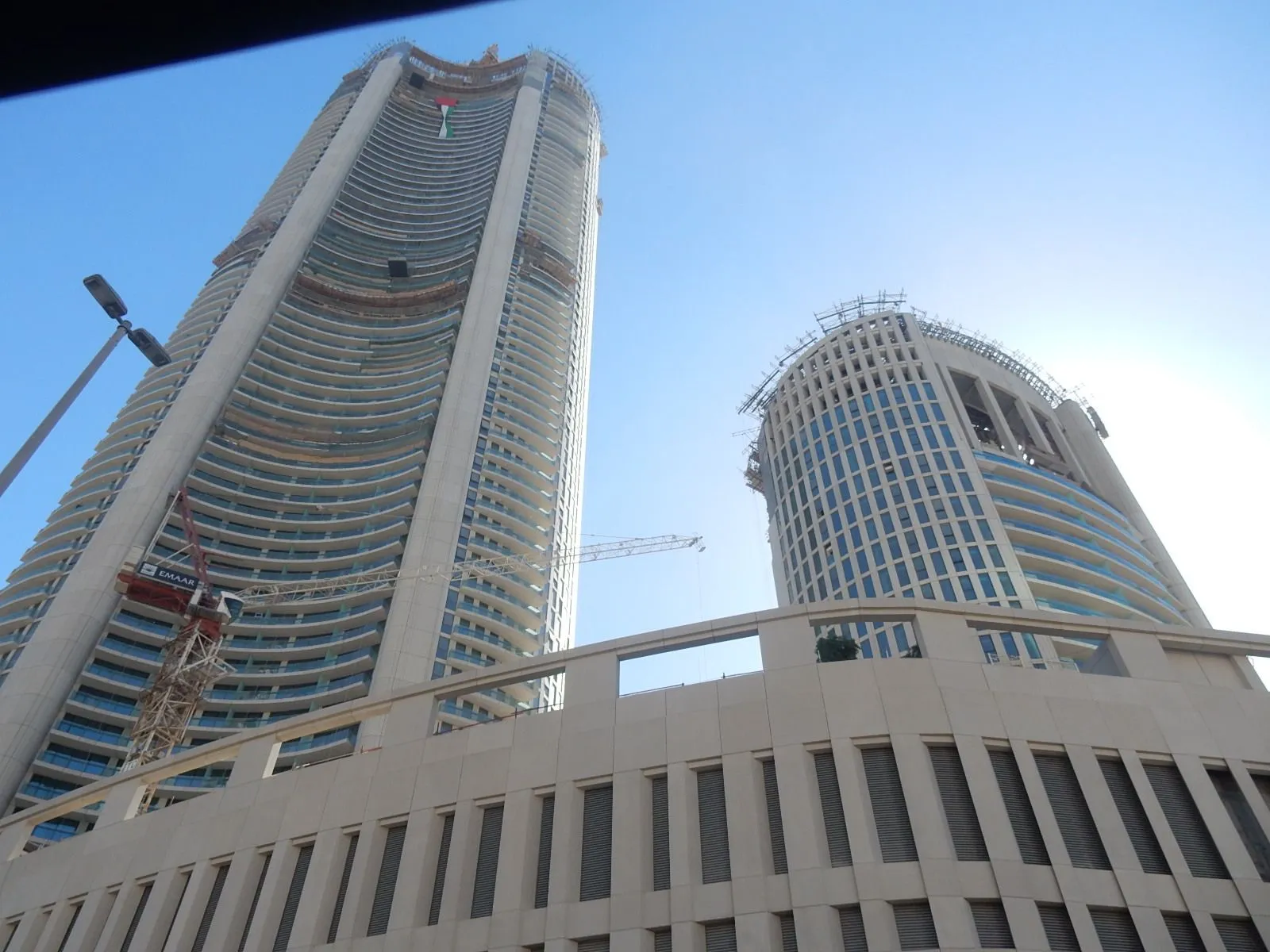

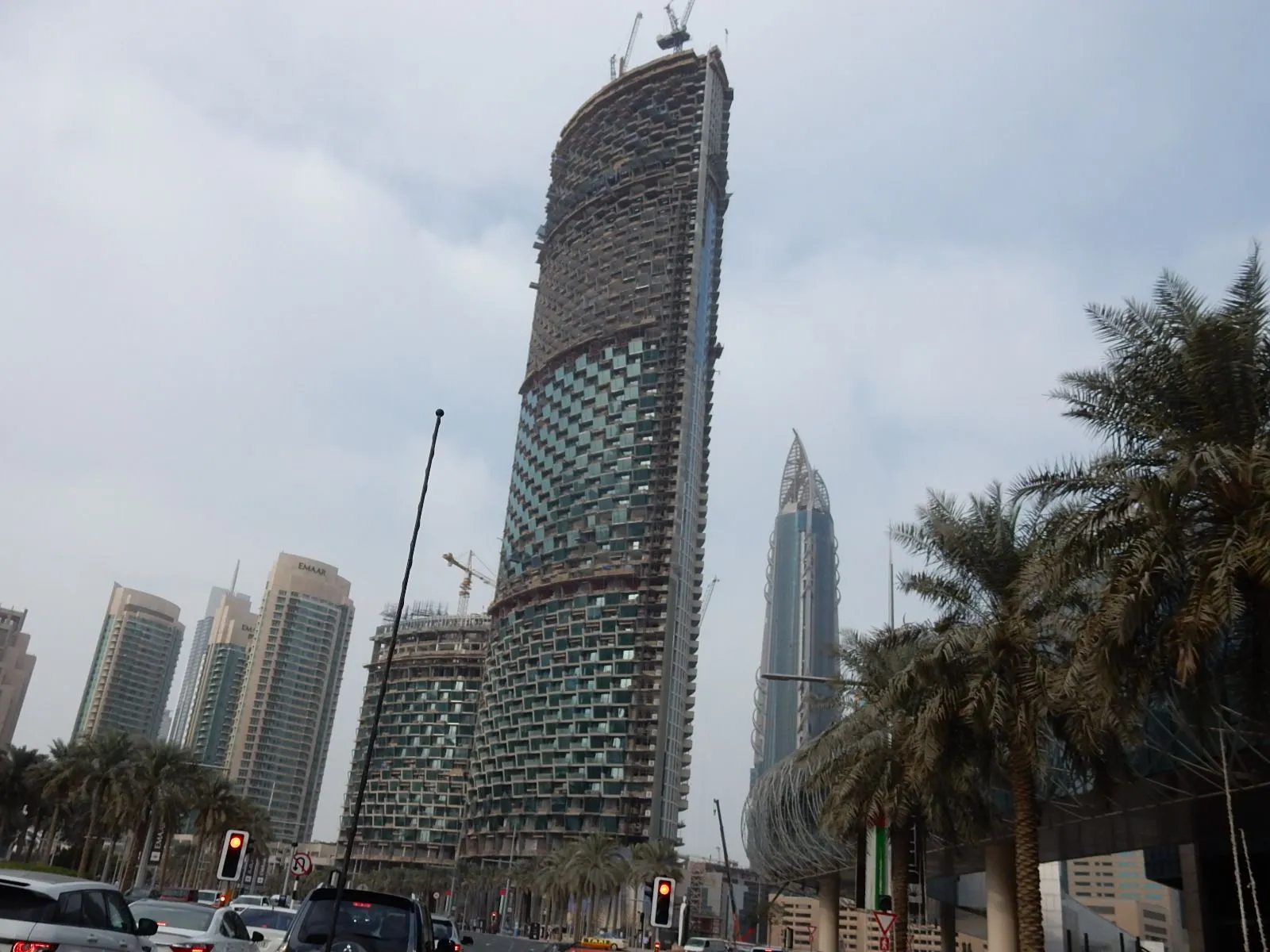

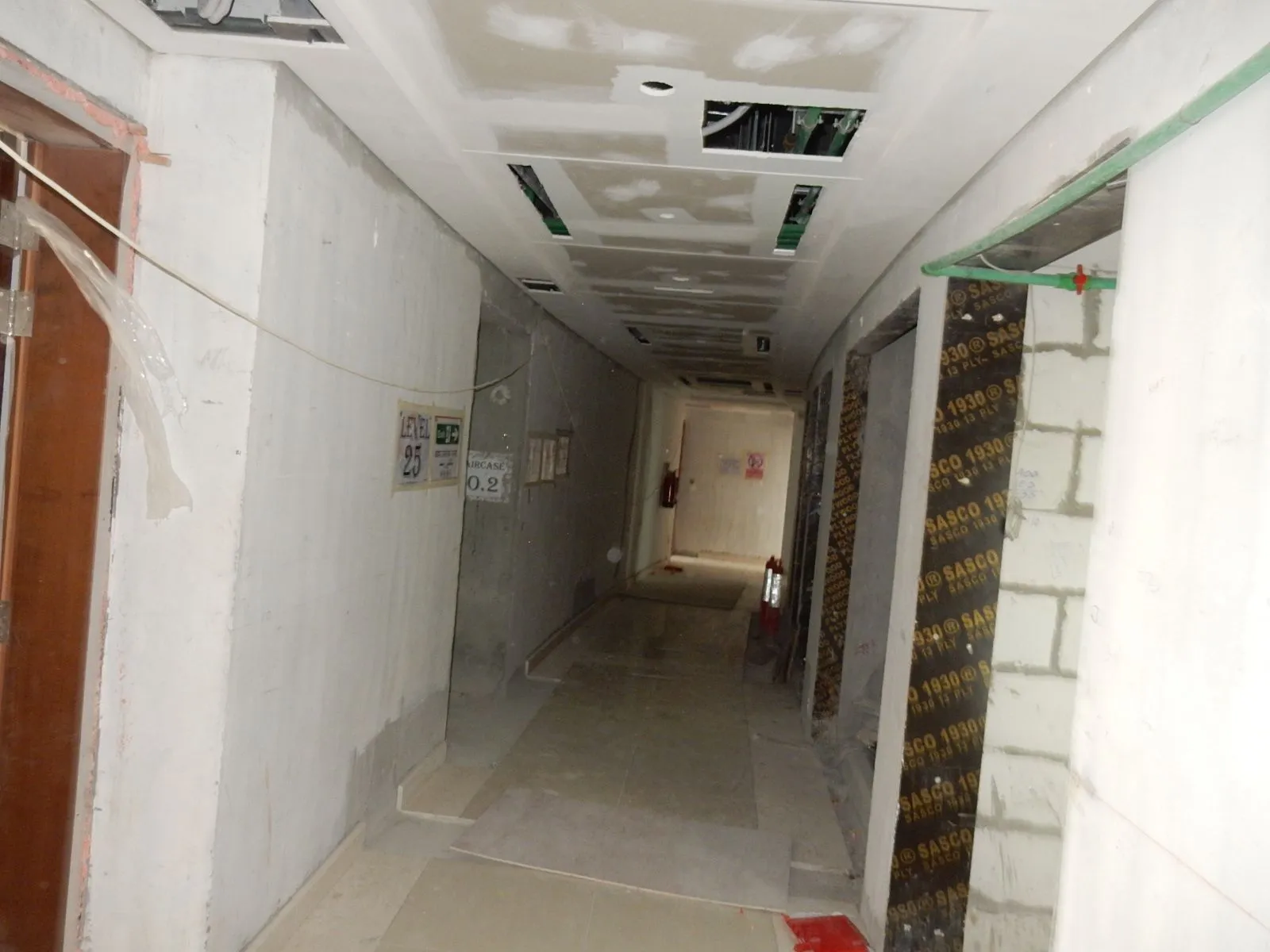

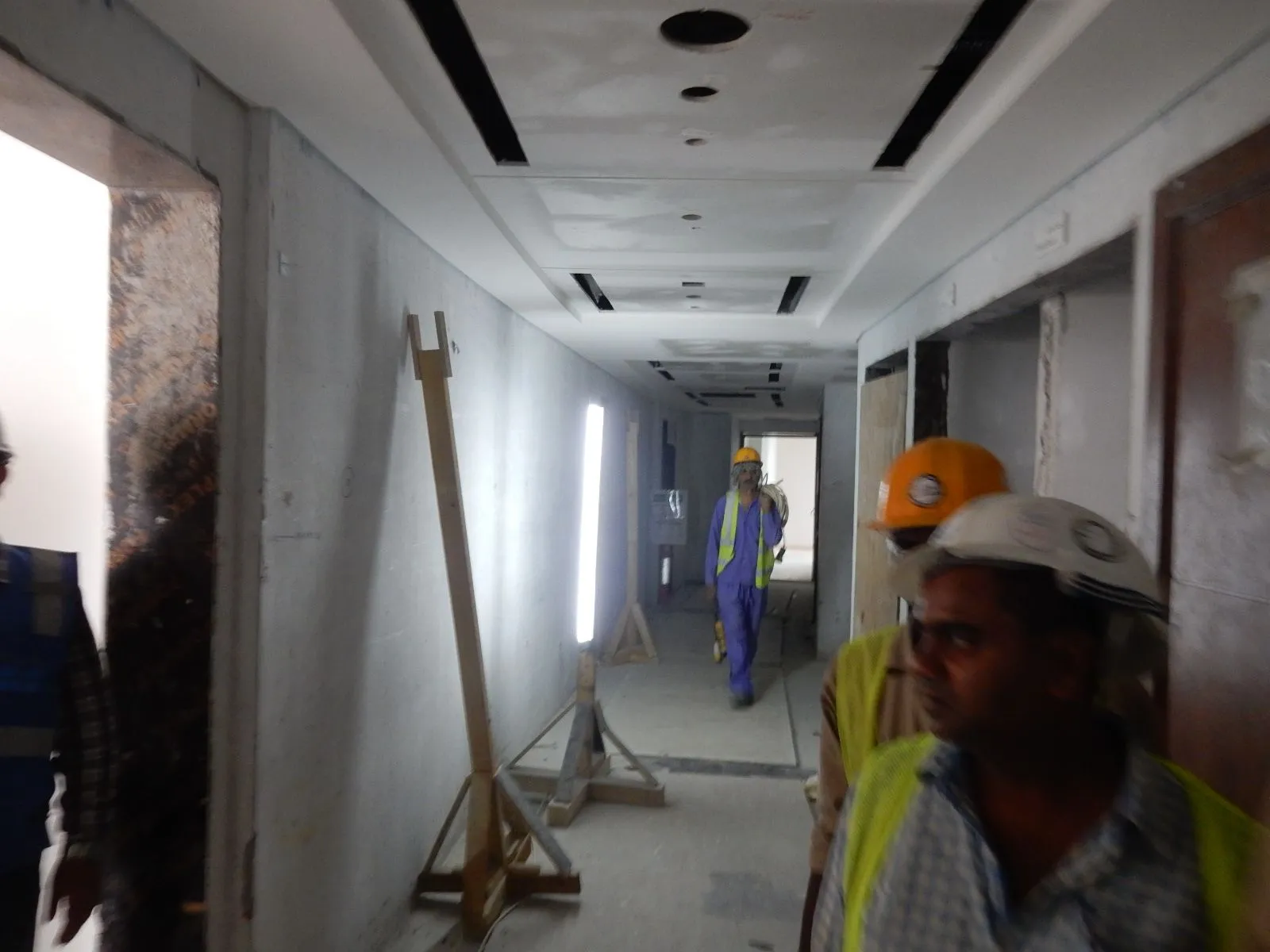

March 21, 2018
Readiness: 91.22%
Construction progress of the project "Burj Vista" dated March 21, 2018

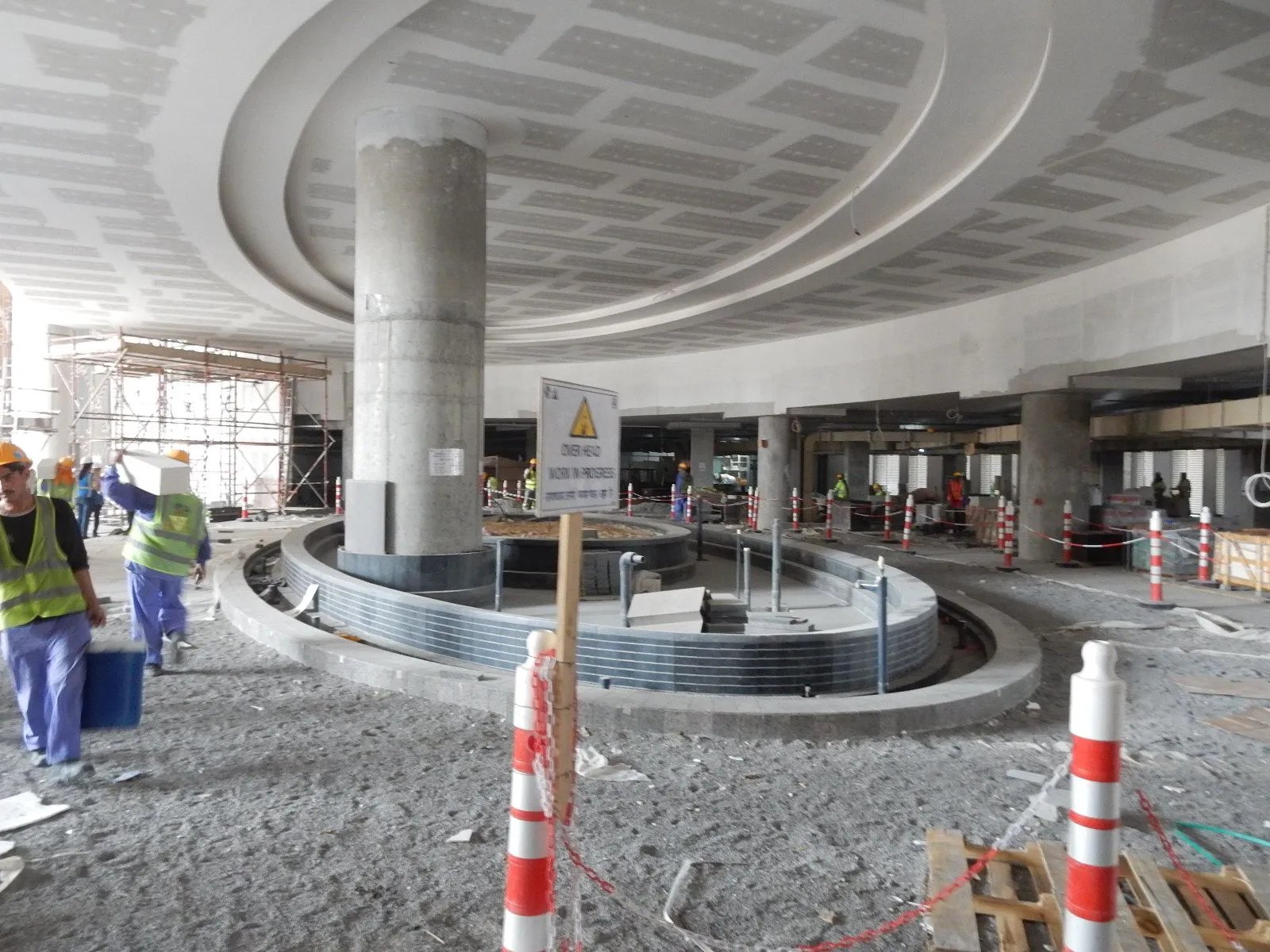

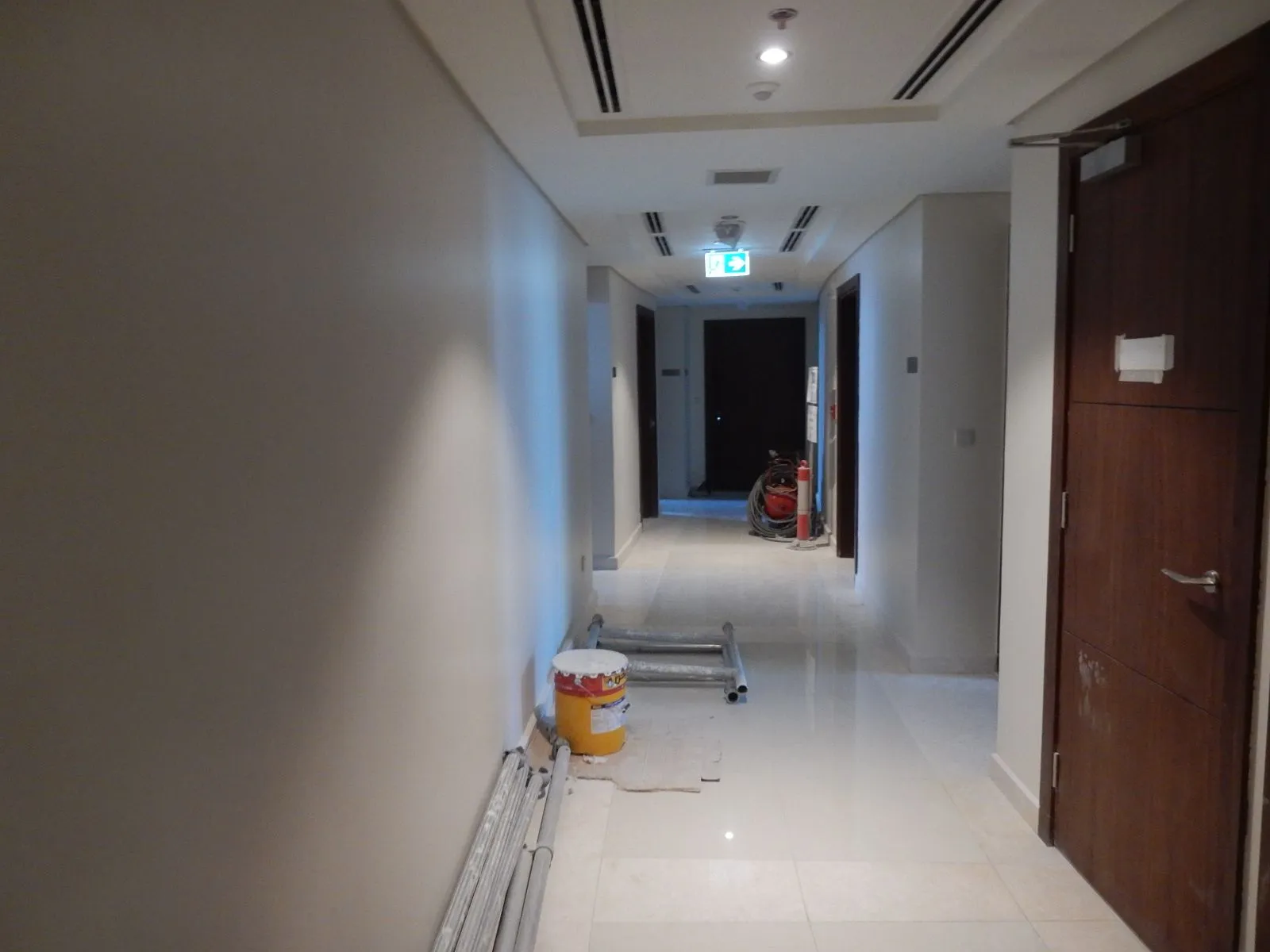

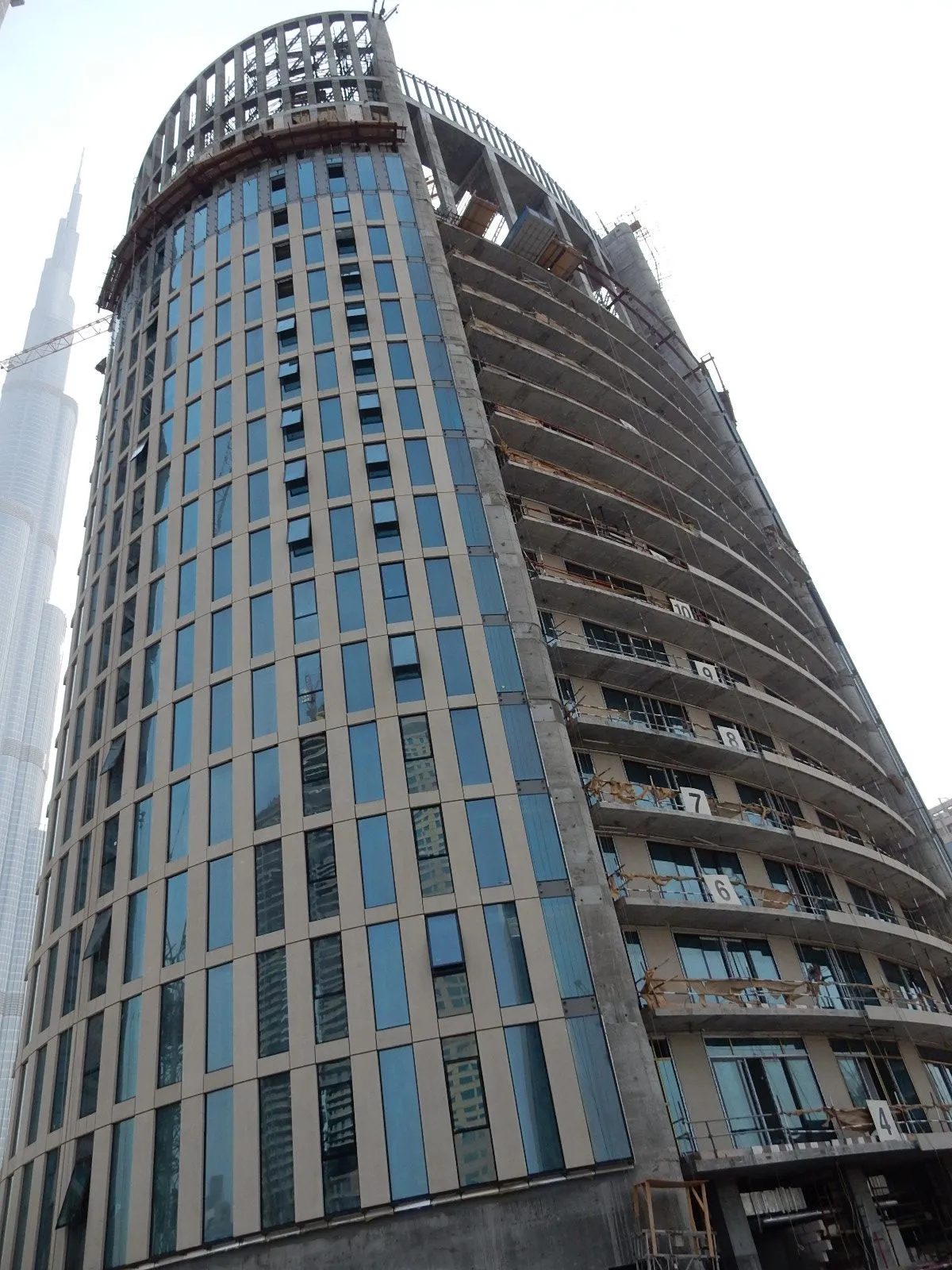

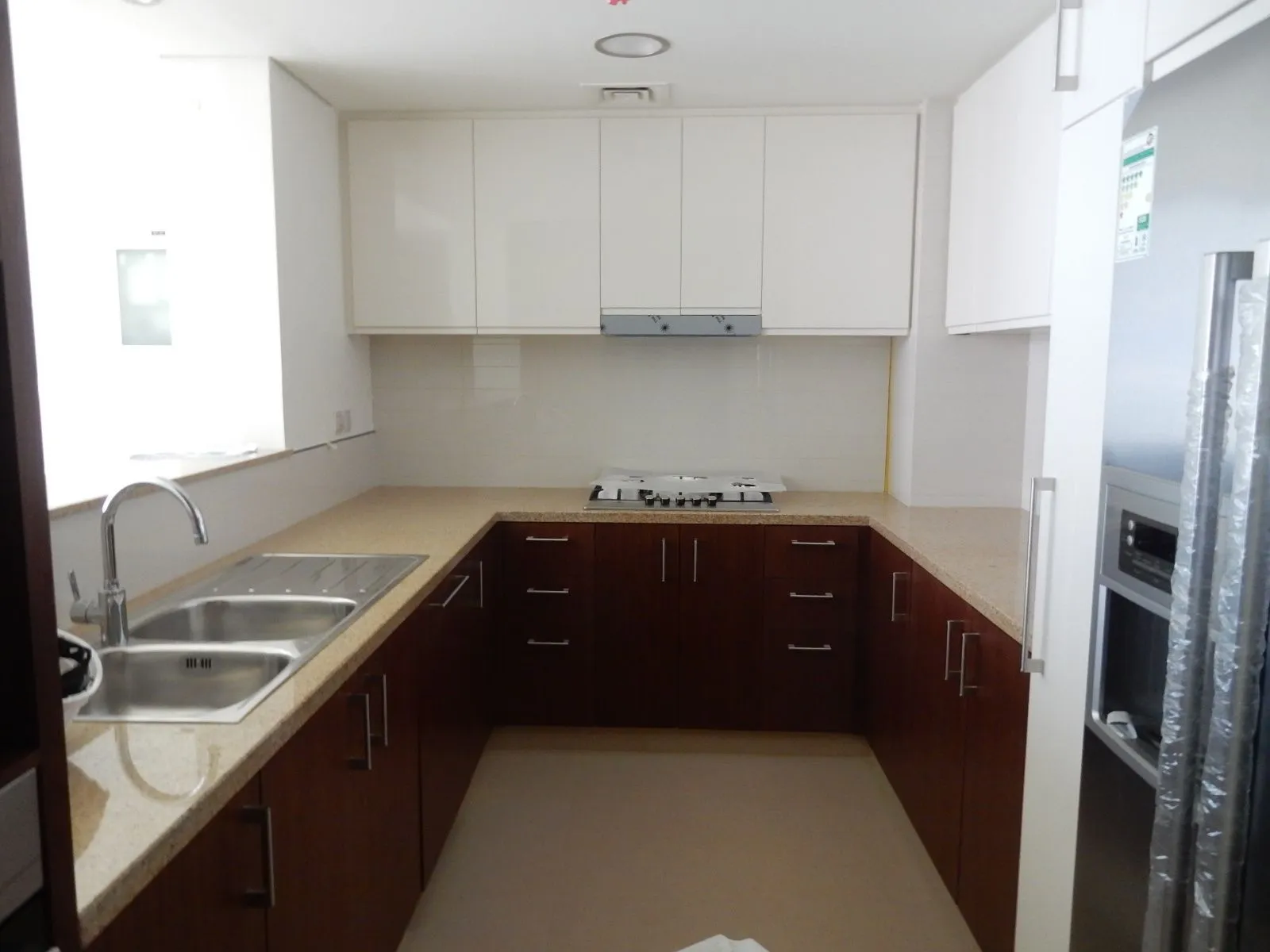

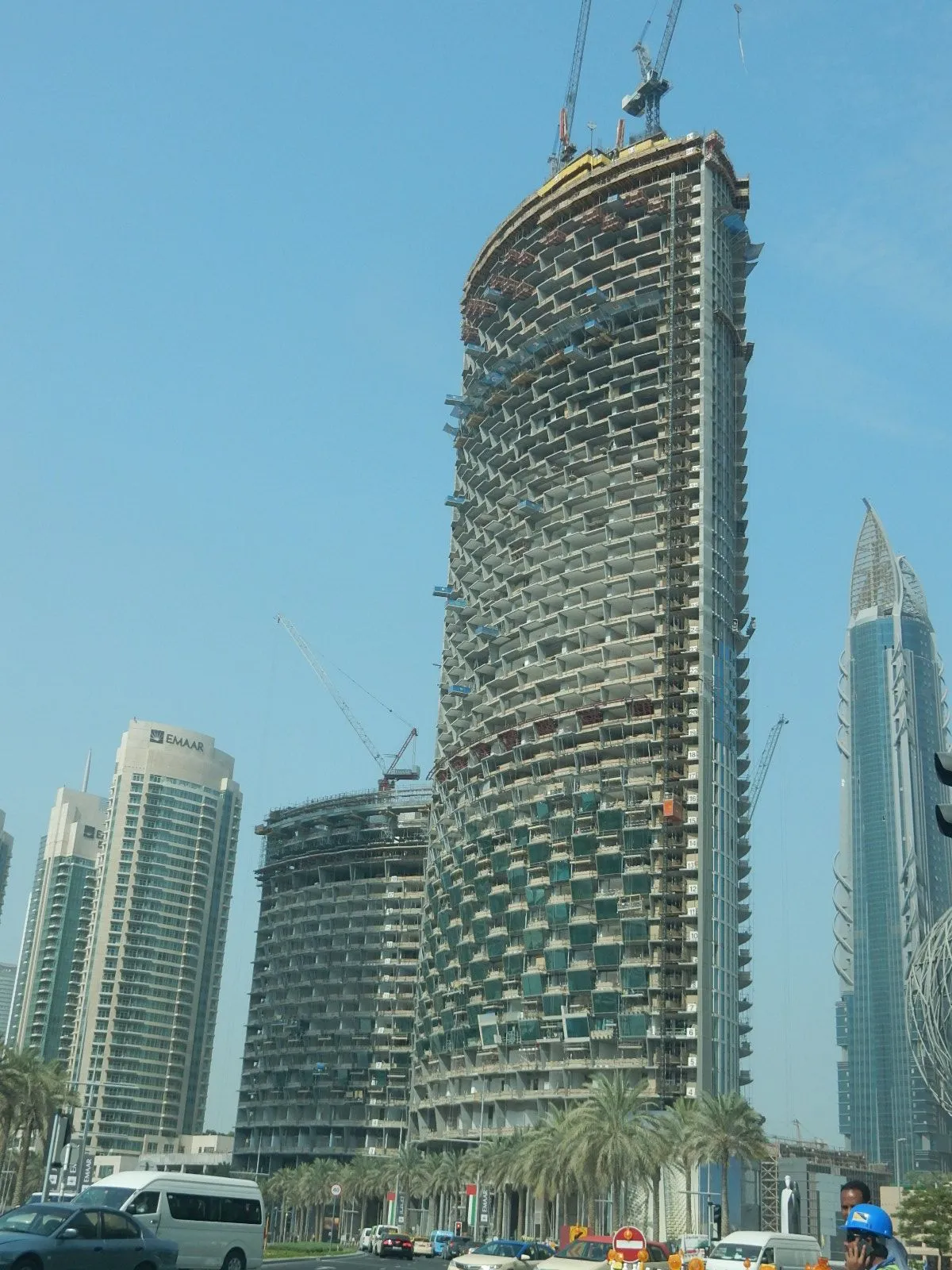

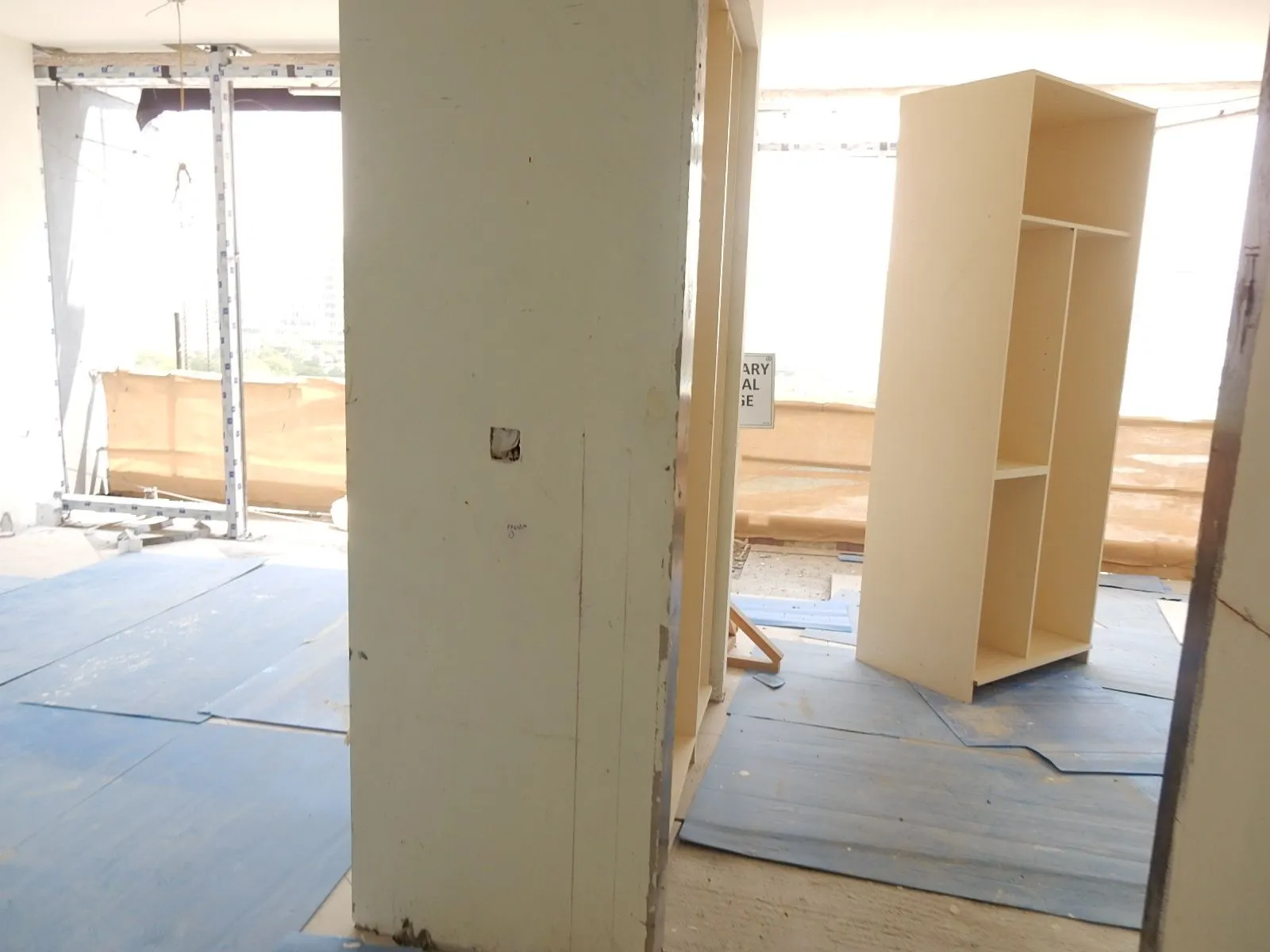

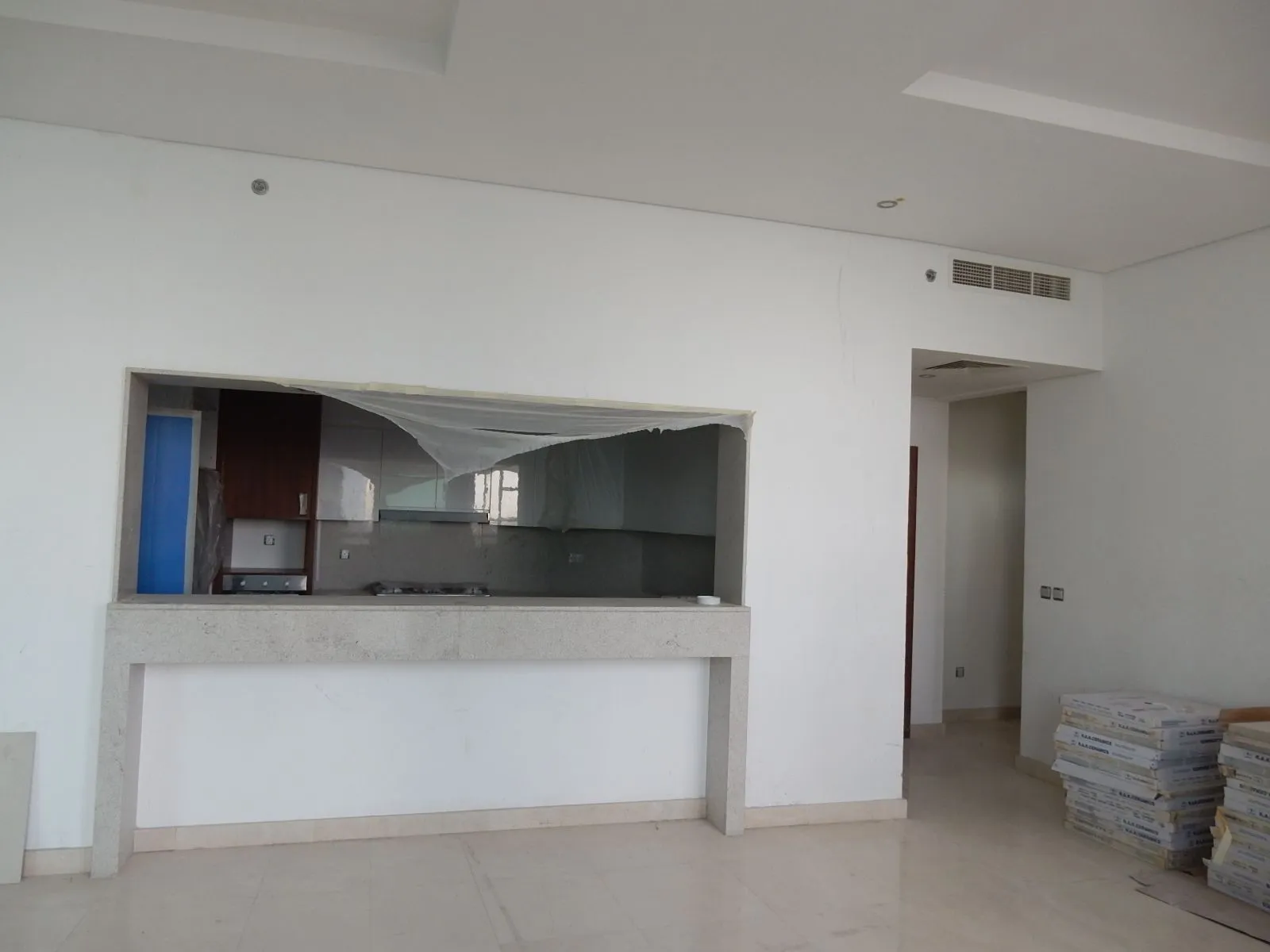

project inspections
project inspections
project inspections
project inspections
project inspections
project inspections
project inspections
project inspections
project inspections
project inspections
project inspections

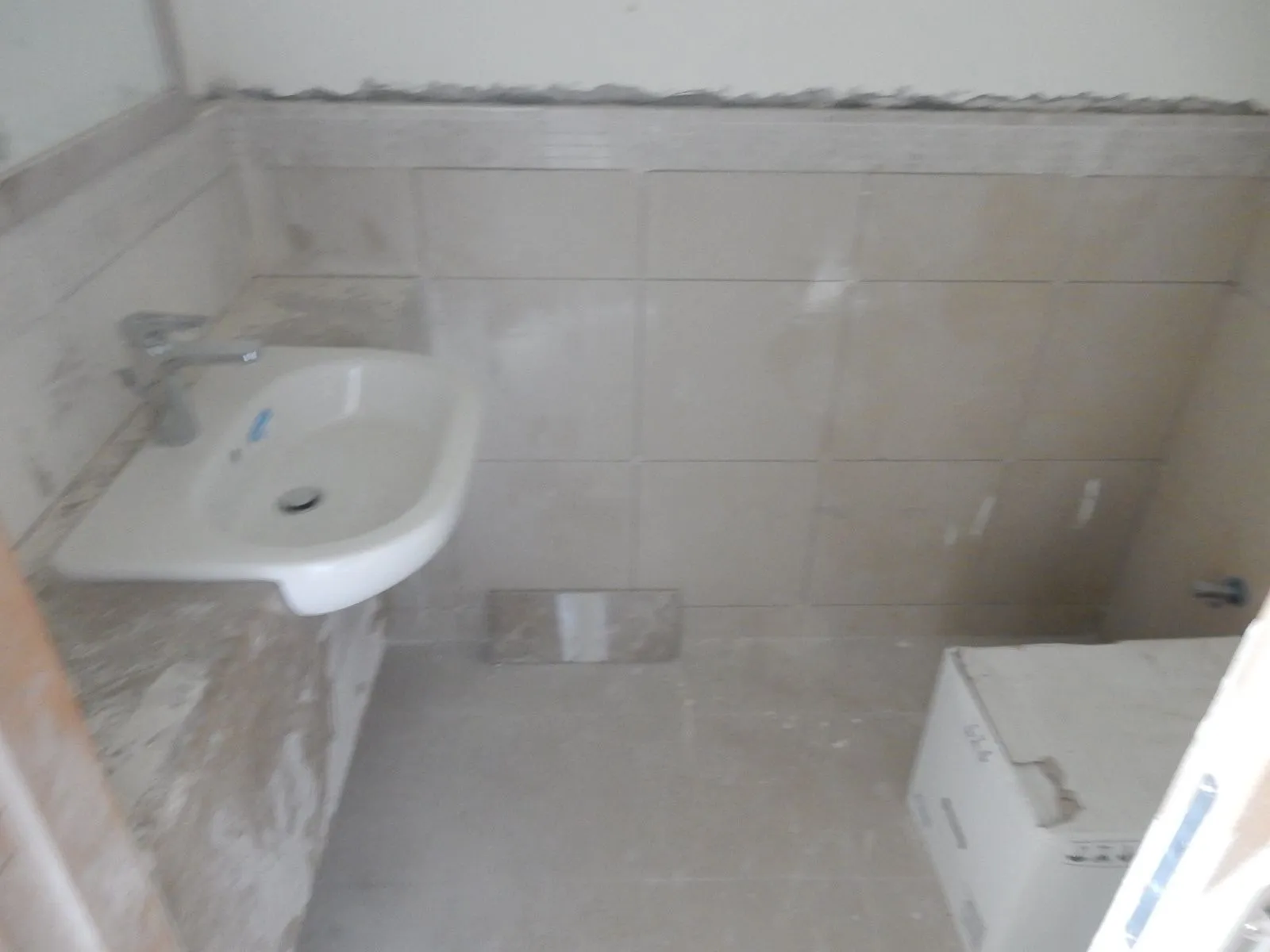

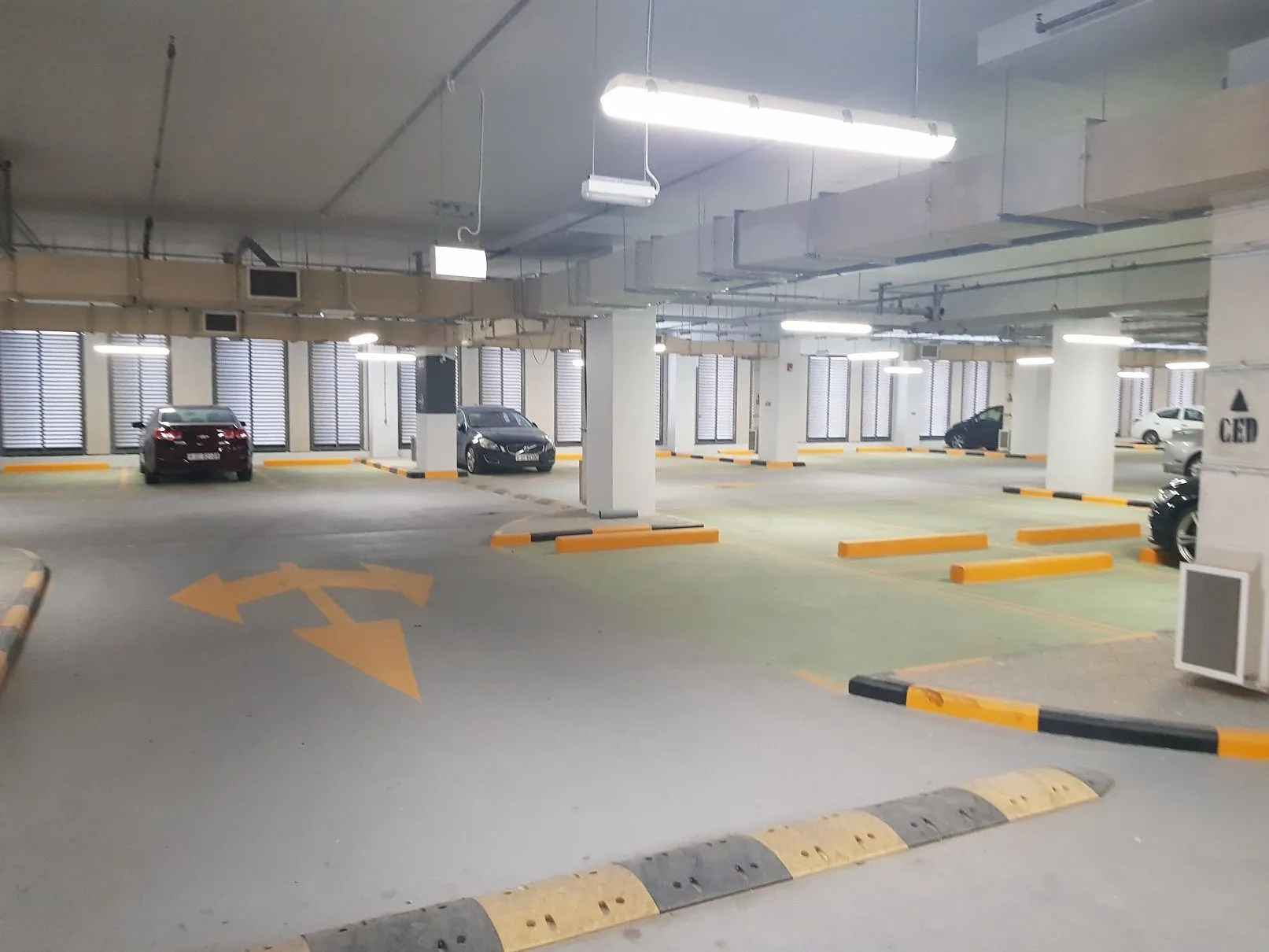

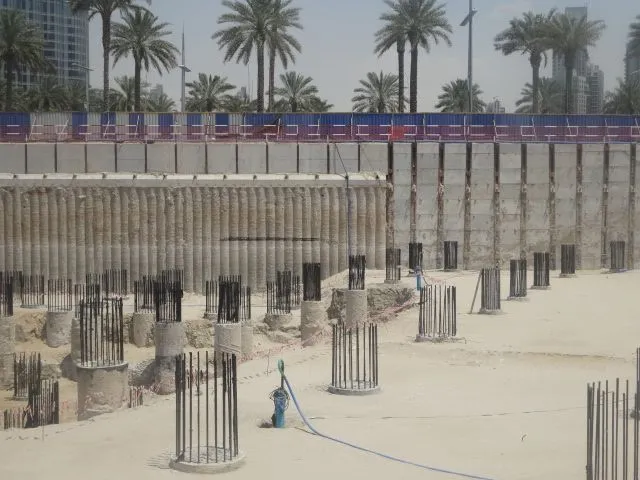

December 7, 2017
Readiness: 88.18%

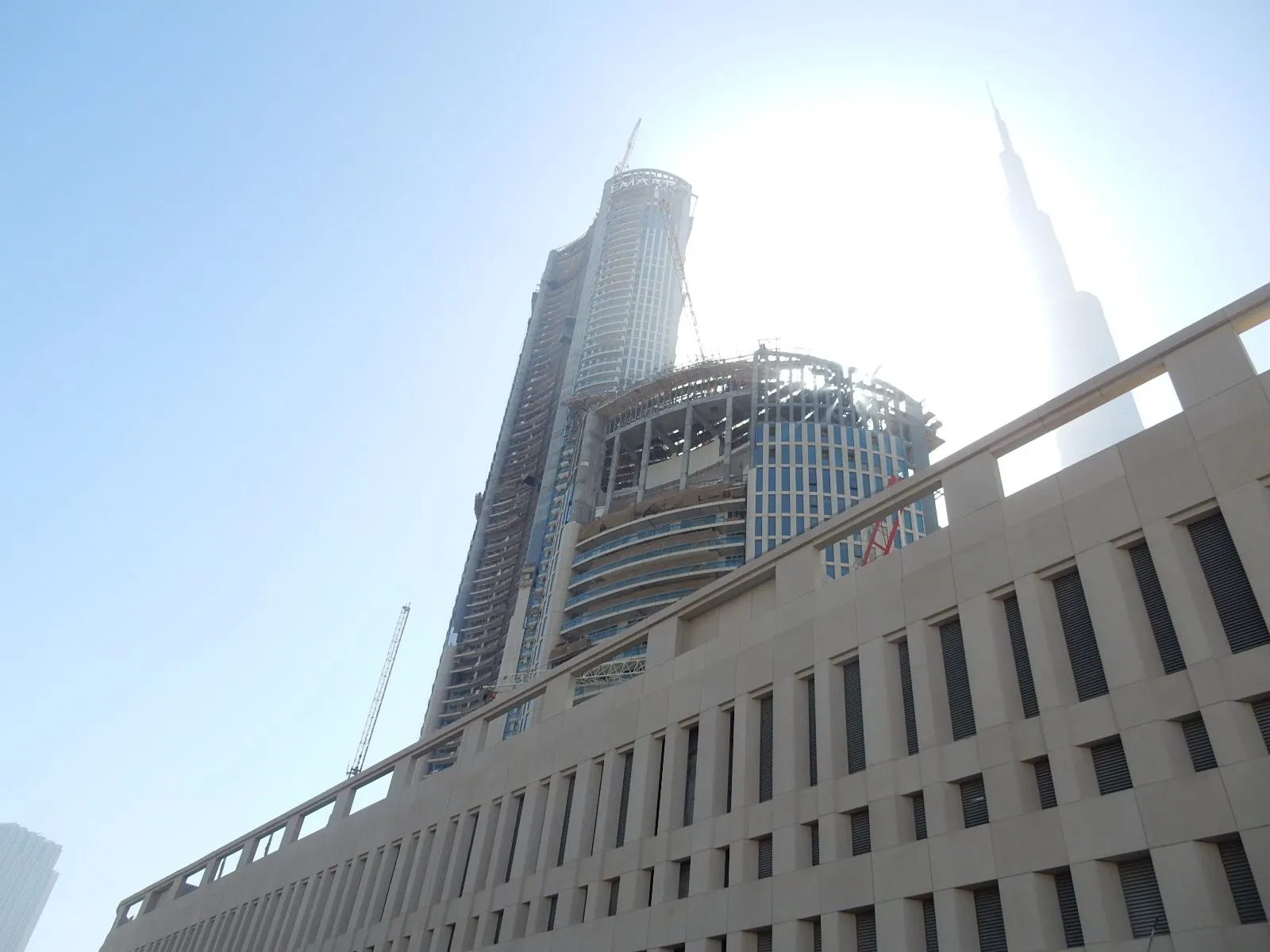

Construction progress of the project "Burj Vista" dated December 7, 2017

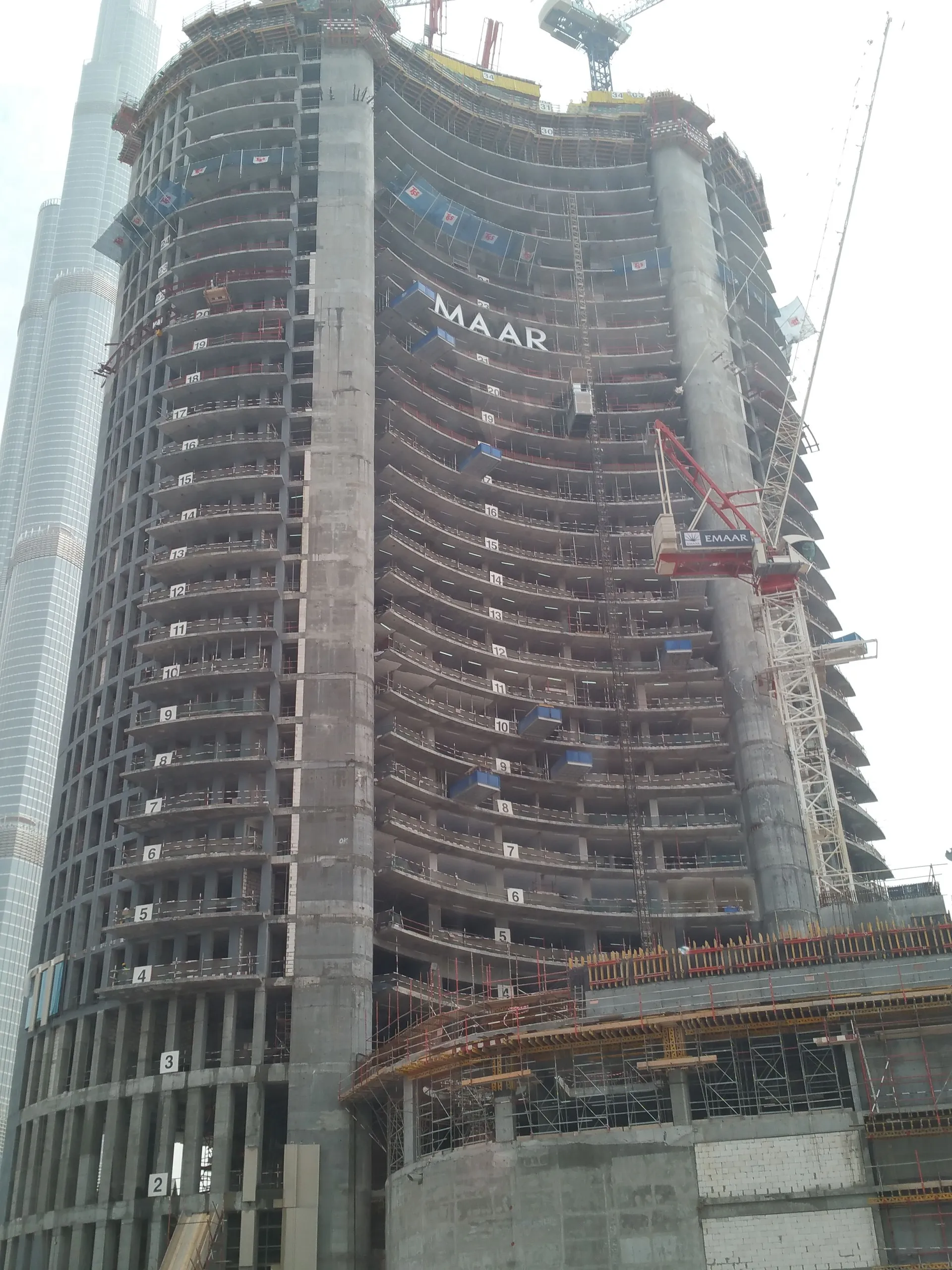

project inspections
project inspections
project inspections
project inspections
project inspections
project inspections

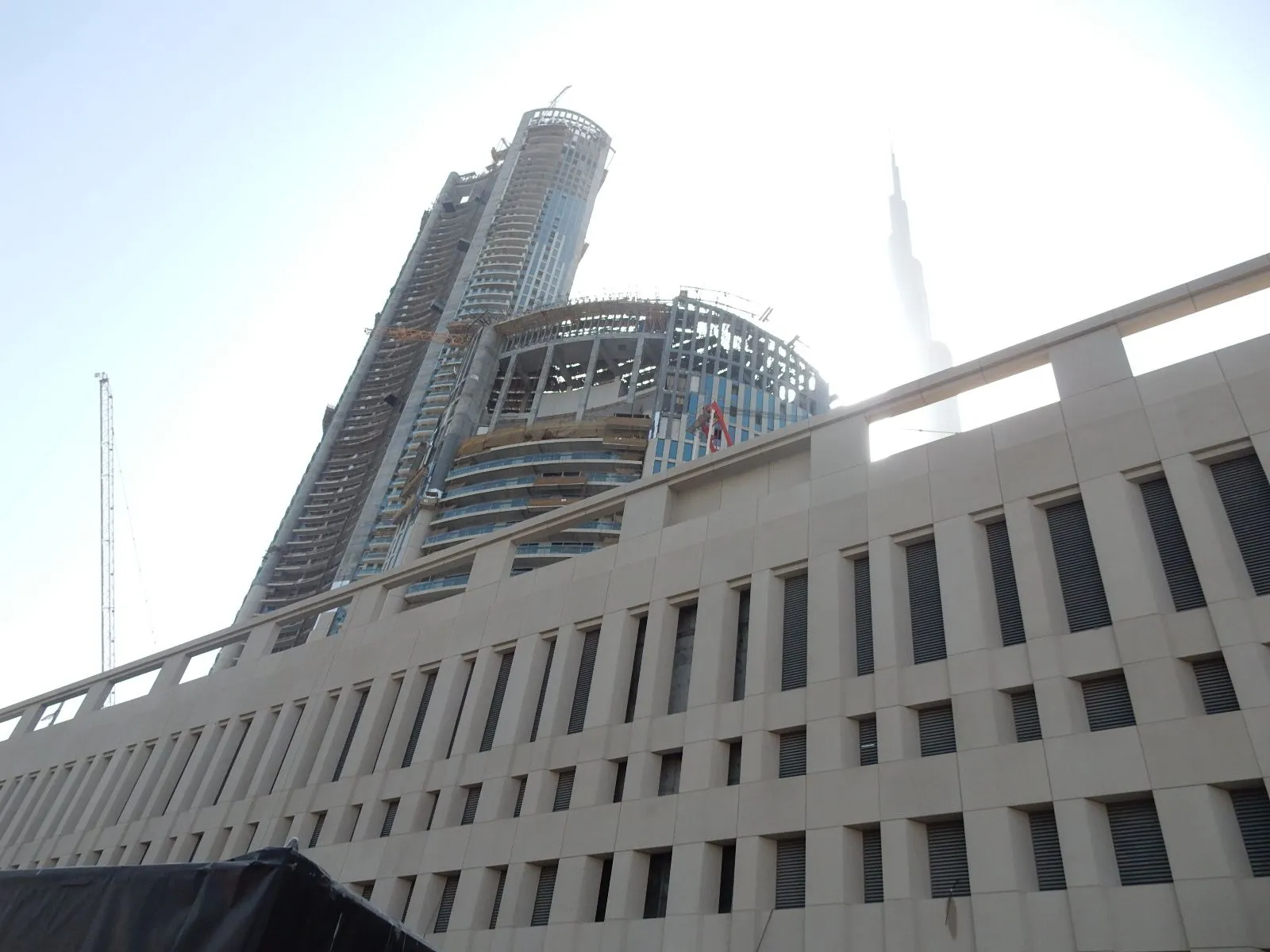

August 20, 2017
Readiness: 85.74%
Construction progress of the project "Burj Vista" dated August 20, 2017

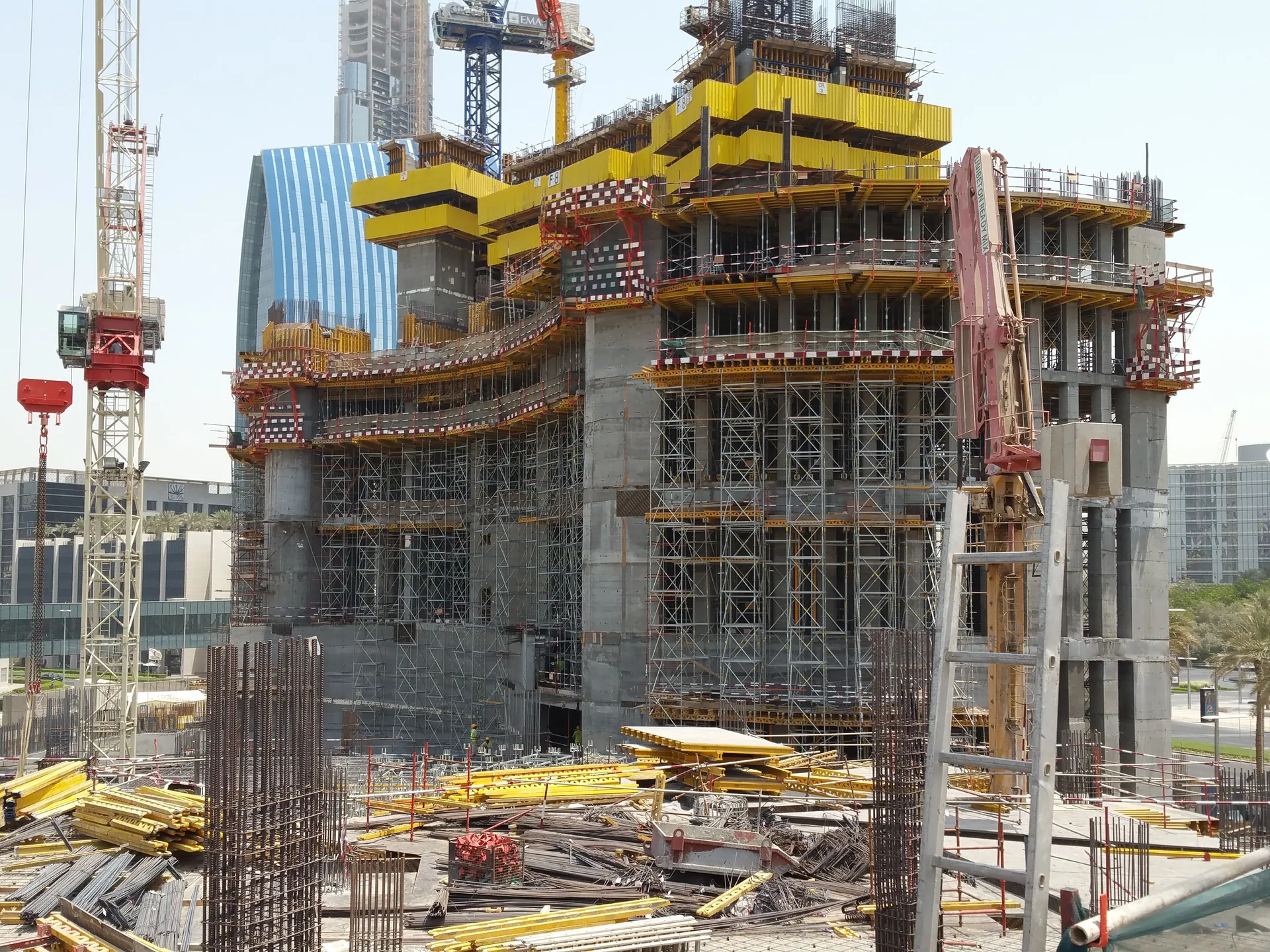

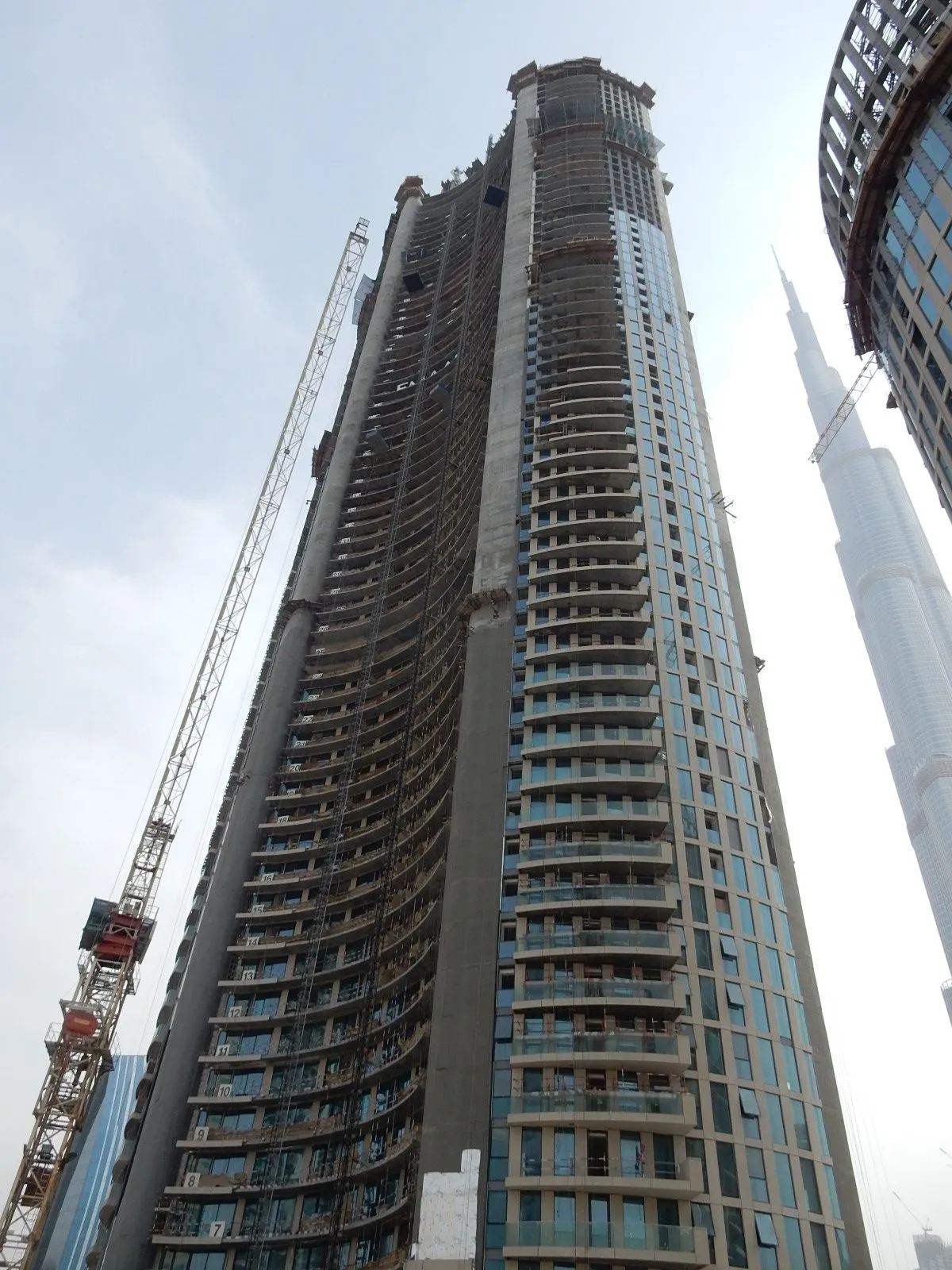

project inspections
project inspections
project inspections
project inspections
project inspections
project inspections
project inspections
project inspections

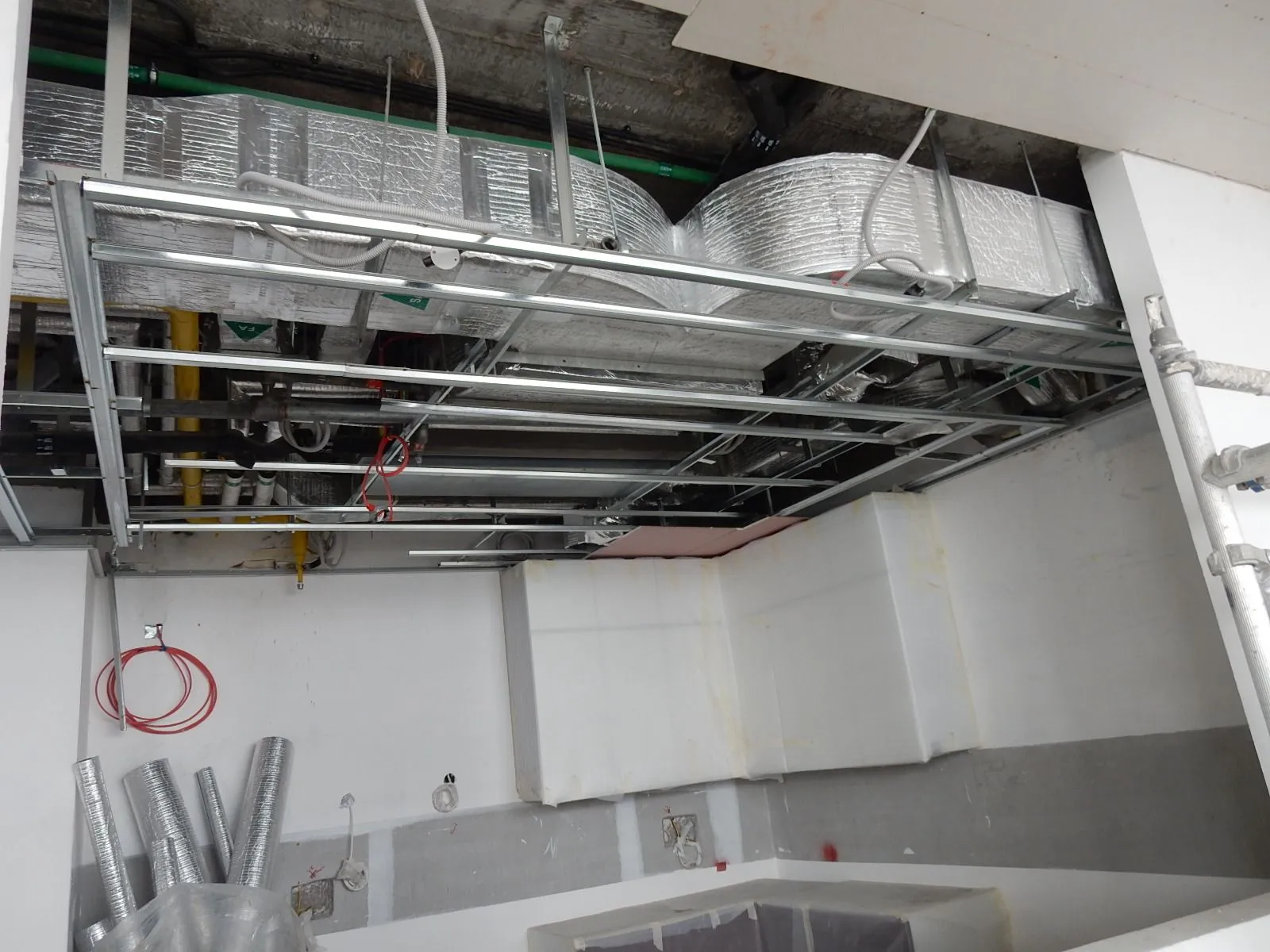

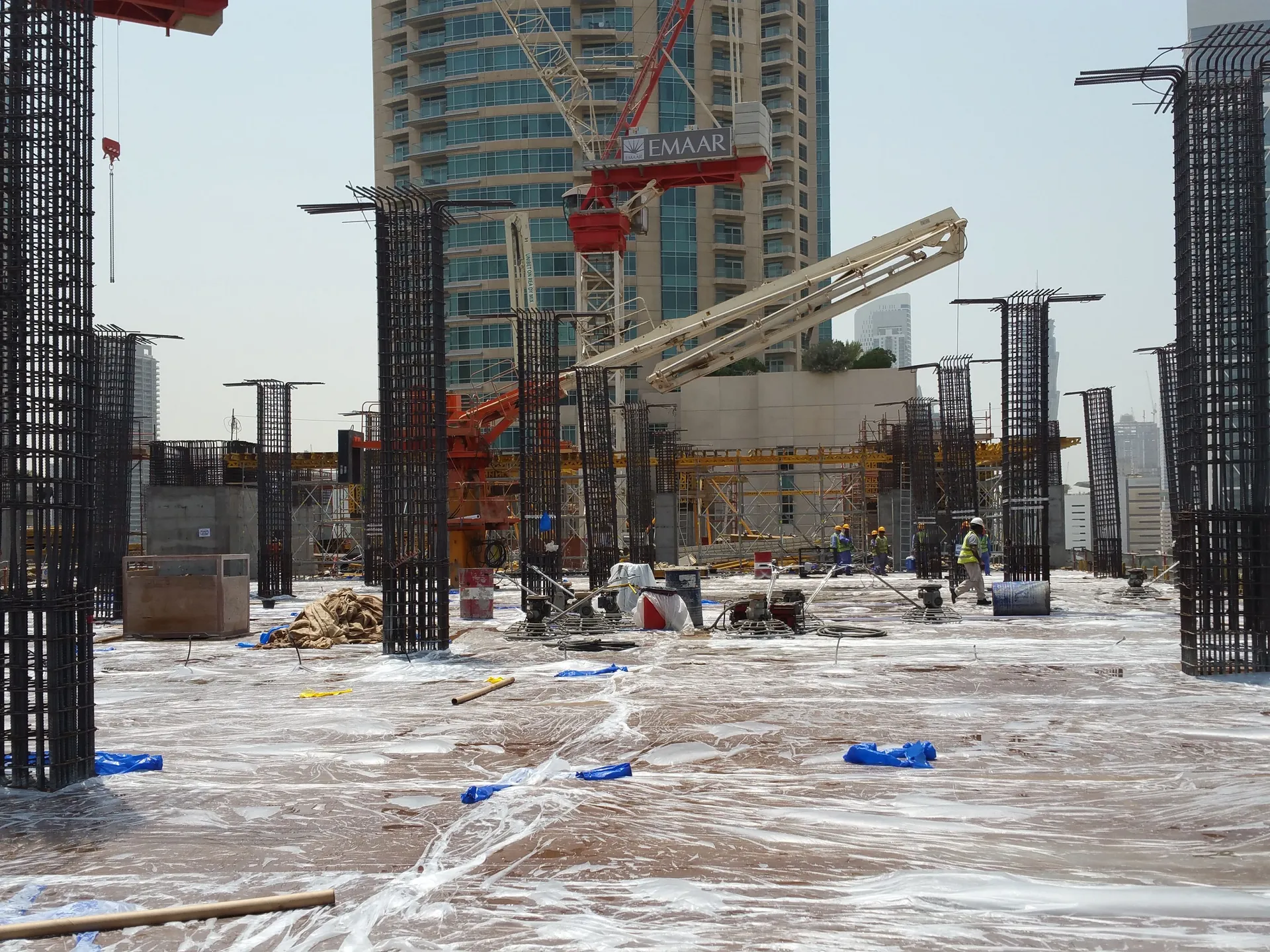

May 29, 2017
Readiness: 81.52%

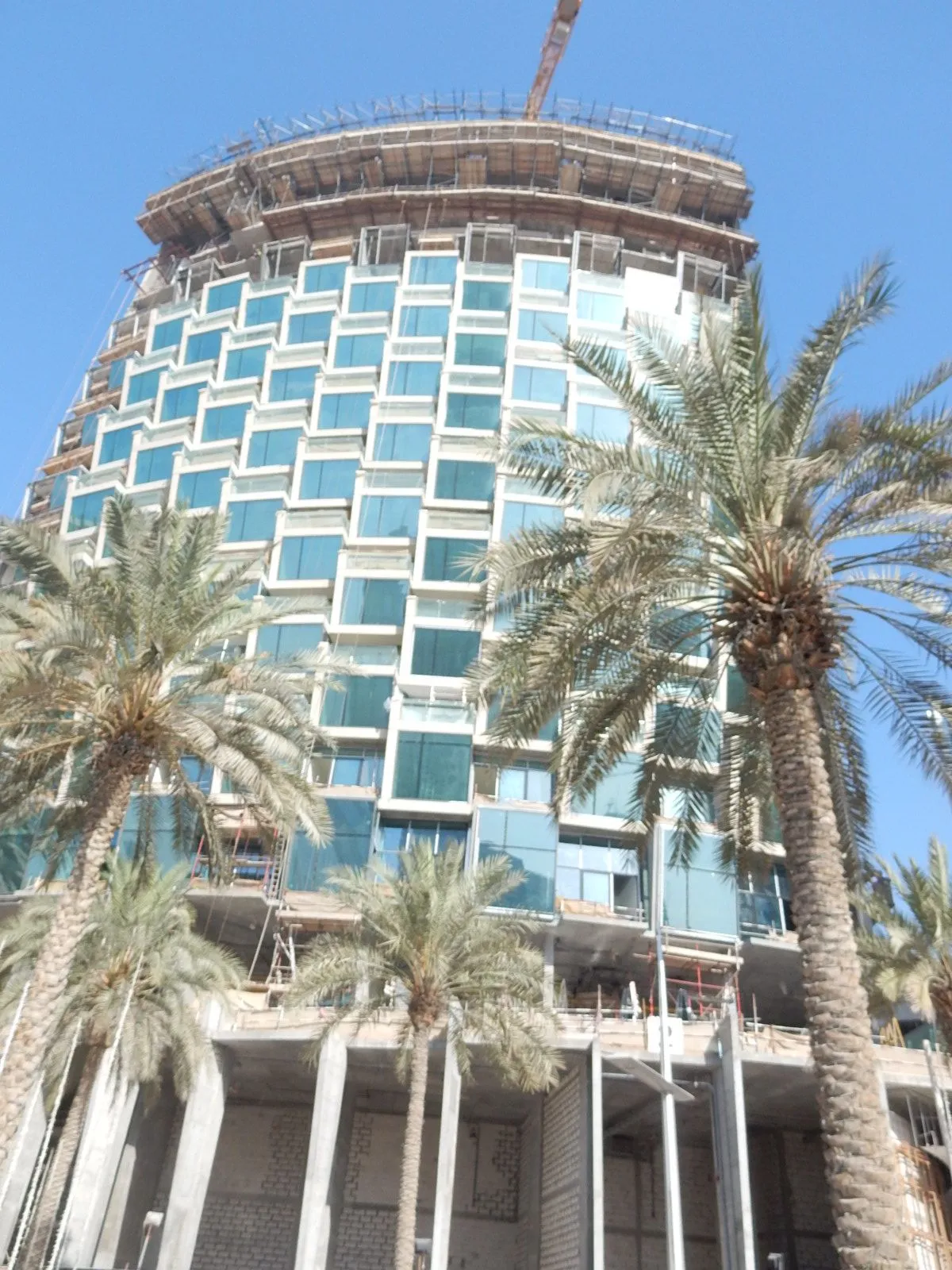

Construction progress of the project "Burj Vista" dated May 29, 2017

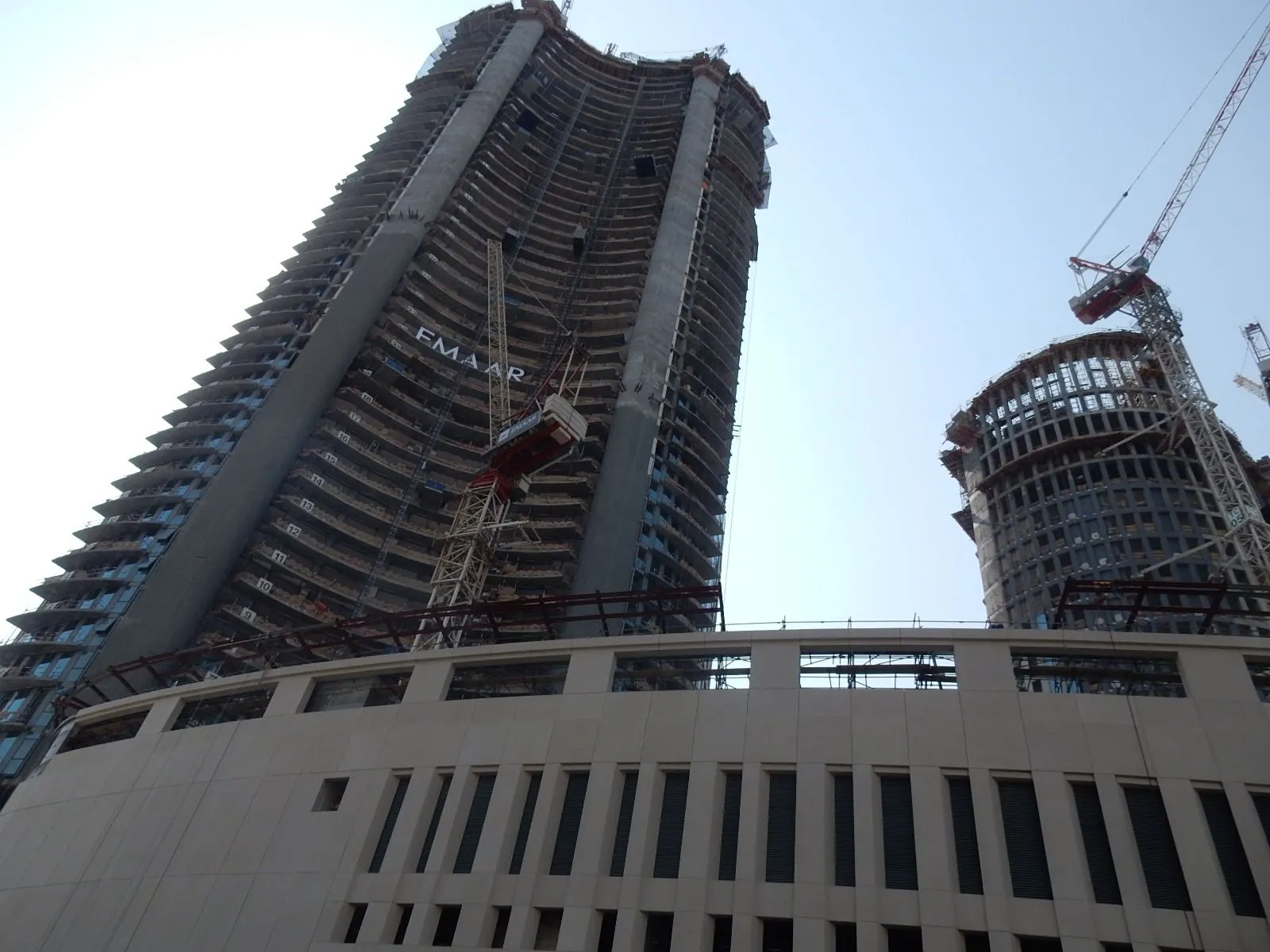

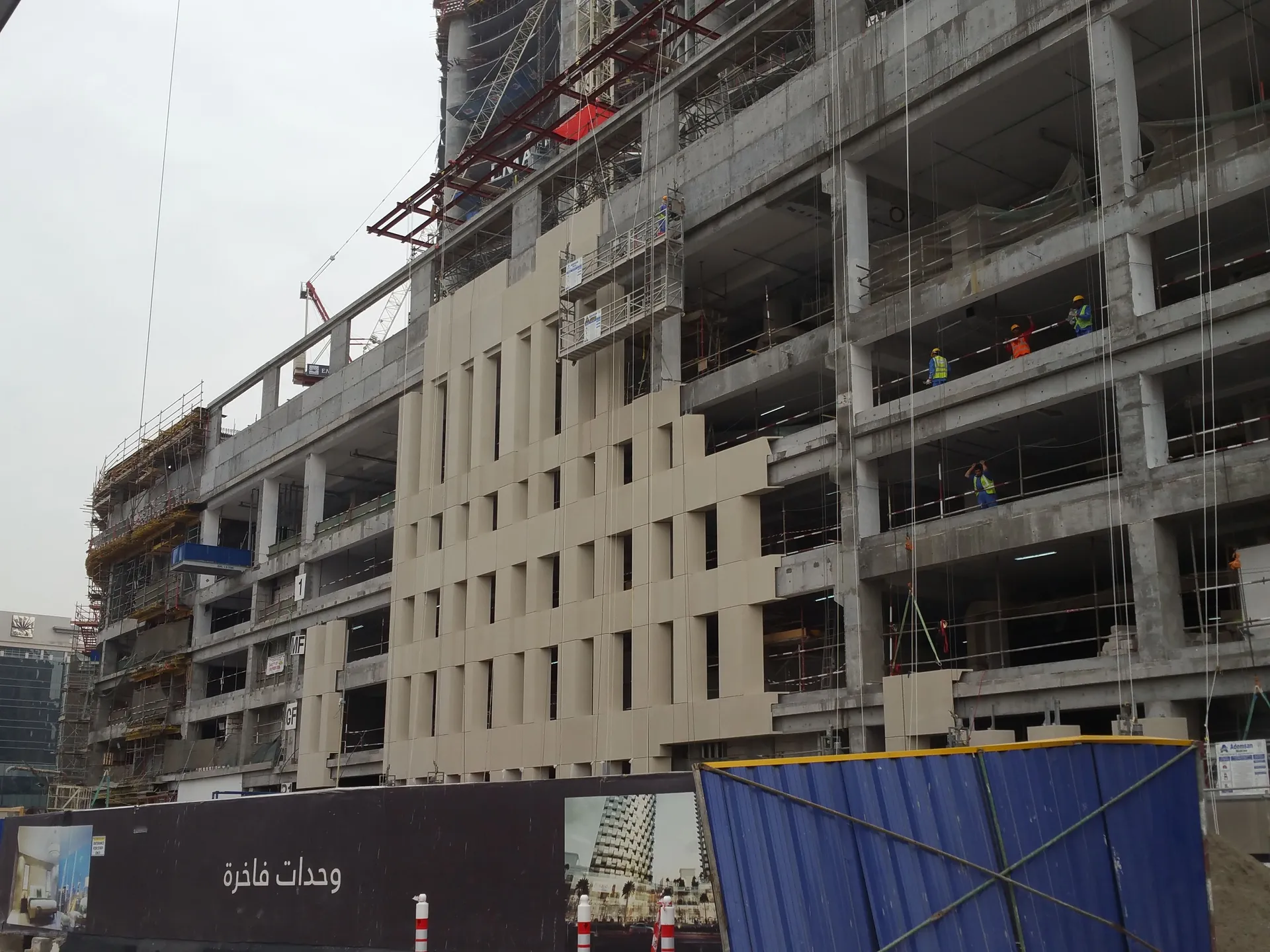

project inspections
project inspections
project inspections
project inspections
project inspections
project inspections
project inspections
project inspections

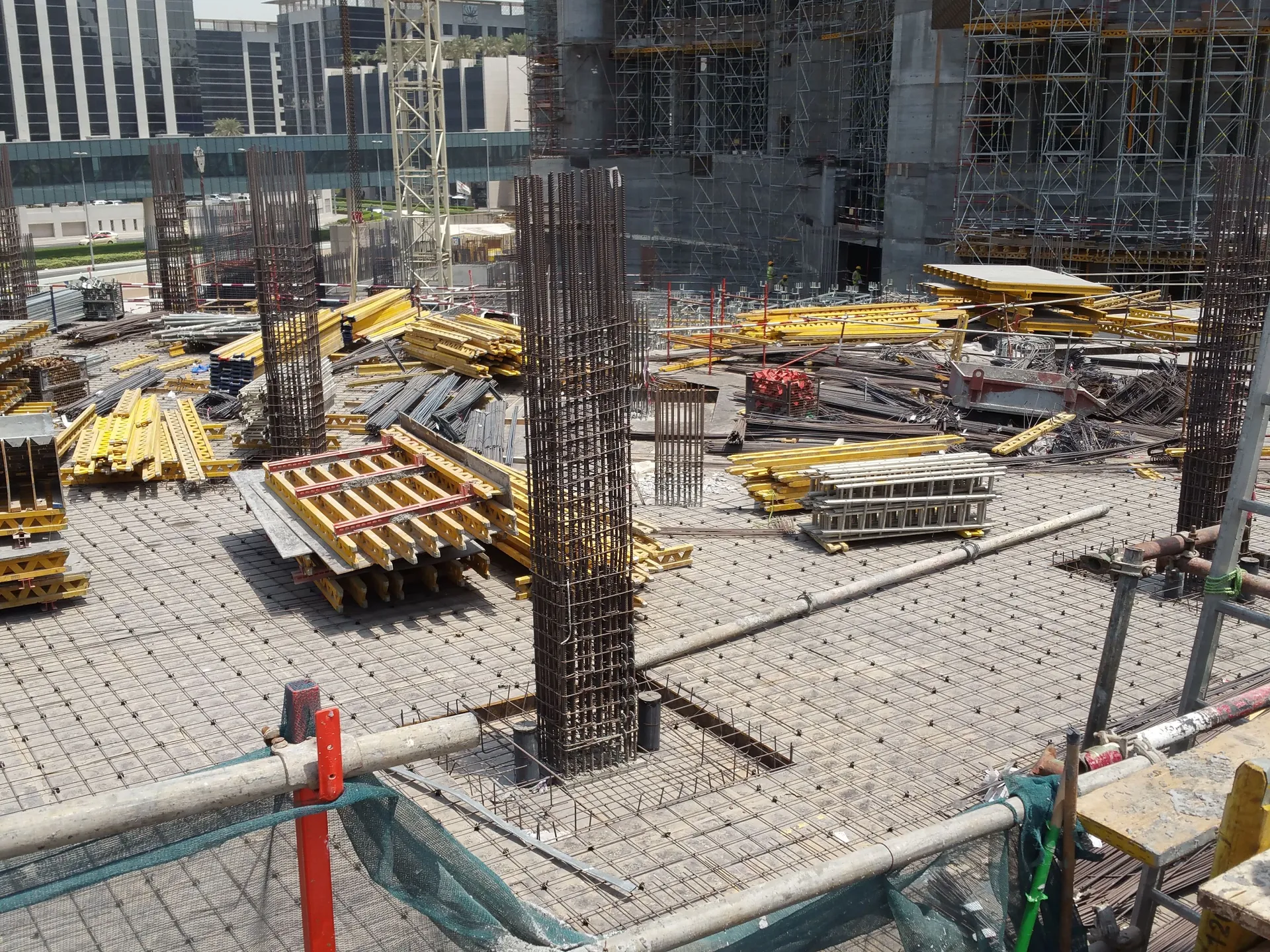

April 30, 2017
Readiness: 80.44%
Construction progress of the project "Burj Vista" dated April 30, 2017

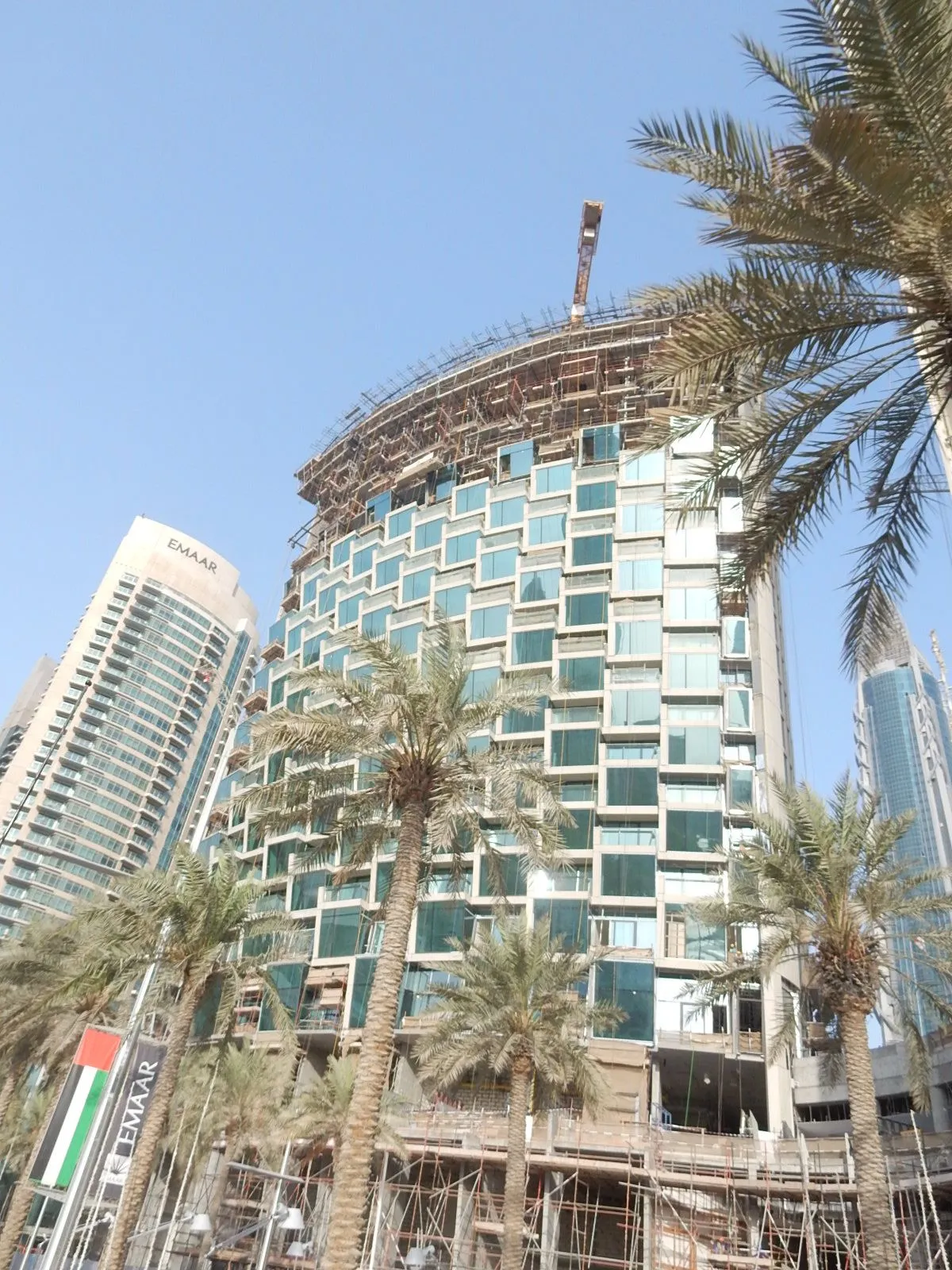

project inspections
project inspections
project inspections
project inspections
project inspections
project inspections
project inspections
project inspections
project inspections
project inspections

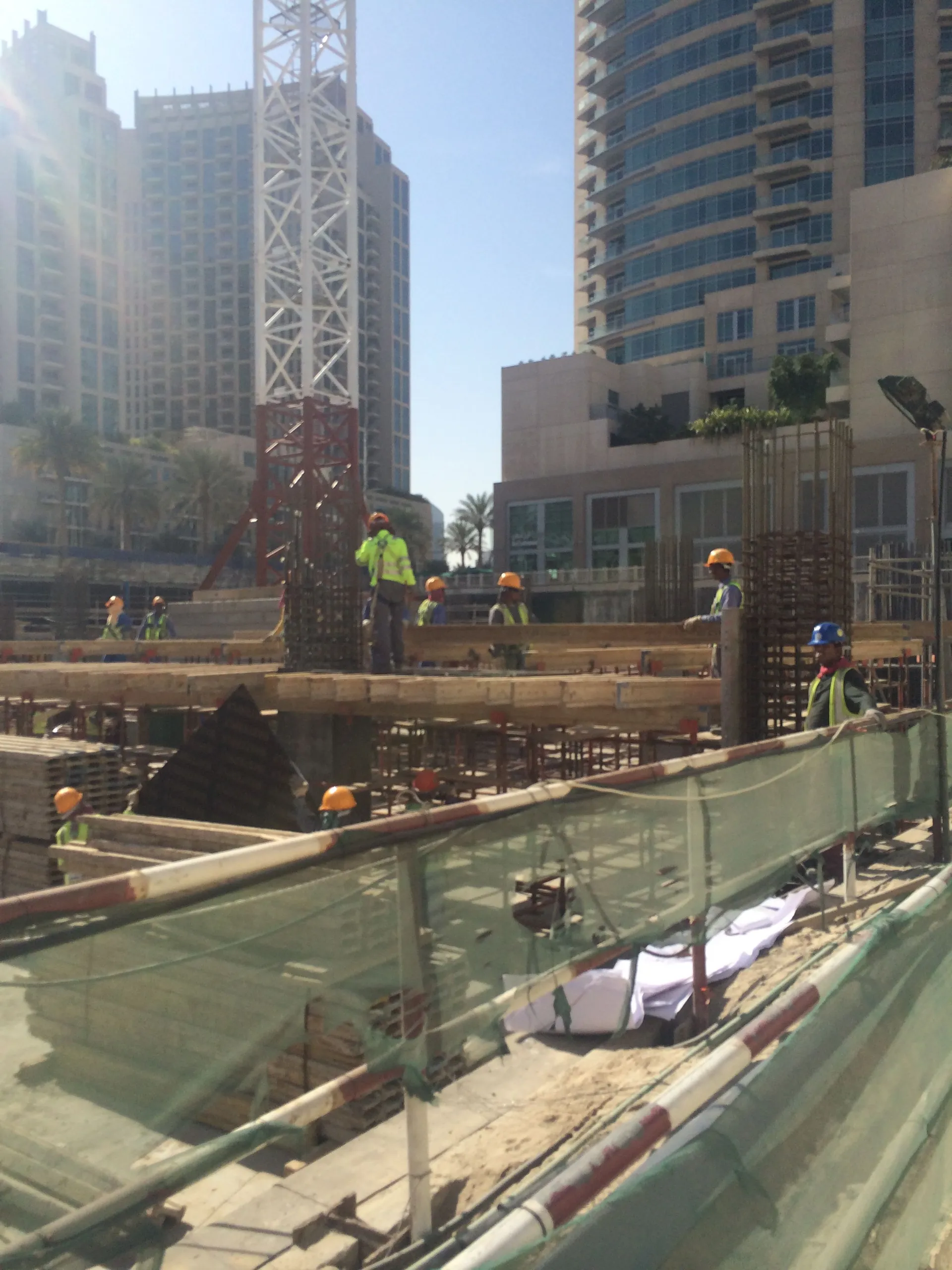

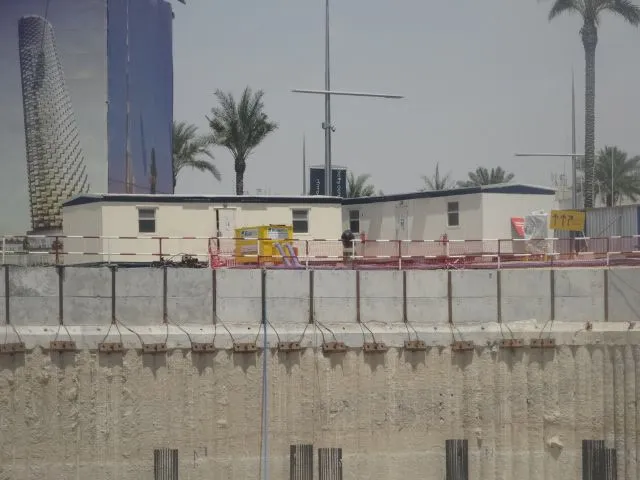

January 23, 2017
Readiness: 71.04%
Construction progress of the project "Burj Vista" dated January 23, 2017

project inspections
project inspections
project inspections
project inspections
project inspections
project inspections
project inspections
project inspections

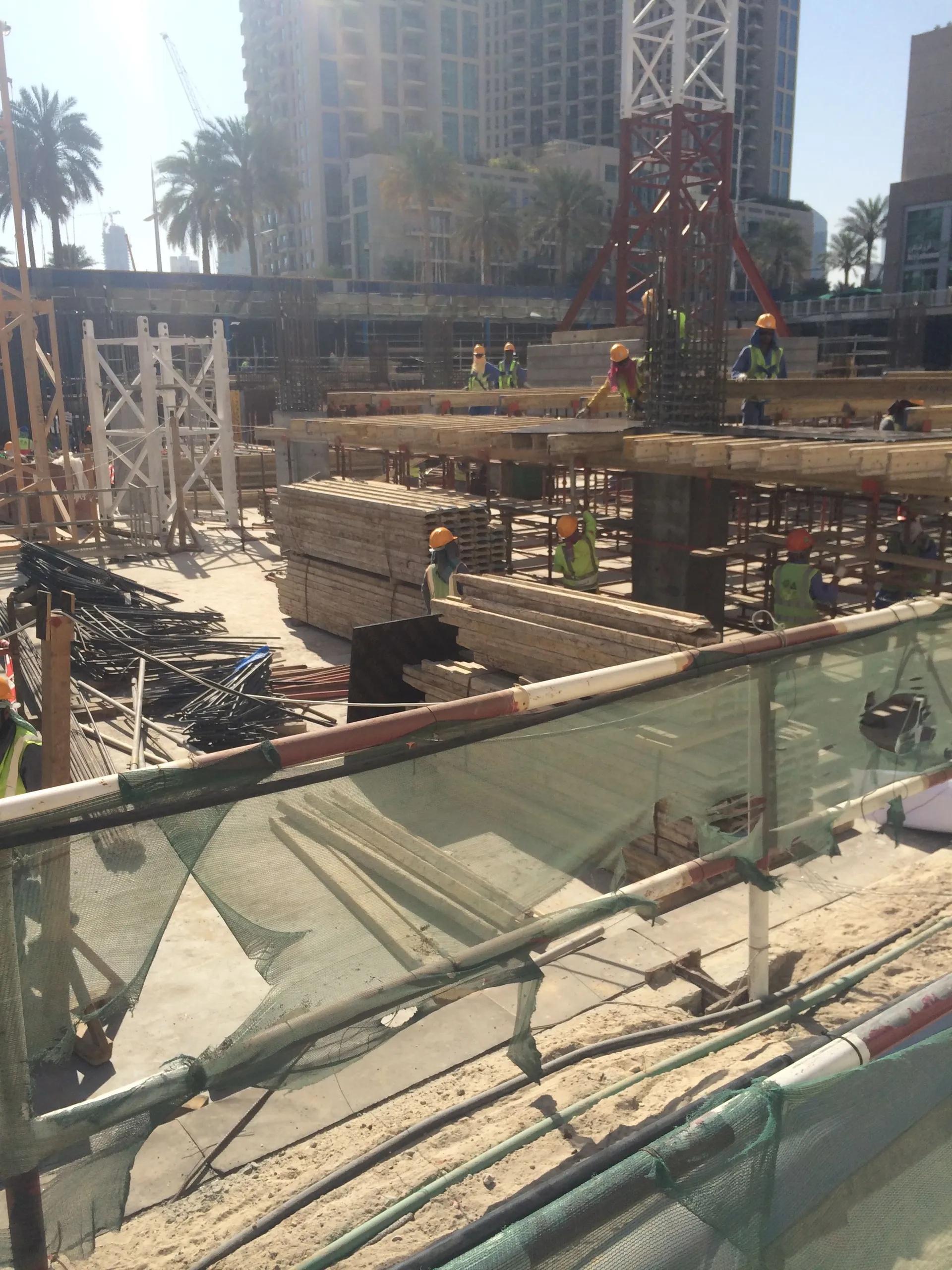

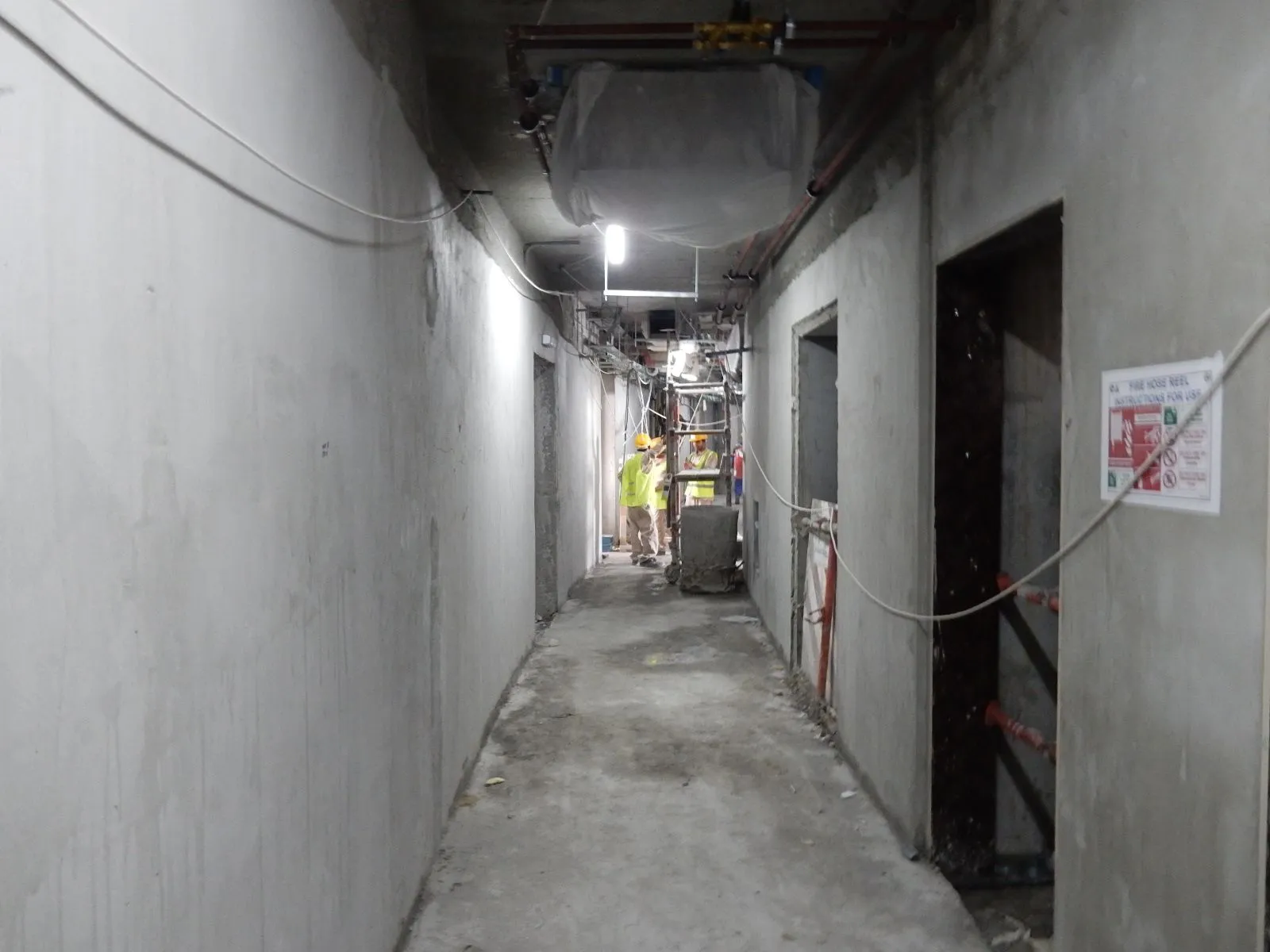

September 5, 2016
Readiness: 60.41%
Construction progress of the project "Burj Vista" dated September 5, 2016

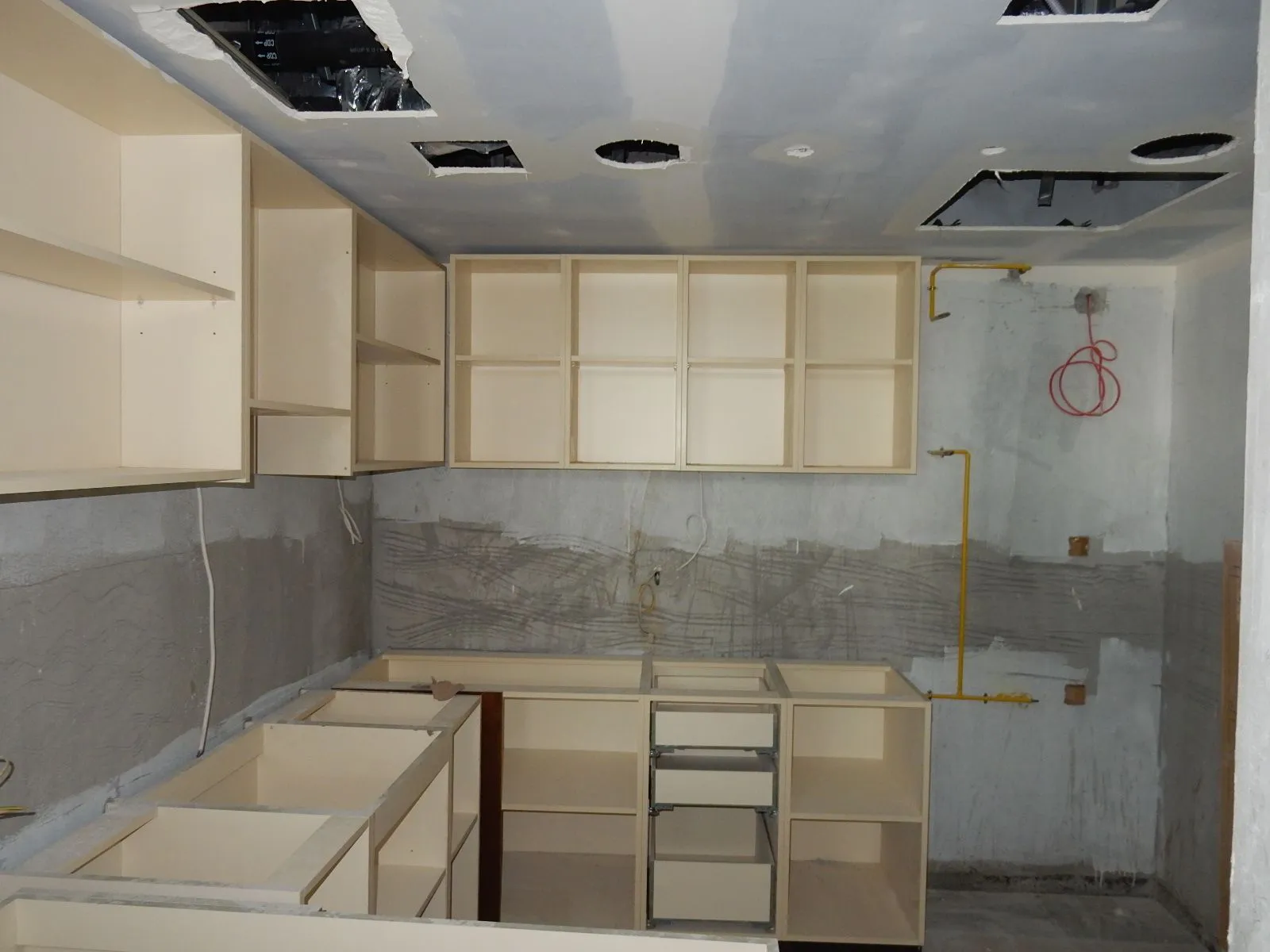

project inspections
project inspections
project inspections
project inspections
project inspections
project inspections
project inspections
project inspections
project inspections
project inspections
project inspections

March 31, 2016
Readiness: 40.39%
Construction progress of the project "Burj Vista" dated March 31, 2016

project inspections
project inspections
project inspections
project inspections
project inspections
project inspections
project inspections
project inspections

August 31, 2015
Readiness: 22.49%
Construction progress of the project "Burj Vista" dated August 31, 2015

project inspections
project inspections
project inspections
project inspections
project inspections

February 12, 2015
Readiness: 19.1%
Construction progress of the project "Burj Vista" dated February 12, 2015

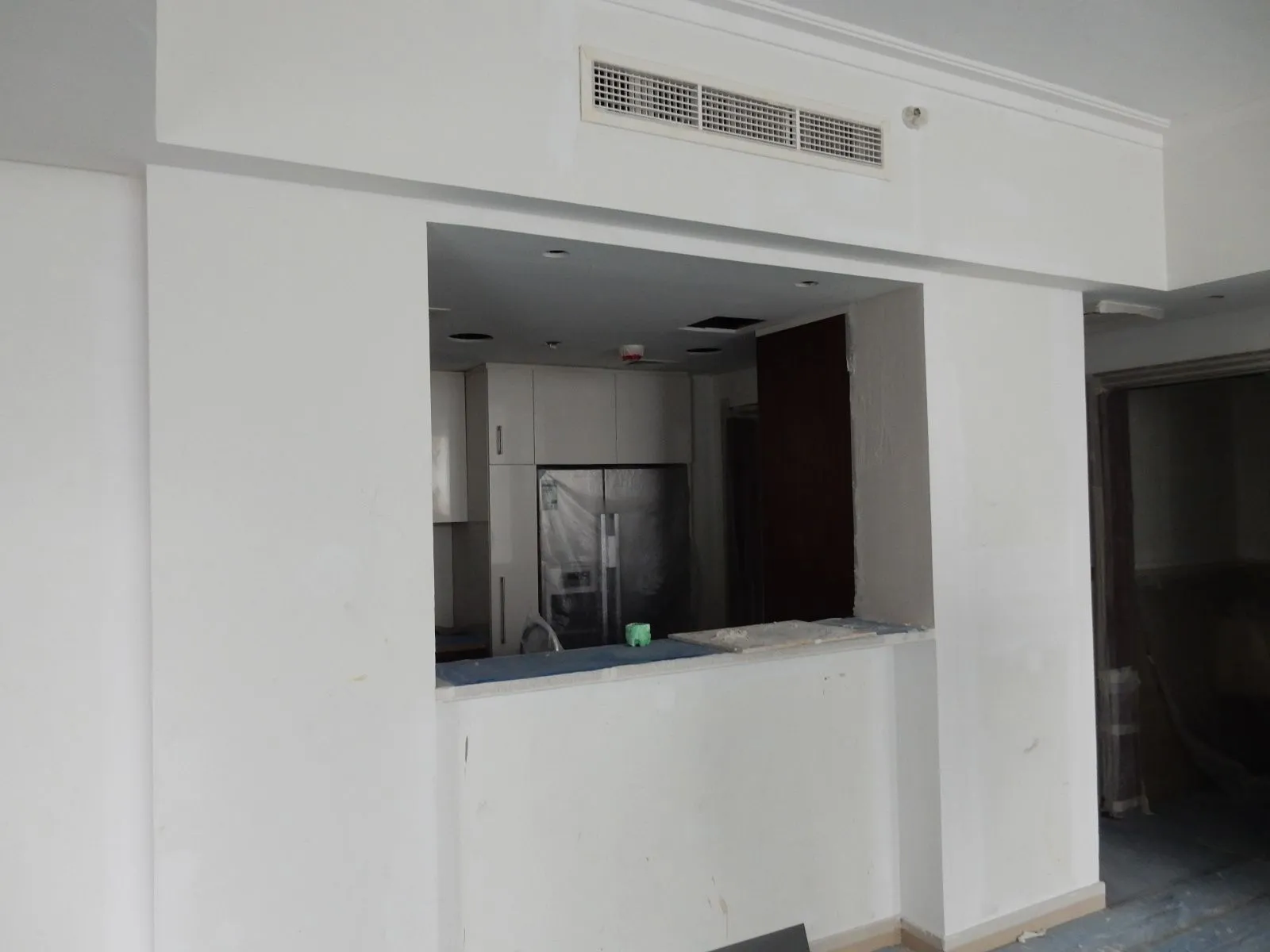

project inspections
project inspections
project inspections
project inspections

May 22, 2014
Readiness: 6.85%
Construction progress of the project "Burj Vista" dated May 22, 2014

project inspections
project inspections
project inspections
project inspections
project inspections
project inspections
Frequently Asked Questions

Price on demand
Delivery: Q2 2017
Developer: Emaar Properties
Quick consultation
Fill out the form and we will contact you shortly.
By using the service, you agree to our Terms of Service and Privacy Policy.

We value your feedback!

Help us improve by sharing your thoughts and experiences.

Realmond LogoHome

Unlock Your Dream Home with Us!

office 702, Emaar Square 6, Burj Khalifa Community, Dubai, UAE

By using the service, you agree to our Terms of Service and Privacy Policy.

© 2025 Realmond Real Estate. All rights reserved.
